Job No.: TCS00694/13 |
|
|
||
|
|
|
|
|
||
|
|
Agreement No. CE 45/2008
(CE) Liantang/Heung Yuen Wai Boundary Control Point
and Associated Works |
|
|
||
|
|
|
|
|
||
|
|
41st Quarterly Environmental Monitoring & Audit Summary Report ¡V (August
to October 2023) |
|
|
||
|
|
Prepared
For |
|
|
||
|
|
Civil Engineering and Development Department (CEDD) |
|
|
||
Quality Index |
|||
Date |
Reference No. |
Prepared By |
Certified By |
22 January 2024 |
TCS00694/13/600/R2860v2 |
|
|
Nicola
Hon (Environmental Consultant) |
T.W. Tam (Environmental Team Leader) |
Version |
Date |
Description |
1 |
21 December 2023 |
First
Submission |
2 |
22 January 2024 |
Amended
according to IEC¡¦s comments |
|
|
|
|
|
|
This
report has been prepared by Action-United Environmental Services &
Consulting with all reasonable skill, care and diligence within the terms of
the Agreement with the client, incorporating our General Terms and Conditions
of Business and taking account of the resources devoted to it by agreement
with the client. We disclaim any responsibility to the client and others in
respect of any matters outside the scope of the above. This report is
confidential to the client and we accept no responsibility of whatsoever
nature to third parties to whom this report, or any part thereof, is made
known. Any such party relies upon the report at their own risk. |
Executive Summary
ES.01.
This is the 41st Quarterly
EM&A Summary Report for the ¡§Liantang/Heung
Yuen Wai Boundary Control Point and Associated Works¡¨ under Environmental Permit No. EP-404/2011/D (hereinafter ¡¥¡¥the EP¡¦¡¦), covering the period from 1 August 2023 to 31 October 2023
(hereinafter ¡§Reporting Period¡¨).
ES.02. In the
Reporting Period, the construction works under Liantang/Heung Yuen Wai
Boundary Control Point and Associated Works Contract 6. Environmental monitoring activities
under the EM&A programme in the Reporting Period are summarized in the
following table.
Environmental Aspect |
Monitoring
Parameters / Inspection |
Reporting Period |
|
Monitoring Locations
/ Contracts |
Total Occasions |
||
Air Quality |
1-hour TSP |
6 (#) |
294 |
24-hour TSP |
6 (#) |
80 |
|
Construction Noise |
Leq(30min) Daytime |
5 (~) |
71 |
Water Quality |
Water in-situ measurement and/or sampling |
WM1 & WM1-C |
28 Scheduled |
WM2A(a) & WM2A-Cx |
28 Scheduled |
||
WM2B & WM2B-C |
28 Scheduled |
||
WM3x &WM3-C |
28 Scheduled |
||
Joint Site Inspection / Audit |
ET and the Contractor joint site Environmental
Inspection and Auditing |
Contract 6 |
13 |
ET, the Contractor, IEC and RE joint site
Environmental Inspection and Auditing |
3 |
Remark:
(*) Water
sampling was unable to carry
out at WM3-C, WM2B
and WM2B-C in the Reporting Period due to shallow water. Besides,
WM1-C was also unable to carry out at some of the monitoring days in the
Reporting Period due to shallow water. (Water depth under 150mm). WM4, WM4-CA
and WM4-CB were ceased after last monitoring carried out on 3 May 2021
according to Partial Termination Proposal for Contract 3 approved by EPD on 4
May 2021.
(#)
Number of air monitoring location changed to 6 since the partial termination proposal
approved by EPD on 9 Jul 2020 and 4 May 2021. Power supply for HVS for 24-hour
TSP monitoring at Location AM3 (Ta Kwu Ling Ambulance
Depot) was suspended from 1 February 2023 due to the renovation work of Ta Kwu Ling Ambulance Depot.
(~)
Number of noise monitoring location changed to 5 since the partial termination proposal
approved by EPD on 9 Jul 2020 and 4 May 2021.
Breaches
of Action/Limit levels
ES.03. In the
Reporting Period, no exceedance was recorded for construction noise, air
quality and water quality monitoring.
The summary of exceedance for the Reporting Period is shown below.
Environmental
Aspect |
Monitoring Parameters |
Action Level |
Limit Level |
Event & Action |
||
NOE Issued |
Investigation |
Corrective Actions |
||||
Air Quality |
1-hour TSP |
0 |
0 |
0 |
-- |
-- |
24-hour TSP |
0 |
0 |
0 |
-- |
-- |
|
Construction Noise |
Leq(30min) Daytime |
0 |
0 |
0 |
-- |
-- |
Water Quality |
DO |
0 |
0 |
0 |
-- |
-- |
Turbidity |
0 |
0 |
0 |
-- |
-- |
|
SS |
0 |
0 |
0 |
Environmental
Complaint
ES.04.
No environmental
complaint was recorded in the Reporting Period.
Notification of Summons and Successful Prosecutions
ES.05. No environmental summons or successful
prosecutions were recorded in the Reporting Period.
Reporting Changes
ES.06. Construction
works for additional works at Kong Yiu Channel area was completed in May 2023,
thus no construction work and waste raised of the Projects was presented in the
Reporting Period. Updated EM&A termination proposal (Revision 2) addressing

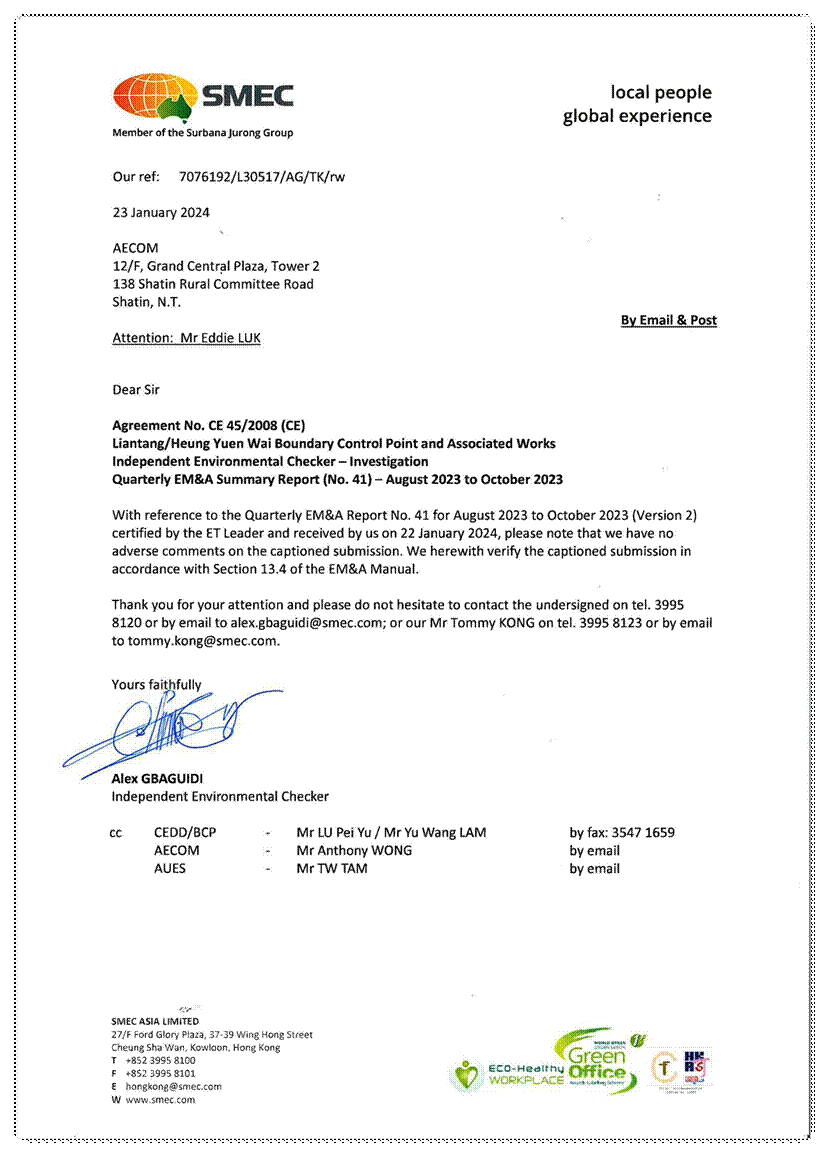

EPD¡¦s comment on 28 July 2023 was certified by ET
and verified by IEC in August 2023 and the proposal was submitted to EPD by
AECOM in early-September 2023. The proposal for termination of construction
phase EM&A programme for Contract 6 and entire Project was approved by EPD
on 31 October 2023 (EPD letter reference: ( ) in Ax(3) to EP2/N7/A52 Pt.19
dated 31 October 2023. Thus, this
is the last Quarterly EM&A Report for the Project.
Future key issues
ES.07. As construction work of the Project was
completed in May 2023, thus no adverse environmental issue arising from the
Project is foreseen in the future.
ES.08. The
proposal for termination of construction phase EM&A
programme for Contract 6 and entire Project was approved by EPD on 31 October
2023. The Contractor was
reminded to implement the mitigation measure for the Operation Phase as
stipulated in the EP and the approved EIA Report.
Table of Contents
2 Project Organization and
Construction progress
2.1 Construction
Contract Packaging
2.5 Summary of Environmental Submissions
3 Project Organization and
Construction progress
3.4 Monitoring
Frequency and Period
3.8 Derivation
of Action/Limit (A/L) Levels
3.9 Data
Management and Data QA/QC Control
4.2 Summary
of Monitoring Results
5 Construction Noise
Monitoring
5.2 Summary
of Monitoring Results
6.2 Summary
of Monitoring Results
7.1 Monitoring on Woodland Compensation
7.2 Monitoring on Wetland Compensation
10 Non-compliance, Complaints,
Notifications of Summons and Prosecutions
10.1 Status
of Non-compliance Environmental Complaint, Summons and Prosecution
11 Implementation Status of Mitigation
Measures
12 Conclusions and Recommendations
List
of tables
Table 2-1 Status
of Environmental Licenses and Permits of the Contracts
Table 3-1 Summary
of EM&A Requirements
Table 3-2 Impact
Monitoring Stations - Air Quality
Table 3-3 Impact
Monitoring Stations - Construction Noise
Table 3-4 Impact
Monitoring Stations - Water Quality
Table 3-5 Air
Quality Monitoring Equipment
Table 3-6 Construction
Noise Monitoring Equipment
Table 3-7 Water
Quality Monitoring Equipment
Table 3-8 Action
and Limit Levels for Air Quality Monitoring
Table 3-9 Action
and Limit Levels for Construction Noise
Table 3-10 Action
and Limit Levels for Water Quality
Table 4-1 Summary
of Air Quality Monitoring Results
Table 4-2 Summaries
of Breaches of Air Quality A/L Levels
Table 5-1 Summary
of Construction Noise Monitoring Results
Table 5-2 Summaries
of Breaches of Construction Noise A/L Levels
Table 6-1 Summary
of the Water Quality Monitoring Results ¡V Contracts 6
Table 6-2 Summary
of the Water Quality Monitoring Results ¡V Contract 6
Table 6-3 Summary
of the Water Quality Monitoring Results ¡V Contracts 6
Table 6-4 Summaries
of Breaches of the Existing Water Quality A/L Levels
Table 9-2 Summary
of Reminders/Observations of Site Inspection ¡V Contract 6
Table 10-1 Statistical
Summary of Environmental Complaints
Table 10-2 Statistical
Summary of Environmental Summons
Table 10-3 Statistical
Summary of Environmental Prosecution
List of Annexes
Appendix A Layout plan of the Project
Appendix B Environmental Management
Organization Chart
Appendix C Designated Monitoring
Locations as Recommended in the Approved EM&A Manual
Appendix D Monitoring Locations for
Impact Monitoring
Appendix E Event and Action Plan
Appendix F Graphical Plots for Monitoring
Result
Appendix G
Weather information
Appendix H
Implementation Schedule for Environmental Mitigation Measures
Appendix I Implementation Status of
mitigation measures for Operation Phase
Appendix J Complaint LOG
1.1.1. Civil Engineering and
Development Department is the Project
Proponent and the Permit Holder of Agreement No. CE 45/2008 (CE) Liantang /
Heung Yuen Wai Boundary Control Point and Associated Works, which is
a Designated Project to be implemented under Environmental Permit number EP-404/2011/C granted on 12 March
2015 and the latest Environmental Permit
number EP-404/2011/D granted on 20 January 2017.
1.1.2. The Project consists of two main
components: Construction of a Boundary Control Point (hereinafter referred as
¡§BCP¡¨); and Construction of a connecting road alignment. Layout plan of the Project is shown in Appendix A.
1.1.3. The proposed BCP is located at the
boundary with Shenzhen near the existing Chuk Yuen Village, comprising a main
passenger building with passenger and cargo processing facilities and the
associated customs, transport and ancillary facilities. The connecting road alignment consists
of six main sections:
1)
Lin Ma Hang to Frontier Closed Area (FCA) Boundary ¡V this section
comprises at-grade and viaducts and includes the improvement works at Lin Ma
Hang Road;
2)
Ping Yeung to Wo Keng Shan ¡V this section stretches from the Frontier
Closed Area Boundary to the tunnel portal at Cheung Shan and comprises at-grade
and viaducts including an interchange at Ping Yeung;
3)
North Tunnel ¡V this section comprises the tunnel segment at Cheung Shan
and includes a ventilation building at the portals on either end of the tunnel;
4)
Sha Tau Kok Road ¡V this section stretches from the tunnel portal at Wo
Keng Shan to the tunnel portal south of Loi Tung and comprises at-grade and
viaducts including an interchange at Sha Tau Kok and an administration
building;
5)
South Tunnel ¡V this section comprises a tunnel segment that stretches from
Loi Tung to Fanling and
includes a ventilation building at the portals on either end of the tunnel as
well as a ventilation building in the middle of the tunnel near Lau Shui Heung;
6)
Fanling ¡V this section comprises the at-grade, viaducts
and interchange connection to the existing Fanling
Highway.
1.1.4.
Action-United Environmental Services & Consulting has been commissioned as an Independent ET to implement the
relevant EM&A programme in
accordance with the approved EM&A Manual, as well as the associated duties.
1.1.5.
This is the 41st Quarterly EM&A Summary Report presenting the
monitoring results and inspection findings for the Reporting Period from 1 August
2023 to 31 October 2023.
1.2.1
The Quarterly EM&A Summary Report is structured into the following
sections:-
Section 1 Introduction
Section 2 Project Organization and
Construction progress
Section 3 Summary of Impact monitoring Requirements
Section 4 Air Quality Monitoring
Section 5 Construction Noise
Monitoring
Section 6 Water Quality Monitoring
Section 7 Ecology Monitoring
Section 8 Waste Management
Section 9 Site Inspection
Section 10 Non-compliance, Complaints, Notifications of
Summons and Prosecutions
Section 11 Implementation Status of Mitigation Measures
Section 12 Conclusions and Recommendations
2.1.1
To facilitate the project management and
implementation, the Project would be divided by the following contracts:
¡P
Contract 2 (CV/2012/08)
¡P
Contract 3 (CV/2012/09)
¡P
Contract 4 (NE/2014/02)
¡P
Contract 5 (CV/2013/03)
¡P
Contract 6 (CV/2013/08)
¡P
Contract 7 (NE/2014/03)
¡P
ArchSD Contract No. SS C505
2.1.2
The
details of each contracts is summarized below and the delineation of each contracts is shown in Appendix A.
Contract 2 (CV/2012/08)
2.1.3
Contract 2 has awarded in December 2013 and
construction work was commenced on 19 May 2014. Major Scope of Work of the Contract 2 is
listed below:
¡P
construction of
an approximately 5.2km long dual two-lane connecting road (with about 0.4km of
at-grade road and 4.8km of tunnel) connecting the Fanling
Interchange with the proposed Sha Tau Kok Interchange;
¡P
construction of a
ventilation adit tunnel and the mid-ventilation
building;
¡P
construction of
the north and south portal buildings of the Lung Shan Tunnel and their
associated slope works;
¡P
provision and
installation of ventilation system, E&M works and building services works
for Lung Shan tunnel and Cheung Shan tunnel and their portal buildings;
¡P
construction of
Tunnel Administration Building adjacent to Wo Keng Shan Road and the associated
E&M and building services works; and
¡P
construction of
associated footpath, slopes, retaining structures, drainage, sewerage,
waterworks, landscaping works and other ancillary works.
Contract 3 (CV/2012/09)
2.1.4
Contract 3 was awarded in July 2013 and
construction work was commenced on 5 November 2013. Major Scope of Work of the Contract 3 is
listed below:
¡P
construction of
four link roads connecting the existing Fanling
Highway and the south portal of the Lung Shan Tunnel;
¡P
realignment of
the existing Tai Wo Service Road West and Tai Wo Service Road East;
¡P
widening of the
existing Fanling Highway (HyD¡¦s
entrustment works);
¡P
demolishing
existing Kiu Tau vehicular bridge and Kiu Tau footbridge and reconstruction of
the existing Kiu Tau Footbridge (HyD¡¦s entrustment
works); and
¡P
construction of
associated footpath, slopes, retaining structures, drainage, sewerage,
waterworks, landscaping works and other ancillary works.
Contract 4 (NE/2014/02)
2.1.5
Contract 4 was awarded in mid-April 2016 and construction work will be
commenced on 2 May 2017. The scope
of work of the Contract 4 includes:
¡P
design,
supply, delivery, installation, testing and commissioning of a traffic control
and surveillance system for the connecting road linking up the Liantang / Heung Yuen Wai Boundary Control Point and the
existing Fanling Highway.
Contract 5 (CV/2013/03)
2.1.6
Contract 5 has awarded in April 2013 and
construction work was commenced in August 2013. Major Scope of Work of the Contract 5 is
listed below:
¡P
site formation of about 23
hectares of land for the development of the BCP;
¡P
construction of an
approximately 1.6 km long perimeter road at the BCP including a 175m long
depressed road;
¡P
associated
diversion/modification works at existing local roads and junctions including
Lin Ma Hang Road;
¡P
construction of pedestrian
subway linking the BCP to Lin Ma Hang Road;
¡P
provision of resite area with supporting infrastructure for
reprovisioning of the affected village houses; and
¡P
construction of associated
footpath, slopes, retaining structures, drainage, sewerage, waterworks,
landscaping works and other ancillary works.
Contract 6 (CV/2013/08)
2.1.7
Contract 6 was awarded in June 2015 and
construction work was commenced on 23 October 2015. Major Scope of Work of the Contract 6 would
be included below:
construction of an approximately 4.6km long dual two-lane connecting
road (with about 0.6km of at-grade road, 3.3km of viaduct and 0.7km of tunnel)
connecting the BCP with the proposed Sha Tau Kok Road Interchange and the
associated ventilation buildings;
associated diversion/modification works at access roads to the resite of Chuk Yuen Village;
provision of sewage collection, treatment and disposal facilities for
the BCP and the resite of Chuk
Yuen Village;
construction of a pedestrian subway linking the BCP to Lin Ma Hang
Road;
provisioning of the affected facilities including Wo Keng Shan Road
garden; and
construction of associated footpath, slopes,
retaining structures, drainage, sewerage, waterworks, landscaping works and
other ancillary works.
Contract 7 (NE/2014/03)
2.1.8
Contract 7 was awarded in December 2015 and
the construction work was commenced 15 February 2016. Major Scope of Work of the Contract 7 would
be included below:
construction of the Hong Kong Special
Administrative Region (HKSAR) portion of four vehicular bridge
construction of one
pedestrian bridge crossing Shenzhen (SZ) River (cross boundary bridges)
ArchSD Contract No. SS C505
2.1.9
SS C505 has been awarded in July 2015 and
construction work was commenced on 1 September 2015. Major Scope of Work of the SS C505 would
be included below:
passenger-related facilities including
processing kiosks and examination facilities for private cars and coaches,
passenger clearance building and halls, the interior fitting works for the
pedestrian bridge crossing Shenzhen River, etc.;
cargo processing facilities including kiosks
for clearance of goods vehicles, customs inspection platforms, X-ray building,
etc.;
accommodation for the facilities inside of the
Government departments providing services in connection with the BCP;
transport-related facilities inside the BCP
including road networks, public transport interchange, transport drop-off and
pick-up areas, vehicle holding areas and associated road furniture etc;
a public carpark; and
other ancillary facilities such as sewerage
and drainage, building services provisions and electronic systems, associated
environmental mitigation measure and landscape works.
2.2.1
The project organization is shown in Appendix B. The responsibilities of respective parties are:
Civil
Engineering and Development Department (CEDD)
2.2.2
CEDD is the Project Proponent and the Permit Holder of the EP of the development
of the Project and will assume overall responsibility for the project. An
Independent Environmental Checker (IEC) shall be employed by CEDD to audit the
results of the EM&A works carried out by the ET.
Architectural
Services Department (ArchSD)
2.2.3
ArchSD acts as
the works agent for Development Bureau (DEVB), for Contract SS C505 Liantang/ Heung Yuen Wai Boundary Control Point (BCP) ¡V BCP
Buildings and Associated Facilities.
Environmental
Protection Department (EPD)
2.2.4
EPD is the statutory enforcement body for
environmental protection matters in Hong Kong.
Ronald Lu
& Partners (Hong Kong) Ltd (The Architect)
2.2.5
Ronald Lu & Partners (Hong Kong) Ltd is
appointed by ArchSD as an Architect for Contract SS
C505 Liantang/ Heung Yuen Wai Boundary Control Point
(BCP) ¡V BCP Buildings and Associated Facilities. It responsible for overseeing the
construction works of Contract SS C505 and for ensuring that the works are
undertaken by the Contractor in accordance with the specification and contract
requirements. The duties and responsibilities of the Architect with respect to
EM&A are:
Monitor the Contractors¡¦ compliance with
contract specifications, including the implementation and operation of the
environmental mitigation measures and their effectiveness
Monitor Contractors¡¦ and ET¡¦s compliance with
the requirements in the Environmental Permit (EP) and EM&A Manual
Facilitate ET¡¦s implementation of the EM&A
programme
Participate in joint site inspection by the ET
and IEC
Oversee the implementation of the agreed Event
/ Action Plan in the event of any exceedance
Adhere to the procedures for carrying out
complaint investigation
Liaison with DSD, Engineer/Engineer¡¦s
Representative, ET, IEC and the Contractor of the ¡§Construction of the DSD¡¦s
Regulation of Shenzhen River Stage 4 (RSR 4)¡¨ Project discussing regarding the
cumulative impact issues.
Engineer
or Engineers Representative (ER)
2.2.6
The ER is responsible for overseeing the
construction works and for ensuring that the works are undertaken by the
Contractor in accordance with the specification and contract requirements. The
duties and responsibilities of the ER with respect to EM&A are:
¡P
Monitor the Contractors¡¦ compliance with
contract specifications, including the implementation and operation of the
environmental mitigation measures and their effectiveness
¡P
Monitor Contractors¡¦s,
ET¡¦s and IEC¡¦s compliance with the requirements in the Environmental Permit
(EP) and EM&A Manual
¡P
Facilitate ET¡¦s implementation of the
EM&A programme
¡P
Participate in joint site inspection by the
ET and IEC
¡P
Oversee the implementation of the agreed
Event / Action Plan in the event of any exceedance
¡P
Adhere to the procedures for carrying out
complaint investigation
¡P
Liaison with DSD, Engineer/Engineer¡¦s
Representative, ET, IEC and the Contractor of the ¡§Construction of the DSD¡¦s Regulation
of Shenzhen River Stage 4 (RSR 4)¡¨ Project discussing regarding the cumulative
impact issues.
The
Contractor(s)
2.2.7
There will be one contractor for each
individual works contract. The
Contractor(s) should report to the ER. The duties and responsibilities of the
Contractor are:
¡P
Comply with the relevant contract conditions
and specifications on environmental protection
¡P
Employ an Environmental Team (ET) to
undertake monitoring, laboratory analysis and reporting of EM &A Facilitate
ET¡¦s monitoring and site inspection activities
¡P
Participate in the site inspections by the ET
and IEC, and undertake any corrective actions
¡P
Provide information / advice to the ET
regarding works programme and activities which may contribute to the generation
of adverse environmental impacts
¡P
Submit proposals on mitigation measures in
case of exceedances of Action and Limit levels in accordance with the Event /
Action Plans
¡P
Implement measures to reduce impact where
Action and Limit levels are exceeded
¡P
Adhere to the procedures for carrying out
complaint investigation
Environmental Team (ET)
2.2.8
One ET will be employed for this Project. The ET shall not be in any way an
associated body of the Contractor(s), and shall be employed by the Project
Proponent/Contractor to conduct the EM&A programme. The ET should be managed by the ET
Leader. The ET Leader shall be a person who has at least 7 years¡¦ experience in
EM&A and has relevant professional qualifications. Suitably qualified staff
should be included in the ET, and resources for the implementation of the
EM&A programme should be allocated in time under the Contract(s), to enable
fulfillment of the Project¡¦s EM&A requirements as specified in the EM&A
Manual during construction of the Project. The ET shall report to the Project
Proponent and the duties shall include:
¡P
Monitor and audit various environmental
parameters as required in this EM&A Manual
¡P
Analyse the
environmental monitoring and audit data, review the success of EM&A
programme and the adequacy of mitigation measures implemented, confirm the
validity of the EIA predictions and identify any adverse environmental impacts
arising
¡P
Carry out regular site inspection to
investigate and audit the Contractors¡¦ site practice, equipment/plant and work
methodologies with respect to pollution control and environmental mitigation,
and effect proactive action to pre-empt problems
¡P
Monitor compliance with conditions in the EP,
environmental protection, pollution prevention and control regulations and
contract specifications
¡P
Audit environmental conditions on site
¡P
Report on the environmental monitoring and
audit results to EPD, the ER, the lEC and Contractor(s) or their delegated representatives
¡P
Recommend suitable mitigation measures to the
Contractor in the case of exceedance of Action and Limit levels in accordance
with the Event and Action Plans
¡P
Liaise with the IEC on all environmental
performance matters and timely submit all relevant EM&A proforma for
approval by IEC
¡P
Advise the Contractor(s) on environmental
improvement, awareness, enhancement measures etc., on site
¡P
Adhere to the procedures for carrying out
complaint investigation
¡P
Liaison with the client departments,
Engineer/Engineer¡¦s Representative, ET, lEC and the
Contractor(s) of the concurrent projects as listed under Section 2.3 below
regarding the cumulative impact issues.
Independent Environmental Checker (IEC)
2.2.9
One IEC will be employed for this Project. The Independent Environmental Checker
(IEC) should not be in any way an associated body of the Contractor(s) or the
ET for the Project. The IEC should
be employed by the Permit Holder (i.e., CEDD) prior to
the commencement of the construction of the Project. The IEC should have at least 10 years¡¦
experience in EM&A and have relevant professional qualifications. The duty of IEC should be:
¡P
Provide proactive advice to the ER and the
Project Proponent on EM&A matters related to the project, independent from
the management of construction works, but empowered to audit the environmental
performance of construction
¡P
Review and audit all aspects of the EM&A
programme implemented by the ET
¡P
Review and verify the monitoring data and all
submissions in connection with the EP and EM&A Manual submitted by the ET
¡P
Arrange and conduct regular, at least monthly
site inspections of the works during construction phase, and ad hoc inspections
if significant environmental problems are identified
¡P
Check compliance with the agreed Event /
Action Plan in the event of any exceedance
¡P
Check compliance with the procedures for
carrying out complaint investigation
¡P
Check the effectiveness of corrective
measures
¡P
Feedback audit results to ET by signing off
relevant EM&A proforma
¡P
Check that the mitigation measures are
effectively implemented
¡P
Report the works conducted, the findings,
recommendation and improvement of the site inspections, after reviewing ET¡¦s
and Contractor¡¦s works, and advices to the ER and Project Proponent on a
monthly basis
¡P
Liaison with the client departments,
Engineer/Engineer¡¦s Representative, ET, lEC and the
Contractor(s) of the concurrent projects as listed under Section 2.3 below
regarding the cumulative impact issues.
2.3.1
The concurrent construction works that may be
carried out include, but not limited to, the following:
(a)
Regulation of Shenzhen River Stage IV;
(b)
Widening of Fanling
Highway ¡V Tai Hang to Wo Hop Shek Interchange ¡V Contract No. HY/2012/06;
(c)
Construction of BCP facilities in Shenzhen.
2.4.1
Following the partial commencement of the
Project, the major construction works under the Project were substantially
completed. Proposal for partial
termination of the construction phase EM&A programme for Contracts 2, 4, 7
and SS C505 was approved by EPD on 9 July 2020 (EPD¡¦s ref.: ( ) in Ax (3) to EP
2/N7/A/52 Pt.17). Moreover,
termination proposal for Contract 3 was approved by EPD on 4 May 2021 (EPD¡¦s
ref.: () in Ax (3) to EP 2/N7/A52 Pt.18).
2.4.2
Construction Work of Contract 6 was completed
in May 2023, thus no construction work was presented in the Reporting Period. The
proposal for termination of construction phase EM&A programme for Contract
6 and the entire project was approved by EPD on 31 October 2023.
2.5.1
In according to the EP, the required
documents have submitted to EPD which listed in below:
Project Layout Plans of Contracts 2, 3, 4, 5,
6, 7 and SS C505
Landscape Plan
Topsoil Management Plan
Environmental Monitoring and Audit Programme
Baseline Monitoring Report
(TCS00690/13/600/R0030v3) for the Project
Waste Management Plan of the Contracts 2, 3, 4,
5, 6, 7 and SS C505
Contamination Assessment Plan (CAP) and
Contamination Assessment Report (CAR) for Po Kat Tsai, Loi Tung and the
workshops in Fanling
Vegetation Survey Report
Woodland Compensation Plan
Habitat Creation Management Plan
2.5.2
Summary of
the relevant permits, licenses, and/or notifications on environmental
protection for the Project of each contracts are presented in Table 2-1.
Table
2-1 Status
of Environmental Licenses and Permits of the Contracts
Item |
Description |
License/Permit
Status |
||
Ref.
no. |
Effective Date |
Expiry Date |
||
Contract 6 |
||||
1 |
Air
pollution Control (Construction Dust) Regulation |
Ref. No: 390614 |
29 Jun 2015 |
Till the
end of Contract |
2 |
Chemical
Waste Producer Registration |
Waste Producers Number
No.: 5213-652-C3969-01 |
31 Aug 2015 |
Till the
end of Contract |
3 |
Water
Pollution Control Ordinance - Discharge License |
WT00041417-2022 |
20 Jun 2022 |
Valid
until 30 Jun 2027 |
3.1.1
The Environmental Monitoring and Audit
requirements are set out in the Approved EM&A manual. Environmental issues
such as air quality, construction noise and water quality were identified as
the key issues during the construction phase of the Project.
3.1.2
A summary of construction phase EM&A
requirements are presented in the
sub-sections below.
3.2.1
The EM&A program of construction phase
monitoring shall cover the following environmental issues:
•
Air quality;
•
Construction noise; and
•
Water quality
3.2.2
A summary of the monitoring parameters is
presented in Table 3-1.
Table 3-1 Summary
of EM&A Requirements
Environmental
Issue |
Parameters |
Air
Quality |
1-hour
TSP by Real-Time Portable Dust Meter; and 24-hour
TSP by High Volume Air Sampler. |
Noise |
Leq(30min) in normal working days (Monday to
Saturday) 07:00-19:00 except public holiday; and 3 sets
of consecutive Leq(5min) on
restricted hours i.e. 19:00 to 07:00 next day, and whole day of public
holiday or Sunday Supplementary
information for data auditing, statistical results such as L10 and
L90 shall also be obtained for reference. |
Water
Quality |
In-situ
Measurements Dissolved
Oxygen Concentration (mg/L); Dissolved
Oxygen Saturation (% ); Turbidity
(NTU); pH unit; Water
depth (m); and Temperature
(¢J). |
Laboratory Analysis Suspended
Solids (mg/L) |
3.3.1
The designated monitoring locations as
recommended in the EM&A Manual
are shown in Appendix C. As the access to some of the designated
monitoring locations was questionable due to safety reason or denied by the
landlords, alternative locations therefore have had proposed. The latest alternative monitoring locations has been updated in the revised EM&A Programme (Rev.7) which approved
by EPD on 7 April 2017. Besides, in view
of Location AM1b was demolished and returned to the landlord on 27 April 2018, alterative location AM1c was proposed by
ET and approved by EPD on 26 November 2018. Table
3-2, Table 3-3 and Table 3-4 are respectively listed
the air quality, construction noise and water quality monitoring locations for
the Project and a map showing these monitoring stations is presented in Appendix D.
3.3.2
Following the proposal
for partial termination of the construction phase EM&A programme for
Contract 2, 4, 7 and SSC505 and Contract 3 was approved by EPD on 9 July 2020
and 4 May 2021 respectively. The
corresponding air quality monitoring stations including AM1c, and AM8 were
ceased after last monitoring carried out on 7 July 2020 and 10 July 2020 respectively
and AM9b was ceased after last monitoring carried out on 4 May 2021. Besides, the corresponding noise monitoring
stations including NM1 and NM7 were ceased after last monitoring carried out on
7 July 2020 and 10 July 2020 respectively and NM8, NM9 and NM10 were ceased
after last monitoring carried out on 29 April 2021 according to Partial
Termination Proposal for Contract 3 approved by EPD on 4 May 2021. Moreover, WM4,
WM4-CA and WM4-CB were ceased after last monitoring carried out on 3 May 2021
according to Partial Termination Proposal for Contract 3 approved by EPD on 4
May 2021.
Table
3-2 Impact
Monitoring Stations - Air Quality
Station ID |
Description |
Works Area |
Related to the Work Contract |
AM1c (*) ($) |
Open area of Tsung Yuen Ha Village No. 63 |
BCP |
SS C505 Contract 7 |
AM2 |
Village House near Lin Ma Hang
Road |
LMH to Frontier Closed Area |
Contract 6 |
AM3 |
Ta Kwu
Ling Fire Service Station of Ta Kwu Ling Village. |
LMH to Frontier Closed Area |
Contract 6 |
AM4b^ |
House no. 10B1 Nga Yiu Ha Village |
LMH to Frontier Closed Area |
Contract 6 |
AM5a^ |
Ping Yeung Village House |
Ping Yeung to Wo Keng Shan |
Contract 6 |
AM6 |
Wo Keng Shan Village House |
Ping Yeung to Wo Keng Shan |
Contract 6 |
AM7b@ |
Loi Tung
Village House |
Sha Tau Kok Road |
Contract 2 Contract 6 |
AM8 ($) |
Po Kat Tsai Village No. 4 |
Po Kat Tsai |
Contract 2 |
AM9b# |
Nam Wa
Po Village House No. 80 |
Fanling |
Contract 3 |
# Proposal for the change of air quality
monitoring location from AM9a to AM9b was submitted to EPD on 4 Nov 2013 after
verified by the IEC and it was approved by EPD (EPD¡¦s ref.: (15) in EP
2/N7/A/52 Pt.10 dated 8 Nov 2013). Besides, AM9b was ceased after last
monitoring carried out on 4 May 2021 according to Partial Termination Proposal
approved by EPD on 4 May 2021.
@ Proposal for the change of air quality
monitoring location from AM7a to AM7b was submitted to EPD on 4 June 2014 after
verified by the IEC. It was approved by EPD (EPD¡¦s ref.: (7) in EP 2/N7/A/52
Pt.12 dated 9 Jun 2014).
^ Proposal for change of air quality
monitoring locations was enclosed in the updated EM&A Programme which
approval by EPD on 29 Mar 2016. Besides, Location AM1b was temporary suspended
(24-hour TSP monitoring) since 27 April 2018 as the rented land was demolished
and returned to the landlord.
* Revised proposal for alterative
location AM1c was submitted to EPD on 31 October 2018 after
verified by the IEC and it was
approved by EPD (EPD¡¦s ref.: ( ) in Ax (1) to EP 2/N7/A/52 Pt.26 dated 26 November 2018).
$ AM1c and AM8
were ceased after last monitoring carried out on 7 July 2020 and 10 July 2020 respectively
according to Partial Termination Proposal approved by EPD on 9 July 2020.
Table
3-3 Impact
Monitoring Stations - Construction Noise
Station ID |
Description |
Works Area |
Related to the Work Contract |
NM1 ($) |
Tsung Yuen Ha Village House No. 63 |
BCP |
SS C505 Contract 7 |
NM2a# |
Village House near Lin Ma Hang Road |
Lin Ma Hang to Frontier Closed Area |
Contract 6 |
NM3 |
Ping Yeung Village House (facade facing northeast) |
Ping Yeung to Wo Keng Shan |
Contract 6 |
NM4 |
Wo Keng Shan Village House |
Ping Yeung to Wo Keng Shan |
Contract 6 |
NM5 |
Village House, Loi Tung |
Sha Tau Kok Road |
Contract 2, Contract 6 |
NM6 |
Tai Tong Wu Village House 2 |
Sha Tau Kok Road |
Contract 2, Contract 6 |
NM7 ($) |
Po Kat Tsai Village |
Po Kat Tsai |
Contract 2 |
NM8 ($) |
Village House, Tong Hang |
Fanling |
Contract 2 Contract 3 |
NM9 ($) |
Village House, Kiu Tau Village |
Fanling |
Contract 3 |
NM10 ($) |
Nam Wa Po Village House No.
80 |
Fanling |
Contract 3 |
# Proposal for the change of construction
noise monitoring location from NM2 to NM2a was verified by the IEC on 6 May
2016 and was effective on 9 May 2016.
$ NM1 and NM7 were
ceased after last monitoring carried out on 7 July 2020 and 10 July 2020 respectively
according to Partial Termination Proposal approved by EPD on 9 July 2020.
Besides, NM8, NM9 and NM10 were ceased after last monitoring carried out on 29
April 2021 according to Partial Termination Proposal for Contract 3 approved by
EPD on 4 May 2021.
Table
3-4 Impact
Monitoring Stations - Water Quality
Station ID |
Description |
Coordinates of Designated / Alternative Location |
Nature of the location |
Related to the Work Contract |
|
WM1 |
Downstream of Kong Yiu
Channel |
833 679 |
845 421 |
Alternative location
located at upstream 51m of the designated location |
Contract 6 |
WM1- Control |
Upstream of Kong Yiu
Channel |
834 185 |
845 917 |
NA |
Contract 6 |
WM2A |
Downstream of River
Ganges |
834 204 |
844 471 |
Alternative location
located at upstream 81m of the designated location |
Contract 6 |
WM2A(a)* |
Downstream of River
Ganges |
834 191 |
844 474 |
Alternative location
located at upstream 70m of the designated location |
Contract 6 |
WM2A- Controlx# |
Upstream of River
Ganges |
835 377 |
844 188 |
Alternative location
located at upstream 160m of the designated location |
Contract 6 |
WM2B |
Downstream of River
Ganges |
835 433 |
843 397 |
NA |
Contract 6 |
WM2B- Control |
Upstream of River
Ganges |
835 835 |
843 351 |
Alternative location
located at downstream 31m of the designated location |
Contract 6 |
WM3x# |
Downstream of River
Indus |
836 206 |
842 270 |
Alternative location
located at downstream 180m of the designated location |
Contract 6 |
WM3- Control |
Upstream of River
Indus |
836 763 |
842 400 |
Alternative location
located at downstream 26m of the designated location |
Contract 6 |
WM4 ($) |
Downstream of Ma Wat
Channel |
833 850 |
838 338 |
Alternative location
located at upstream 11m of the designated location |
Contract 3 |
WM4¡V Control A ($) |
Kau Lung Hang Stream |
834 028 |
837 695 |
Alternative location
located at downstream 28m of the designated location |
Contract 3 |
WM4¡V Control B ($) |
Upstream of Ma Wat
Channel |
833760 |
837395 |
Alternative location
located at upstream 15m of the designated location |
Contract 3 |
Note: EPD has approved the revised EM&A Programme (Rev.7) which
proposed that (1) if the measured water depth of the monitoring station is
lower than 150 mm, alternative location based on the criteria were selected to
perform water monitoring; and (2) If no suitable alternative location could be
found within 15m far from the original location, the sampling at that location
will be cancelled since sampling at too far from the designated location could
not make a representative sample in accordance with the updated EM&A
Programme (Rev. 07) (Section 4.1.4) (EPD ref.: ( ) in EP2/N7/A/52 Ax(1) Pt.20
dated 7 April 2017)
(*)
Proposal for the change of water monitoring
location from WM2A to WM2A(a) was verified by the IEC and it was approved by
EPD. (EPD¡¦s ref. (10) in EP 2/N7/A/52 Pt.19)
(#) Proposal
for the change of water quality
monitoring location (WM3x and WM2A-Cx was
included in the EM&A Programme Rev .05 which
approved by EPD on 29 March 2016 (EPD ref.: (3) in EP2/N7/A/52 Ax(1) Pt.19)
($) WM4, WM4-CA
and WM4-CB were ceased after last monitoring carried out on 3 May 2021
according to Partial Termination Proposal for Contract 3 approved by EPD on 4
May 2021.
3.4.1
The requirements of
impact monitoring are stipulated in Sections
2.1.6, 3.1.5 and 4.1.6 of the
approved EM&A Manual and
presented as follows.
Air Quality Monitoring
3.4.2
Frequency of impact
air quality monitoring is as follows:
1-hour TSP |
3 times every six
days during course of works |
24-hour TSP |
Once every 6 days during course of works |
Noise Monitoring
3.4.3
One set of Leq(30min) as 6 consecutive Leq(5min) between 0700-1900 hours on
normal weekdays and once every week during course of works. If construction work necessary to carry
out at other time periods, i.e. restricted time period (19:00 to 07:00 the next
morning and whole day on public holidays) (hereinafter referred as ¡§the
restricted hours¡¨), 3 consecutive Leq(5min) measurement will depended CNP requirements to
undertake. Supplementary information for data auditing, statistical results such as
L10 and L90 shall also be obtained for reference.
Water Quality Monitoring
3.4.4
The water quality monitoring frequency shall
be 3 days per week during course of works.
The interval between two sets of monitoring shall not be less than 36
hours.
Air Quality Monitoring
3.5.1
The 24-hour and 1-hour TSP levels shall be
measured by following the standard high volume sampling method as set out in
the Title 40 of the Code of Federal Regulations, Chapter 1 (Part 50), Appendix B. If the ET proposes to use a direct
reading dust meter to measure 1-hour TSP levels, it shall submit sufficient
information to the IEC to approve.
3.5.2
The filter paper of 24-hour TSP measurement shall be determined by HOKLAS
accredited laboratory.
3.5.3
All equipment to be used for air quality
monitoring is listed in Table 3-5.
Table 3-5 Air
Quality Monitoring Equipment
Equipment |
Model |
24-Hour
TSP |
|
High Volume Air Sampler |
TISCH High Volume Air Sampler, HVS Model
TE-5170 |
Calibration Kit |
TISCH Model TE-5025A |
1-Hour
TSP |
|
Portable Dust Meter |
Sibata LD-3B Laser Dust monitor Particle Mass
Profiler & Counter/ SidePak™ Personal Aerosol
Monitor AM510 |
Wind Data
Monitoring Equipment
3.5.4
According to the approved EM&A Manual,
wind data monitoring equipment shall also be provided and set up for logging
wind speed and wind direction near the dust monitoring locations. The equipment installation location
shall be proposed by the ET and agreed with the IEC. For installation and operation of wind
data monitoring equipment, the following points shall be observed:
1)
The wind sensors should be installed 10 m
above ground so that they are clear of obstructions or turbulence caused by
buildings.
2)
The wind data should be captured by a data
logger. The data shall be downloaded for analysis at least once a month.
3)
The wind data monitoring equipment should be
re-calibrated at least once every six months.
4)
Wind direction should be divided into 16
sectors of 22.5 degrees each.
3.5.5
ET has liaised with the landlords of the
successful granted HVS installation premises. However, the owners rejected to provide
premises for wind data monitoring equipment installation.
3.5.6
Under this situation, the ET proposed
alternative methods to obtain representative wind data. Meteorological information as extracted
from ¡§the Hong Kong Observatory Ta Kwu Ling Station¡¨
is alternative method to obtain representative wind data. For Ta Kwu
Ling Station, it is located nearby the Project site. Moreover, this station is located at 15m
above mean sea level while its anemometer is located at 13m above the existing
ground which in compliance with the general setting up requirement. Furthermore, this station also can be to
provide the humidity, rainfall, and air pressure and temperature etc.
meteorological information. In Hong
Kong of a lot development projects, weather information extracted from Hong
Kong Observatory is common alternative method if weather station installation
not allowed.
Noise Monitoring
3.5.7
Sound
level meter in compliance with the International Electrotechnical Commission
Publications 651: 1979 (Type 1) and 804: 1985 (Type 1) specifications shall be
used for carrying out the noise monitoring. The sound level meter shall be checked
using an acoustic calibrator. The wind speed shall be checked with a portable
wind speed meter capable of measuring the wind speed in m s-1.
3.5.8
Noise monitoring equipment to be used for
monitoring is listed in Table 3-6.
Table 3-6 Construction
Noise Monitoring Equipment
Equipment |
Model |
Integrating Sound Level Meter |
Rion NL-52 |
Calibrator |
Rion
NC-75 |
Portable Wind Speed Indicator |
Testo
Anemometer |
3.5.9
Sound level meters listed above comply with
the International Electrotechnical
Commission Publications 651: 1979 (Type 1) and 804: 1985 (Type 1) specifications, as recommended in TM issued
under the NCO. The acoustic
calibrator and sound level meter to be used in the impact monitoring will be
calibrated yearly.
Water Quality Monitoring
3.5.10 DO and water temperature should be measured in-situ by a DO/temperature
meter. The instrument should be portable and weatherproof using a DC power source.
It should have a membrane electrode
with automatic temperature compensation complete with a cable. The equipment
should be capable of measuring:
•
a DO level in the range of 0-20 mg/l and 0-200%
saturation; and
•
a temperature of between 0 and 45 degree
Celsius.
3.5.11 A portable pH meter capable of measuring a range between 0.0 and 14.0
should be provided to measure pH under the specified conditions accordingly to
the APHA Standard Methods.
3.5.12 The instrument should be portable and weatherproof using a DC power
source. It should have a photoelectric sensor capable of measuring turbidity
between 0-1000 NTU.
3.5.13 A
portable, battery-operated echo sounder or tape measure will be used for the
determination of water depth at each designated monitoring station as
appropriate.
3.5.14 A water
sampler e.g. Kahlsico Water Sampler, which is a
transparent PVC cylinder with capacity not less than 2 litres,
will be used for water sampling if water depth over than 0.5m. For sampling from very shallow
water depths e.g. <0.5 m, water sample collection will be directly from
water surface below 100mm use sampling plastic bottle to avoid inclusion of
bottom sediment or humus. Moreover,
Teflon/stainless steel bailer or self-made sampling buckets maybe used for
water sampling. The equipment used
for sampling will be depended the sampling location and depth situations.
3.5.15 Water
samples for laboratory measurement of SS will be collected in high density polythene
bottles, packed in ice (cooled to 4 ºC without being frozen), and delivered to
the laboratory in the same day as the samples were collected.
3.5.16 Analysis
of suspended solids should be carried out in a HOKLAS or other accredited
laboratory. Water samples of about 1L should be collected at the monitoring
stations for carrying out the laboratory suspended solids determination. The SS determination work should start
within 24 hours after collection of the water samples. The SS analyses should
follow the APHA Standard Methods 2540D
with Limit of Reporting of 2 mg/L.
3.5.17 Water
quality monitoring equipment used in the impact monitoring is listed in Table
3-7. Suspended solids (SS) analysis is
carried out by a local HOKLAS-accredited laboratory, namely ALS Technichem
(HK) Pty Ltd.
Table 3-7 Water
Quality Monitoring Equipment
Equipment |
Model |
Water Depth Detector |
Eagle Sonar or tape measures |
Water Sampler |
A
2-litre transparent PVC cylinder with latex cups at both ends or teflon/stainless steel bailer or self-made sampling
bucket |
Thermometer & DO meter |
YSI
Professional DSS |
pH meter |
YSI
Professional DSS |
Turbidimeter |
YSI
Professional DSS |
Sample Container |
High
density polythene bottles (provided by laboratory) |
Storage Container |
¡¥Willow¡¦ 33-liter plastic cool box with Ice
pad |
1-hour TSP Monitoring
3.6.1
The 1-hour TSP monitor was a brand named ¡§Sibata LD-3B Laser Dust monitor Particle Mass Profiler
& Counter¡¨ which is a portable, battery-operated laser photometer. The 1-hour TSP meter provides a real
time 1-hour TSP measurement based on 90o light scattering. The 1-hour TSP monitor consists of the
following:
(a.)
A pump to draw sample aerosol through the
optic chamber where TSP is measured;
(b.)
A sheath air system to isolate the aerosol in
the chamber to keep the optics clean for maximum reliability; and
(c.)
A built-in data logger compatible with
Windows based program to facilitate data collection, analysis and reporting.
3.6.2
The 1-hour TSP meter is used within the valid
period as follow manufacturer¡¦s Operation and Service Manual.
3.6.3
The equipment used for 24-hour TSP
measurement is Tisch
Environmental, Inc. Model TE-5170 TSP high volume air sampling system, which complied with EPA Code of Federal Regulation, Appendix B
to Part 50. The High Volume Air Sampler (HVS) consists of the following:
(a.)
An anodized aluminum shelter;
(b.)
A 8¡¨x10¡¨ stainless steel filter holder;
(c.)
A blower motor assembly;
(d.)
A continuous flow/pressure recorder;
(e.)
A motor speed-voltage control/elapsed time
indicator;
(f.)
A 7-day mechanical timer, and
(g.)
A power supply of 220v/50 Hz
3.6.4
The HVS is operated and calibrated on a
regular basis in accordance with the manufacturer¡¦s instruction using Tisch
Calibration Kit Model TE-5025A.
Calibration would carry out in two month interval.
3.6.5
24-hour TSP is collected by the ET on filters
of HVS and quantified by a local HOKLAS accredited laboratory, ALS Technichem (HK) Pty Ltd (ALS), upon receipt of the
samples. The ET keep all the
sampled 24-hour TSP filters in normal air conditioned room conditions, i.e. 70%
RH (Relative Humidity) and 25oC, for six months prior to disposal.
3.6.6
Noise measurements were taken in terms of the
A-weighted equivalent sound pressure level (Leq)
measured in decibels dB(A). Supplementary statistical results (L10
and L90) were also obtained for reference.
3.6.7
During
the monitoring, all noise measurements were performed with the meter set to
FAST response and on the A-weighted equivalent continuous sound pressure level
(Leq). Leq(30min)
in six consecutive Leq(5min) measurements
were used as the monitoring parameter for the time period between 0700-1900
hours on weekdays; and also Leq(15min) in
three consecutive Leq(5min) measurements
is used as monitoring parameter for other time periods (e.g. during restricted
hours), if necessary.
3.6.8
Prior
of noise measurement, the accuracy of the sound level meter is checked using an
acoustic calibrator generating a known sound pressure level at a known
frequency. The checking was
performed before and after the noise measurement.
Water Quality
3.6.9
Water
quality monitoring is conducted at the designated locations. The sampling
produce with the in-situ monitoring are presented as below:
Sampling Procedure
3.6.10 A Digital Global Positioning System (GPS) is used to identify the
designated monitoring stations prior to water sampling. A portable, battery-operated echo
sounder is used for the determination of water depth at each station. At each station, water sample would be
collected from 0.1m below water surface or the water surface to prevent the
river bed sediment for stirring.
3.6.11 If the
water level of a monitoring station is too shallow when sampling, sediment
would be disturbed which affecting the accuracy of water quality
monitoring. In order to avoid
disturbing sediment, depth limits should be set up for the water sampling for
the ease of reference. When the
measured water depth of the monitoring station (both control and impact
stations) is lower than 150mm, water monitoring would not be to perform at that
monitoring location. Instead, the
monitoring location will be moved to a temporary alternative location
monitoring location based on the criteria below:-
(a)
the alternative location should be either
upstream or downstream of the original location and at the same the river/drain
channel
(b)the
alternative location should be within 15m far from the original location
(c)
if no suitable alternative location could be
found within 15m far from the original location, the sampling at that location
will be cancelled since sampling at too far from the designated location could
not make a representative sample.
3.6.12 The sample
container will be rinsed with a portion of the water sample. The water sample then will be
transferred to the high-density polythene
bottles as provided by the laboratory, labeled with a unique sample
number and sealed with a screw cap.
3.6.13 Before
sampling, general information such as the date and time of sampling, weather
condition as well as the personnel responsible for the monitoring would be
recorded on the field data sheet.
3.6.14 A ¡¥Willow¡¦
33-liter plastic cool box packed with ice will be used to preserve the water
samples prior to arrival at the laboratory for chemical determination. The water temperature of the cool box is
maintained at a temperature as close to 40C as possible without
being frozen. Samples collected are
delivered to the laboratory upon collection.
In-situ Measurement
3.6.15 YSI
Professional DSS is used for water in-situ measures, which automates the
measurements and data logging of temperature, dissolved oxygen and dissolved
oxygen saturation.
3.6.16 YSI
Professional DSS is used for in-situ pH measurement. The pH meter is capable of measuring pH
in the range of 0 ¡V 14 and readable to 0.1.
3.6.17 YSI
Professional DSS is used for in-situ turbidity measurement. The turbidity meter
is capable of measuring turbidity in the range of 0 ¡V 1000 NTU.
3.6.18 All
in-situ measurement equipment are calibrated by HOKLAS
accredited laboratory of three month interval.
Laboratory Analysis
3.6.19 All water samples are analyzed
with Suspended Solids (SS) as specified in the
EM&A Manual by a local HOKLAS-accredited testing laboratory (ALS Technichem (HK) Pty Ltd HOKLAS registration no. 66).
SS analysis is
determined by the laboratory upon receipt of the water samples using APHA Standard Methods 2540D (namely ALS Method EA-025 as
accredited HOKLAS Scheme) started within 48
hours of water sample receipt.
3.7.1
Calibration of the HVS is performed upon
installation and thereafter at bimonthly intervals in accordance with the
manufacturer¡¦s instruction using the certified standard calibrator (TISCH Model
TE-5025A).
Moreover, the Calibration Kit would be
calibrated annually. The calibration data are properly documented and the
records are maintained by ET for future reference.
3.7.2
The 1-hour TSP
meter was calibrated by the supplier prior to purchase. Zero response of the equipment would be
checked before and after each monitoring event. Annually calibration with the High
Volume Sampler (HVS) in same condition would be undertaken by the Laboratory.
3.7.3
The sound level
meter and calibrator are calibrated and certified by a laboratory accredited
under HOKLAS or any other international accreditation scheme at yearly basis.
3.7.4
All water quality monitoring equipment is
calibrated by HOKLAS accredited laboratory of three month intervals.
3.7.5
The calibration certificates of all
monitoring equipment used for the impact monitoring program in the Reporting
Period and the HOKLAS accredited certificate of laboratory are presented in
the relevant monthly EM&A reports.
3.8.1
The baseline results form the basis for
determining the environmental acceptance criteria for the impact
monitoring. According to the
approved Environmental Monitoring and Audit Manual, the air quality,
construction noise and water quality criteria were set up, namely Action and Limit
levels are listed in Tables 3-8, 3-9 and 3-10.
Table 3-8 Action and Limit Levels for Air Quality
Monitoring
Monitoring Station |
Action Level (mg /m3) |
Limit Level (mg/m3) |
||
1-hour TSP |
24-hour TSP |
1-hour TSP |
24-hour TSP |
|
AM1c ($) |
265 |
143 |
500 |
260 |
AM2 |
268 |
149 |
||
AM3 |
269 |
145 |
||
AM4b |
267 |
148 |
||
AM5a |
268 |
143 |
||
AM6 |
269 |
148 |
||
AM7b |
275 |
156 |
||
AM8 ($) |
269 |
144 |
||
AM9b ($) |
271 |
151 |
$ AM1c and AM8
were ceased after last monitoring carried out on 7 July 2020 and 10 July 2020 respectively
according to Partial Termination Proposal approved by EPD on 9 July 2020.
Besides, AM9b was ceased after
last monitoring carried out on 4 May 2021 according to Partial Termination Proposal
approved by EPD on 4 May 2021.
Table 3-9 Action
and Limit Levels for Construction Noise
Monitoring Location |
Action Level |
Limit Level in dB(A) |
Time Period: 0700-1900 hours on normal
weekdays |
||
NM1($), NM2a, NM3, NM4, NM5, NM6, NM7($), NM8($), NM9($), NM10($) |
When one or more documented complaints are
received |
75 dB(A)Note 1 & Note 2 |
Note 1: Acceptable Noise Levels for school should be reduced to 70 dB(A) and65 dB(A) during examination period.
Note 2: If works are to be carried out during restricted hours, the conditions
stipulated in the construction noise permit issued by the NCA have to be followed.
$ NM1 and NM7 were
ceased after last monitoring carried out on 7 July 2020 and 10 July 2020 respectively
according to Partial Termination Proposal approved by EPD on 9 July 2020.
Besides, NM8, NM9 and NM10 were ceased after last monitoring carried out on 29
April 2021 according to Partial Termination Proposal for Contract 3 approved by
EPD on 4 May 2021.
Table 3-10 Action
and Limit Levels for Water Quality
Parameter |
Performance criteria |
Monitoring Location |
|||||
WM1 |
WM2A(a) |
WM2B |
WM3x |
WM4($) |
|||
DO
(mg/L) |
Action Level |
(*)4.23 |
(**)4.00 |
(*)4.74 |
(**)4.00 |
(*)4.14 |
|
Limit Level |
(#)4.19 |
(**)4.00 |
(#)4.60 |
(**)4.00 |
(#)4.08 |
||
Turbidity
(NTU) |
Action Level |
51.3 |
24.9 |
11.4 |
13.4 |
35.2 |
|
AND 120% of upstream control station of
the same day |
|||||||
Limit Level |
67.6 |
33.8 |
12.3 |
14.0 |
38.4 |
||
AND
130% of upstream control
station of the same day |
|||||||
SS
(mg/L) |
Action Level |
54.5 |
14.6 |
11.8 |
12.6 |
39.4 |
|
AND 120% of upstream control station of the
same day |
|||||||
Limit Level |
64.9 |
17.3 |
12.4 |
12.9 |
45.5 |
||
AND
130% of upstream control
station of the same day |
|||||||
Remarks: (*) The
Proposed Action Level of Dissolved Oxygen is adopted to be
used 5%-ile of baseline data (**) The Proposed Action & Limit Level of Dissolved Oxygen is used 4mg/L (#) The Proposed Limit Level of Dissolved Oxygen is adopted to be
used 1%-ile of baseline data ($) WM4, WM4-CA
and WM4-CB were ceased after last monitoring carried out on 3 May 2021
according to Partial Termination Proposal for Contract 3 approved by EPD on 4
May 2021. |
|||||||
3.8.2
Should non-compliance of the environmental
quality criteria occurs, remedial actions will be triggered according to the
Event and Action Plan which presented in Appendix E.
3.9.1
All monitoring data will be handled by the ET¡¦s in-house data recording and management
system. The monitoring data recorded in the equipment
will be downloaded directly from the equipment at the end of each monitoring
day. The downloaded monitoring data
will input into a computerized database properly maintained by the ET. The laboratory results will be input
directly into the computerized database and checked by personnel other than
those who input the data.
3.9.2
For monitoring parameters that require
laboratory analysis, the local laboratory shall follow the QA/QC requirements
as set out under the HOKLAS scheme for the relevant laboratory tests.
4.1.1
Proposal for partial termination of the
construction phase EM&A programme for Contract 2, Contract 4, Contract 7
and Contract SS C505 was approved by EPD on 9 July 2020 (EPD¡¦s ref.: ( ) in Ax
(3) to EP 2/N7/A/52 Pt.17). The Partial termination proposal for Contract 3 was
approved by EPD on 4 May 2021 (EPD¡¦s ref.: ( ) in Ax (3) to EP 2/N7/A/52
Pt.18). The corresponding air quality monitoring stations AM1c, AM8 and AM9b
ceased accordingly, while monitoring at other monitoring stations continued in
the Reporting Period.
4.1.2
Power supply for HVS for 24-hour TSP
monitoring at Location AM3 (Ta Kwu Ling Ambulance
Depot) was suspended from 1 February 2023 due to the renovation work of Ta Kwu Ling Ambulance Depot. The renovation work of Ta Kwu Ling Ambulance Depot was expected to be completed in November
2023. We will closely liaise with the Contractor and Ta Kwu
Ling Ambulance Depot for the power supply issue and resume the 24-hour TSP
monitoring at Location AM3 immediately once the power supply is available.
4.2.1
One-hour TSP monitoring scheduled on 1
September 2023 for AM4b, AM5a, AM6 and AM7b was cancelled and rescheduled to 4
September 2023 due to adverse weather condition (Typhoon Signal No.8 enforced
on 1&2 September 2023).
4.2.2
Summary of air quality monitoring
results during the Reporting Period are tabulated in Table 4-1. The
relevant graphical plots throughout the Reporting Period are presented in Appendix F.
Table 4-1 Summary
of Air Quality Monitoring Results
Monitoring Location |
1-hour TSP (µg/m3) |
24-hour TSP (µg/m3) |
||||
Max |
Min |
Mean |
Max |
Min |
Mean |
|
AM2 |
82 |
37 |
61 |
93 |
29 |
53 |
Record Date |
30-Oct-23 |
27-Sep-23 |
51 events |
17
Oct 23 |
8
Sep 23 |
16 events |
AM3 |
88 |
32 |
61 |
Power
Suspended |
||
Record Date |
30-Oct-23 |
27-Sep-23 |
51 events |
|||
AM4b |
65 |
22 |
48 |
51 |
12 |
23 |
Record Date |
19-Sep-23 |
3-Aug-22 |
48 events |
27
Oct 23 |
5
Oct 23 |
16 events |
AM5a |
60 |
24 |
48 |
44 |
10 |
24 |
Record Date |
4-Sep-23 19-Sep-23 |
3-Aug-23 |
48 events |
17
Oct 23 |
12
Sep 23 |
16 events |
AM6 |
62 |
21 |
47 |
89 |
12 |
36 |
Record Date |
28-Sep-23 |
3-Aug-23 |
48 events |
5
Oct 23 |
12
Sep 23 |
16 events |
AM7b |
67 |
20 |
46 |
42 |
10 |
27 |
Record Date |
16-Oct-23 |
3-Aug-23 |
48 events |
6
Sep 23 5
Oct 23 |
12
Sep 23 |
16 events |
4.2.3
Breaches of air quality A/L levels and
statistical analysis of compliance for the air quality monitoring results are
summarized in Table 4-2.
Table 4-2 Summaries
of Breaches of Air Quality A/L Levels
Location |
Exceedance |
1-hour TSP |
24- hour TSP |
Total |
AM2 |
Action Level |
0 |
0 |
0 |
Limit Level |
0 |
0 |
0 |
|
AM3 |
Action Level |
0 |
0 |
0 |
Limit Level |
0 |
0 |
0 |
|
AM4a |
Action Level |
0 |
0 |
0 |
Limit Level |
0 |
0 |
0 |
|
AM5a |
Action Level |
0 |
0 |
0 |
Limit Level |
0 |
0 |
0 |
|
AM6 |
Action Level |
0 |
0 |
0 |
Limit Level |
0 |
0 |
0 |
|
AM7b |
Action Level |
0 |
0 |
0 |
Limit Level |
0 |
0 |
0 |
4.2.4
In the
Reporting Period, all the 1-hour
TSP and 24-hour TSP monitoring results were below
the Action/Limit Levels.
4.2.5
The summary of weather conditions during the Reporting
Period is presented in Appendix G.
Proposal for partial
termination of the construction phase EM&A programme for Contract 2, Contract 4, Contract 7 and
Contract SS C505 was approved by EPD on 9 July 2020 (EPD¡¦s ref.: ( ) in Ax (3)
to EP 2/N7/A/52 Pt.17). The Partial termination proposal for Contract 3 was
approved by EPD on 4 May 2021 (EPD¡¦s ref.: ( ) in Ax (3) to EP 2/N7/A/52 Pt.18). The corresponding noise quality monitoring
stations NM1, NM7, NM8, NM9 and NM10 ceased accordingly, while monitoring at other
monitoring stations continued in the Reporting Period.
5.2.1
The sound level meter was set in 1m from the
exterior of the building façade including noise monitoring locations NM3, NM4,
NM5 and NM6. No façade correction (+3 dB(A) is added according to acoustical
principles and EPD guidelines.
However, free-field status is performed at NM2a and façade correction
(+3 dB(A) has added according to the requirement.
5.2.2
Construction noise monitoring scheduled on 1
September 2023 for NM3, NM4, NM5 and NM6 was cancelled and rescheduled to 4
September 2023 due to adverse weather condition (Typhoon Signal No.8 enforced
on 1&2 September 2023). Summary of noise monitoring results
during the Reporting Period are tabulated in Table 5-1. The
relevant graphical plots throughout the Reporting Period are presented in Appendix F.
Table 5-1 Summary of Construction Noise
Monitoring Results
Monitoring
Location |
Leq, 30min (dB((A)) |
|
Max |
Min |
|
NM2a(*) |
74 |
68 |
Record Date |
27
Sep 23 |
1
Aug 23, 24
Aug 23, 30
Aug 23, 3
Oct 23 |
NM3 |
65 |
60 |
Record Date |
10-Oct-23 |
15-Aug-23, 13-Sep-23, 4-Oct-23 |
NM4 |
68 |
59 |
Record Date |
3-Aug-23 |
10-Oct-23 |
NM5 |
58 |
50 |
Record Date |
15-Aug-23 |
19-Sep-23 |
NM6 |
62 |
57 |
Record Date |
4-Sep-23 |
15-Aug-23, 13-Sep-23, 4-Oct-23, 10-Oct-23 |
(*) façade
correction (+3 dB(A) is added according to acoustical principles and EPD
guidelines
5.2.3
Breaches of construction noise A/L levels and
statistical analysis of compliance for construction noise monitoring results
are summarized in Table 5-2.
Table 5-2 Summaries
of Breaches of Construction Noise A/L Levels
Station |
Limit Level |
Action Level |
Received Date |
NM2a |
0 |
0 |
N/A |
NM3 |
0 |
||
NM4 |
0 |
||
NM5 |
0 |
||
NM6 |
0 |
5.2.4
In
this Reporting Period, the noise level
measured at all designated monitoring locations were below 75dB(A).
No Action level and Limit Level exceedance was triggered
and no corrective action was required.
6.1.1
Proposal for partial termination of the
construction phase EM&A programme for Contract 2, Contract 4, Contract 7
and Contract SS C505 was approved by EPD on 9 July 2020 (EPD¡¦s ref.: ( ) in Ax
(3) to EP 2/N7/A/52 Pt.17). The Partial termination proposal for Contract 3 was
approved by EPD on 4 May 2021 (EPD¡¦s ref.: ( ) in Ax (3) to EP 2/N7/A/52
Pt.18). The corresponding monitoring
stations WM4, WM4-CA and WM4-CB ceased accordingly, while monitoring at other
monitoring stations in the Reporting Period.
6.2.1
In the Reporting Period, some occasions of water sampling were
unable to carry out at WM2B, WM2B-C and WM3-C due to shallow water. Photo
records of WM2B, WM2B-C and WM3-C were presented in the
relevant monthly EM&A reports. In addition, water quality monitoring
scheduled on 1 September 2023 was cancelled due to adverse weather condition
(Typhoon Signal No.8 enforced on 1&2 September 2023).
6.2.2
Summary of monitoring results during the
Reporting Period are tabulated in Tables
6-1 and 6-3. The relevant
graphical plots throughout the Reporting Period are presented in Appendix F. In the Reporting Period, no exceedance was
recorded at all monitoring locations.
Table 6-1 Summary
of the Water Quality Monitoring Results ¡V Contract 6
Statistics |
DO
(mg/L) |
Turbidity
(NTU) |
SS
(mg/L) |
|||
WM1 |
WM1- Control |
WM1 |
WM1- Control |
WM1 |
WM1- Control |
|
Min |
5.1 |
4.5 |
6.5 |
5.6 |
5.5 |
3.0 |
Max |
8.3 |
9.8 |
403.0 |
423.5 |
718.5 |
658.5 |
Average |
7.4 |
8.0 |
28.7 |
28.4 |
39.4 |
33.6 |
Table 6-2 Summary
of the Water Quality Monitoring Results ¡V Contract 6
Statistics |
DO (mg/L) |
Turbidity
(NTU) |
SS (mg/L) |
|||||||||
WM2A(a) |
WM2A-C |
WM2B |
WM2B-C |
WM2A(a) |
WM2A-C |
WM2B |
WM2B-C |
WM2A (a) |
WM2A-C |
WM2B |
WM2B-C |
|
Min |
4.9 |
4.8 |
* |
* |
6.8 |
4.3 |
* |
* |
3.5 |
6.5 |
* |
* |
Max |
8.4 |
8.4 |
* |
* |
2146.0 |
2370.0 |
* |
* |
2810.0 |
3655.0 |
* |
* |
Average |
7.3 |
7.4 |
* |
* |
88.6 |
112.6 |
* |
* |
102.1 |
163.1 |
* |
* |
Remark:
(*) During Reporting Period, water sampling was unable to carry out at WM2B and
WM2B-C due to shallow water (water depth under 150mm)
Table 6-3 Summary
of the Water Quality Monitoring Results ¡V Contract 6
Statistics |
DO
(mg/L) |
Turbidity
(NTU) |
SS
(mg/L) |
|||
WM3x |
WM3- Control |
WM3x |
WM3- Control |
WM3x |
WM3- Control |
|
Min |
7.5 |
5.7 |
1.8 |
4.2 |
2.0 |
3.5 |
Max |
8.5 |
8.1 |
52.8 |
52.5 |
95.5 |
386.5 |
Average |
8.0 |
7.2 |
6.1 |
15.9 |
8.8 |
52.1 |
6.2.3
Breaches of water quality A/L levels and
statistical analysis of compliance for the water quality monitoring results are
summarized in Tables 6-5.
Table 6-4 Summaries
of Breaches of the Existing Water Quality A/L Levels
Reporting Period |
No. of sampling day |
Location |
DO (mg/L) |
Turbidity (NTU) |
SS (mg/L) |
|||
Action |
Limit |
Action |
Limit |
Action |
Limit |
|||
Aug-23 |
14 |
WM1 |
0 |
0 |
0 |
0 |
0 |
0 |
14 |
WM2A(a) |
0 |
0 |
0 |
0 |
0 |
0 |
|
0 |
WM2B |
0 |
0 |
0 |
0 |
0 |
0 |
|
14 |
WM3x |
0 |
0 |
0 |
0 |
0 |
0 |
|
Sep-23 |
13 |
WM1 |
0 |
0 |
0 |
0 |
0 |
0 |
13 |
WM2A(a) |
0 |
0 |
0 |
0 |
0 |
0 |
|
0 |
WM2B |
0 |
0 |
0 |
0 |
0 |
0 |
|
13 |
WM3x |
0 |
0 |
0 |
0 |
0 |
0 |
|
Oct-23 |
13 |
WM1 |
0 |
0 |
0 |
0 |
0 |
0 |
13 |
WM2A(a) |
0 |
0 |
0 |
0 |
0 |
0 |
|
0 |
WM2B |
0 |
0 |
0 |
0 |
0 |
0 |
|
13 |
WM3x |
0 |
0 |
0 |
0 |
0 |
0 |
|
Total |
40 |
WM1 |
0 |
0 |
0 |
0 |
0 |
0 |
40 |
WM2A(a) |
0 |
0 |
0 |
0 |
0 |
0 |
|
0 |
WM2B |
0 |
0 |
0 |
0 |
0 |
0 |
|
40 |
WM3x |
0 |
0 |
0 |
0 |
0 |
0 |
|
Sum |
0 |
0 |
0 |
0 |
0 |
0 |
6.2.4
No exceedance was recorded and no corrective action was required in the Reporting Period.
7.1.1
According to
the approved Woodland Compensation Plan (WCP), ecological
monitoring for woodland compensation shall be conducted at bi-monthly interval for the first year and the monitoring frequency
would be reduced to quarterly from the second year.
7.1.2
As Stage 2
of the enhancement planting work was undertaken in August 2019 has covered all
of the 9 monitoring quadrats, the monitoring frequency should have increased
from quarterly to bi-monthly interval for the first year of enhancement
planting.
7.1.3
The quarterly
ecological monitoring for period of June to August 2021 had carried out on 22
and 23 July 2021 by transects inspection and quadrat monitoring. The quarterly Ecological Monitoring
Report was verified by IEC on 7 October 2021 and it has been submitted as a
stand-alone copy to supplement the EM&A Report on 7 October 2021.
7.1.4
The
monitoring for woodland compensation was completed in August 2021 as the last
monitoring according to the approved WCP.
The details of findings could refer to the corresponding Quarterly
Ecological Monitoring Report. As
advised by the AECOM, the Woodland Compensation Area had been handed over to
AFCD after their acceptance of Initial Planting and Enhancement Planting Works,
which include the last replanting works in September 2021.
7.2.1
According to
the approved Habitat Creation and Management Plan (HCMP), the proposed Wetland Compensation
Area (WCA) near the Ping Yeung Interchange adjacent to the section of Ping Yuen
River was adopted. Ecological monitoring at implementation and establishment
periods of WCA will be conducted to cover the ecological attributes. Implementation of the wetland will
commence within the construction phase after completion of the construction
works at Ping Yeung Section. Monitoring on the WCA will be conducted
in implementation and establishment stages.
7.2.2
Monitoring of WCA at establishment stage has been conducted for one
year duration according to the approved HCMP. The establishment stage of
wetland was commenced on 1st October 2020 and report (September 2021) was the
last monitoring report for the Wetland Compensation Area.
The
monitoring results of ecology and water quality are generally in order, and no
follow up measures under the EM&A is required. After establishment stage,
AFCD would be responsible of maintenance and the monitoring works. As advised
by the AECOM, the handover issue with AFCD is under processing.
7.2.3
The revision of HCMP Rev 4.0 prepared by AECOM and has been certified
by ETL and verified by IEC on 9 December 2021 and re-submitted to EPD on 16 December
2021 and EPD had no comment on HCMP Rev 4.0 on 1 March 2022.
8.1.1
As construction work of the Project was
completed in May 2023 and the Billing Account for Disposal of Construction
Waste was cancelled by the Contractor in May, thus no waste was generated from
the Project in the Reporting Period.
9.1.1
According to the approved EM&A Manual,
the environmental site inspection shall be formulation by ET Leader. Weekly environmental site inspections
should carry out to confirm the environmental performance.
9.1.2
Proposal for partial
termination of the construction phase EM&A programme for Contract 2, Contract 4, Contract 7 and Contract SS C505 was approved by EPD on 9 July 2020
(EPD¡¦s ref.: ( ) in Ax (3) to EP 2/N7/A/52 Pt.17). The ET¡¦s site inspection and audit for corresponding
Contract 2, 4, 7 and SS C505 were ceased after last site inspection undertaken
on 10 July 2020.
9.1.3
The Partial
termination proposal for Contract 3 was approved by EPD on 4 May 2021 (EPD¡¦s
ref.: ( ) in Ax (3) to EP 2/N7/A/52 Pt.18). The ET¡¦s site inspection and audit for
Contract 3 was ceased after last site inspection undertaken on 5 May 2021.
Contract 6
9.1.4
During the Reporting Period, 13 events of
the joint site inspections were undertaken at Contract 6 to evaluate the site
environmental performance. The
summaries of the findings during site inspection are presented in Table
9-2 and the details of site inspection can be found in relevant EM&A
monthly report.
Table 9-2 Summary
of Reminders/Observations of Site Inspection ¡V Contract 6
Reporting Period |
Date of site inspection |
Nos. of findings / reminders |
Follow-Up Status |
August 2023 |
2, 9, 16, 23
and 29 August 2023 |
0 |
NA |
September 2023 |
6, 13, 22 and
27 September 2023 |
0 |
NA |
October 2023 |
4, 11, 18 and
25 October 2023 |
0 |
NA |
9.1.5
In the Reporting Period, no non-compliance and
no observations and reminder was recorded during the site inspections. The environmental performance of the
Project was therefore considered satisfactory.
Other
Contracts
9.1.6
Since the construction work of Contract 2, 3,
4, 5, 7 and Contract SS C505 has substantially completed. Proposal for partial termination of the construction phase EM&A
programme for Contract 2, Contract 3, Contract 4, Contract 7 and Contract SS C505 was approved by EPD, no site
inspection was performed.
10.1.1 In the Reporting
Period, one environmental complaint was recorded.
10.1.2 No summons and
prosecution under the EM&A Programme was lodged for all Contracts.
10.1.3
The statistical summary table of
environmental complaint, summons and prosecution are presented in Tables
10-1, 10-2 and 10-3. The
complaint log for the Project is shown in Appendix J.
Table 10-1 Statistical
Summary of Environmental Complaints
Contract No |
Reporting Period |
Environmental Complaint Statistics |
|||
Frequency
|
Cumulative since commencement of project |
Complaint Nature |
Project related
complaint |
||
6 |
Aug 23 |
0 |
47 |
(24) Water Quality (12) Dust (3) Noise (1) Nuisance (2) Noise and dust (3) Water quality and dust (1) Water quality and noise (1) Soil &
Muddy Water |
(8) water quality (3) dust (1) nuisance (1) water quality and dust (1) water quality and noise (1) Soil &
Muddy Water |
Sep 23 |
0 |
||||
Oct 23 |
0 |
Table 10-2 Statistical
Summary of Environmental Summons
Contract No |
Reporting Period |
Environmental
Summons Statistics |
||
Frequency |
Cumulative since commencement of project |
Complaint Nature |
||
6 |
Aug 23 |
0 |
0 |
NA |
Sep 23 |
0 |
|||
Oct 23 |
0 |
Table 10-3 Statistical
Summary of Environmental Prosecution
Contract No |
Reporting Period |
Environmental
Prosecution Statistics |
||
Frequency |
Cumulative since commencement of project |
Complaint Nature |
||
6 |
Aug 23 |
0 |
0 |
NA |
Sep 23 |
0 |
|||
Oct 23 |
0 |
10.1.4
Since
the construction works at the Contract 2, 4, 5, 7 and Contract SS C505 was substantially completed, no environmental complaint,
summons and prosecution under the EM&A Programme are registered.
11.1.1
The environmental mitigation measures that
recommended in the Implementation Schedule for Environmental Mitigation
Measures (ISEMM) in the approved EM&A Manual covered the issues of dust,
noise, water and waste and they are summarized presented in Appendix
I.
Implementation of Mitigation Measures during Construction Phase
11.1.2
Contract 6 under the
Project shall be implementing the required environmental mitigation measures
according to the approved EM&A Manual as subject to the site
condition. Environmental mitigation
measures have been generally implemented by Contract 6 according to the ISEMM,
where applicable.
Implementation of Mitigation Measures during Operation Phase
11.1.3
The Heung Yuen Wai
(HYW) Highway and connecting roads under the Project was opened on 26 May 2019.
Since partial commencement of operation is the same as the commencement of
operation for the entire project from EIAO perspective. All relevant requirements as stipulated
in the EP and the approved EIA report (including the EM&A Manual) for the
commencement of operation of the Project shall be strictly complied with.
11.1.4
In general, the recommended mitigation measures for operation stage of HYW Highway and connecting roads under the Project have been implemented.
The implementation status
of mitigation measures for operation phase in the Reporting Period are summarized
in Appendix
N.
11.1.5
For more details
about the implementation status of mitigation measures for operation phase with
photo illustration, an Environmental Monitoring and Audit report on the
implementation of the mitigation measures for operation stage of the Project
will be disposed to EPD not later than three months after the commencement of
operation of the Project under EP-404/2011/D condition 5.5. The abovementioned
report was submitted to EPD on 23 August 2019.
11.1.6
Upon BCP partially
opened on 26 August 2020, an operation phase EM&A report covering the
operation of the BCP (Version 3) was subsequently
submitted to EPD in accordance with the EP-404/2011/D condition 5.5. EPD on 10
February 2021 wrote to the EP Holder that they considered the Operation Phase
EM&A Report was generally in order and met the EP Condition 5.5.
11.1.7
Pursuant to
EM&A Manual Section 10.2, the implementation of landscape mitigation
measures during establishment period shall be audited by a qualified landscape
architect. Site inspection for establishment
period was commenced in August 2019 and competed in July 2020
respectively. The relevant
checklists were included in the corresponding EM&A Reports. Besides, further to the Landscape Plan
(Rev.4) approved by EPD via letter dated 7 June 2021, minor changes on site
layout was required, AECOM then submitted the Landscape Plan Rev.5 to EPD on 31
May 2022 for approval and has been approved by EPD on 16 September 2022.
12.1.1 This is the
41st Quarterly EM&A Summary Report presenting
the monitoring results and inspection findings for the Reporting Period from 1 August 2023 to 31 October 2023.
12.1.2 Construction
works for additional works at Kong Yiu Channel area was completed in May 2023,
thus no construction work and waste raised of the Projects was presented in the
Reporting Period. Updated EM&A termination proposal (Revision 2) addressing
EPD¡¦s comment on 28 July 2023 was certified by ET and verified by IEC in August
2023 and the proposal was submitted to EPD by AECOM in early-September 2023.
The proposal for termination of construction phase EM&A programme for
Contract 6 and entire Project was approved by EPD on 31 October 2023 (EPD
letter reference: ( ) in Ax(3) to EP2/N7/A52 Pt.19 dated 31 October 2023. Thus, this is the last Quarterly
EM&A Report for the Project.
12.1.3 For air quality monitoring, no 1-hour TSP
and 24-hour TSP monitoring results triggered the Action /Limit Level.
12.1.4 In the
Reporting Period, no construction noise exceedance was
recorded and no complaint (which triggered
the Action Level exceedance) was
received.
12.1.5 For water
quality monitoring, no exceedance was recorded in the Reporting Period.
12.1.6
No
environmental compliant, summons or successful prosecutions were recorded in
the Reporting Period.
12.1.7
During
the Reporting Period, weekly joint site inspection was conducted by ET and
Contractor of Contract 6 and monthly joint site inspection was conducted by
RE, IEC, ET and Contractor of Construct of 6 in accordance with the EM&A Manual stipulation. No non-compliance observed during the site inspection.
12.2.1
As
construction work of the Project was completed in May 2023, thus no adverse
environmental issue arising from the Project is foreseen in the future.
12.2.2
The proposal for termination of construction
phase EM&A programme for Contract 6 and entire Project was approved by EPD
on 31 October 2023. The Contractor was reminded to implement
the mitigation measure for the Operation Phase as stipulated in the EP and the
approved EIA Report.
