Job No.: TCS00694/13 |
|
|
||
|
|
|
|
|
||
|
|
Agreement No. CE 45/2008
(CE) Liantang/Heung Yuen Wai Boundary Control Point
and Associated Works |
|
|
||
|
|
|
|
|
||
|
|
40th Quarterly Environmental Monitoring & Audit Summary Report ¡V (May
to July 2023) |
|
|
||
|
|
Prepared
For |
|
|
||
|
|
Civil Engineering and Development Department (CEDD) |
|
|
||
Quality Index |
|||
Date |
Reference No. |
Prepared By |
Certified By |
21 December 2023 |
TCS00694/13/600/R2845v2 |
|
|
Nicola
Hon (Environmental Consultant) |
T.W. Tam (Environmental Team Leader) |
Version |
Date |
Description |
1 |
15 August 2023 |
First
Submission |
2 |
21 December 2023 |
Amended
according to IEC¡¦s comment on 4 Dec 2023 |
|
|
|
|
|
|
This
report has been prepared by Action-United Environmental Services &
Consulting with all reasonable skill, care and diligence within the terms of
the Agreement with the client, incorporating our General Terms and Conditions
of Business and taking account of the resources devoted to it by agreement
with the client. We disclaim any responsibility to the client and others in
respect of any matters outside the scope of the above. This report is
confidential to the client and we accept no responsibility of whatsoever
nature to third parties to whom this report, or any part thereof, is made
known. Any such party relies upon the report at their own risk. |
Executive Summary
ES.01.
This is the 40th Quarterly
EM&A Summary Report for the ¡§Liantang/Heung
Yuen Wai Boundary Control Point and Associated Works¡¨ under Environmental Permit No. EP-404/2011/D (hereinafter ¡¥¡¥the EP¡¦¡¦), covering the period from 1 May 2023 to 31 July 2023
(hereinafter ¡§Reporting Period¡¨).
ES.02. In the
Reporting Period, the construction works under Liantang/Heung Yuen Wai
Boundary Control Point and Associated Works Contract 6. Environmental monitoring activities
under the EM&A programme in the Reporting Period are summarized in the
following table.
Environmental Aspect |
Monitoring
Parameters / Inspection |
Reporting Period |
|
Monitoring Locations
/ Contracts |
Total Occasions |
||
Air Quality |
1-hour TSP |
6 (#) |
288 |
24-hour TSP |
6 (#) |
80 |
|
Construction Noise |
Leq(30min) Daytime |
5 (~) |
65 |
Water Quality |
Water in-situ measurement and/or sampling |
WM1 & WM1-C |
(*)40 scheduled |
WM2A(a) & WM2A-Cx |
40 scheduled |
||
WM2B & WM2B-C |
(*) 40 Scheduled |
||
WM3x &WM3-C |
(*) 40 scheduled |
||
Joint Site Inspection / Audit |
ET and the Contractor joint site Environmental
Inspection and Auditing |
Contract 6 |
13 |
ET, the Contractor, IEC and RE joint site
Environmental Inspection and Auditing |
3 |
Remark:
(*) Water
sampling was unable to carry
out at WM3-C, WM2B
and WM2B-C in the Reporting Period due to shallow water. Besides,
WM1-C was also unable to carry out at some of the monitoring days in the
Reporting Period due to shallow water. (Water depth under 150mm). WM4, WM4-CA
and WM4-CB were ceased after last monitoring carried out on 3 May 2021
according to Partial Termination Proposal for Contract 3 approved by EPD on 4
May 2021.
(#)
Number of air monitoring location changed to 6 since the partial termination proposal
approved by EPD on 9 Jul 2020 and 4 May 2021. Power supply for HVS for 24-hour
TSP monitoring at Location AM3 (Ta Kwu Ling Ambulance
Depot) was suspended from 1 February 2023 due to the renovation work of Ta Kwu Ling Ambulance Depot.
(~)
Number of noise monitoring location changed to 5 since the partial termination proposal
approved by EPD on 9 Jul 2020 and 4 May 2021.
Breaches
of Action/Limit levels
ES.03. In the
Reporting Period, no exceedance was recorded for construction noise, air quality
and water quality monitoring. The
summary of exceedance for the Reporting Period is shown below.
Environmental
Aspect |
Monitoring Parameters |
Action Level |
Limit Level |
Event & Action |
||
NOE Issued |
Investigation |
Corrective Actions |
||||
Air Quality |
1-hour TSP |
0 |
0 |
0 |
-- |
-- |
24-hour TSP |
0 |
0 |
0 |
-- |
-- |
|
Construction Noise |
Leq(30min) Daytime |
0 |
0 |
0 |
-- |
-- |
Water Quality |
DO |
0 |
0 |
0 |
-- |
-- |
Turbidity |
0 |
0 |
0 |
-- |
-- |
|
SS |
0 |
0 |
0 |
Environmental
Complaint
ES.04.
No environmental
complaint was recorded in the Reporting Period.
Notification of Summons and Successful Prosecutions
ES.05. No environmental summons or successful
prosecutions were recorded in the Reporting Period.
Reporting Changes
ES.06. Construction works for additional works at
Kong Yiu Channel area was completed in May 2023, thus no construction work and
waste raised of the Projects was presented in the Reporting Period. Updated
EM&A termination proposal (Revision 2) addressing EPD¡¦s comment on 28 July

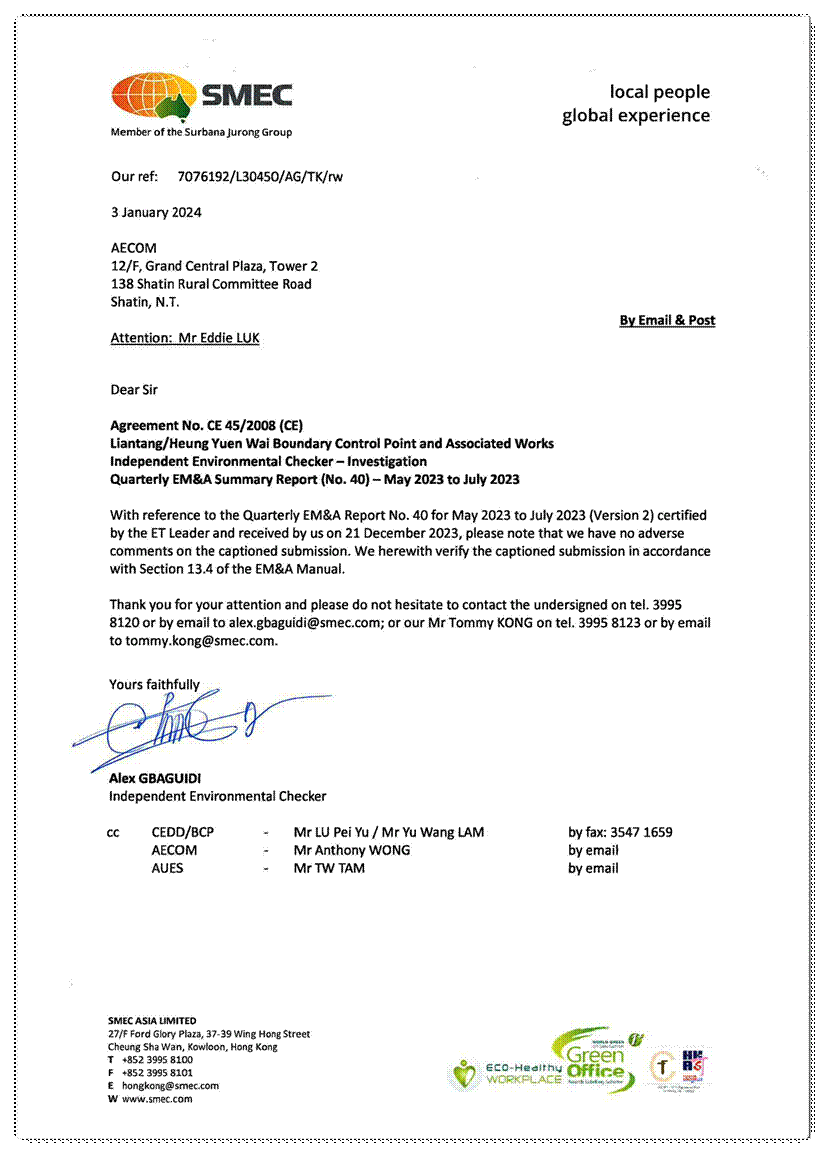

2023 was certified by ET and verified by IEC in August 2023 and the proposal
will be submitted to EPD by AECOM in Mid-August 2023.
Future key issues
ES.07. As construction work of the Project was
completed in May 2023, thus no adverse environmental issue arising from the
Project is foreseen in the future.
ES.08.
The
Contractor was reminded to implement the mitigation measure for the Operation
Phase as stipulated in the EP and the approved EIA Report.
Table of Contents
2 Project Organization and
Construction progress
2.1 Construction
Contract Packaging
2.5 Summary of Environmental Submissions
3 Project Organization and
Construction progress
