Job No.: TCS00694/13 |
|
|
||
|
|
|
|
|
||
|
|
Agreement No. CE 45/2008
(CE) Liantang/Heung Yuen Wai Boundary Control Point
and Associated Works |
|
|
||
|
|
|
|
|
||
|
|
38th Quarterly Environmental Monitoring & Audit Summary Report ¡V (November
2022 to January 2023) |
|
|
||
|
|
Prepared
For |
|
|
||
|
|
Civil Engineering and Development Department (CEDD) |
|
|
||
Quality Index |
|||
Date |
Reference No. |
Prepared By |
Certified By |
20 February 2023 |
TCS00694/13/600/R2802v1 |
|
|
Nicola
Hon (Environmental Consultant) |
T.W. Tam (Environmental Team Leader) |
Version |
Date |
Description |
1 |
20 February 2023 |
First
Submission |
|
|
|
|
|
|
|
|
|
This
report has been prepared by Action-United Environmental Services &
Consulting with all reasonable skill, care and diligence within the terms of
the Agreement with the client, incorporating our General Terms and Conditions
of Business and taking account of the resources devoted to it by agreement
with the client. We disclaim any responsibility to the client and others in
respect of any matters outside the scope of the above. This report is
confidential to the client and we accept no responsibility of whatsoever
nature to third parties to whom this report, or any part thereof, is made
known. Any such party relies upon the report at their own risk. |
Executive Summary
ES.01.
This is the 38th Quarterly
EM&A Summary Report for the ¡§Liantang/Heung Yuen Wai Boundary Control Point
and Associated Works¡¨ under Environmental Permit No. EP-404/2011/D (hereinafter ¡¥¡¥the EP¡¦¡¦), covering the period from 1 November 2022 to 31 January 2023
(hereinafter ¡§Reporting Period¡¨).
ES.02. In the
Reporting Period, the construction works under Liantang/Heung Yuen Wai
Boundary Control Point and Associated Works Contract 6. Environmental monitoring
activities under the EM&A programme in the
Reporting Period are summarized in the following table.
Environmental Aspect |
Monitoring
Parameters / Inspection |
Reporting Period |
|
Monitoring Locations
/ Contracts |
Total Occasions |
||
Air Quality |
1-hour TSP |
6 (#) |
300 |
24-hour TSP |
6 (#) |
96 |
|
Construction Noise |
Leq(30min) Daytime |
5 (~) |
68 |
Water Quality |
Water in-situ measurement and/or sampling |
WM1 & WM1-C |
(*)37 scheduled |
WM2A(a) & WM2A-Cx |
37 scheduled |
||
WM2B & WM2B-C |
(*) 37 Scheduled |
||
WM3x &WM3-C |
(*) 37 scheduled |
||
Joint Site Inspection / Audit |
ET and the Contractor joint site Environmental
Inspection and Auditing |
Contract 6 |
14 |
ET, the Contractor, IEC and RE joint site
Environmental Inspection and Auditing |
3 |
Remark:
(*) Water
sampling was unable to carry
out at WM3-C, WM2B
and WM2B-C in the Reporting Period due to shallow water. Besides,
WM1-C was also unable to carry out at some of the monitoring days in the
Reporting Period due to shallow water. (Water depth under 150mm). WM4, WM4-CA
and WM4-CB were ceased after last monitoring carried out on 3 May 2021
according to Partial Termination Proposal for Contract 3 approved by EPD on 4
May 2021.
(#)
Number of air monitoring location changed to 6 since the partial termination proposal
approved by EPD on 9 Jul 2020 and 4 May 2021.
(~)
Number of noise monitoring location changed to 5 since the partial termination proposal
approved by EPD on 9 Jul 2020 and 4 May 2021.
Breaches
of Action/Limit levels
ES.03. In the
Reporting Period, no exceedance was recorded for construction noise, air quality
and water quality monitoring. The
summary of exceedance for the Reporting Period is shown below.
Environmental
Aspect |
Monitoring Parameters |
Action Level |
Limit Level |
Event & Action |
||
NOE Issued |
Investigation |
Corrective Actions |
||||
Air Quality |
1-hour TSP |
0 |
0 |
0 |
-- |
-- |
24-hour TSP |
0 |
0 |
0 |
-- |
-- |
|
Construction Noise |
Leq(30min) Daytime |
0 |
0 |
0 |
-- |
-- |
Water Quality |
DO |
0 |
0 |
0 |
-- |
-- |
Turbidity |
0 |
0 |
0 |
-- |
-- |
|
SS |
0 |
0 |
0 |
Environmental
Complaint
ES.04.
No environmental
complaint was recorded in the Reporting Period.
Notification of Summons and Successful Prosecutions
ES.05. No environmental summons or successful
prosecutions were recorded in the Reporting Period.
Reporting Changes
ES.06. No reporting change was recorded in the
Reporting period.
Future key issues
ES.07.
Apart from the additional works at Kong Yiu Channel area, construction
works under the Project were substantial completed, the potential environmental
impacts associated with Project are considered negligible. However, the Contractor was reminded
that the environmental mitigation measures shall be properly implemented and
maintained where applicable, as per the Mitigation Implementation Schedule, in
the remaining construction period and operational phase.
ES.08.
For construction work at Kong Yiu Channel area, diversion of existing
stream courses and implementation of earth bunds were provided as water quality
mitigation measures and The Contractor was reminded that all effluent discharge
shall fulfill the requirement of Discharge Licence
under the Water Pollution Control Ordinance.
Table of Contents
2 Project Organization and
Construction progress
2.1 Construction
Contract Packaging
2.5 Summary of Environmental Submissions
3 Project Organization and
Construction progress
3.4 Monitoring
Frequency and Period
3.8 Derivation
of Action/Limit (A/L) Levels
3.9 Data
Management and Data QA/QC Control
4.2 Summary
of Monitoring Results
5 Construction Noise
Monitoring
5.2 Summary
of Monitoring Results
6.2 Summary
of Monitoring Results
7.1 Monitoring on Woodland Compensation
7.2 Monitoring on Wetland Compensation
8.2 Records
of Waste Quantities
10 Non-compliance, Complaints,
Notifications of Summons and Prosecutions
10.1 Status
of Non-compliance Environmental Complaint, Summons and Prosecution
11 Implementation Status of Mitigation
Measures
12 Conclusions and Recommendations
List
of tables
Table 2-1 Status
of Environmental Licenses and Permits of the Contracts
Table 3-1 Summary
of EM&A Requirements
Table 3-2 Impact
Monitoring Stations - Air Quality
Table 3-3 Impact
Monitoring Stations - Construction Noise
Table 3-4 Impact
Monitoring Stations - Water Quality
Table 3-5 Air
Quality Monitoring Equipment
Table 3-6 Construction
Noise Monitoring Equipment
Table 3-7 Water
Quality Monitoring Equipment
Table 3-8 Action
and Limit Levels for Air Quality Monitoring
Table 3-9 Action
and Limit Levels for Construction Noise
Table 3-10 Action
and Limit Levels for Water Quality
Table 4-1 Summary
of Air Quality Monitoring Results
Table 4-2 Summaries
of Breaches of Air Quality A/L Levels
Table 5-1 Summary
of Construction Noise Monitoring Results
Table 5-2 Summaries
of Breaches of Construction Noise A/L Levels
Table 6-1 Summary
of the Water Quality Monitoring Results ¡V Contracts 6
Table 6-2 Summary
of the Water Quality Monitoring Results ¡V Contract 6
Table 6-3 Summary
of the Water Quality Monitoring Results ¡V Contracts 6
Table 6-4 Summaries
of Breaches of the Existing Water Quality A/L Levels
Table 8-1 Summary
of Quantities of Inert C&D Materials
Table 8-2 Summary
of Quantities of C&D Wastes
Table 9-1 Summary
of Reminders/Observations of Site Inspection ¡V Contract 6
Table 10-1 Statistical
Summary of Environmental Complaints
Table 10-2 Statistical
Summary of Environmental Summons
Table 10-3 Statistical
Summary of Environmental Prosecution
List of Annexes
Appendix A Layout plan of the Project
Appendix B Environmental Management Organization Chart
Appendix C Designated Monitoring Locations as Recommended in the Approved
EM&A Manual
Appendix D Monitoring Locations for Impact Monitoring
Appendix E Event and Action Plan
Appendix F Graphical Plots for Monitoring Result
Appendix G eather information
Appendix H Waste Flow Table
Appendix I Implementation Schedule for Environmental Mitigation
Measures
Appendix J Implementation Status of mitigation measures for
Operation Phase
Appendix K Complaint Log
1.1.1. Civil Engineering and
Development Department is the Project
Proponent and the Permit Holder of Agreement No. CE 45/2008 (CE) Liantang /
Heung Yuen Wai Boundary Control Point and Associated Works, which is
a Designated Project to be implemented under Environmental Permit number EP-404/2011/C granted on 12 March
2015 and the latest Environmental Permit
number EP-404/2011/D granted on 20 January 2017.
1.1.2. The Project consists of two main
components: Construction of a Boundary Control Point (hereinafter referred as
¡§BCP¡¨); and Construction of a connecting road alignment. Layout plan of the Project is shown in Appendix A.
1.1.3. The proposed BCP is located at the
boundary with Shenzhen near the existing Chuk Yuen
Village, comprising a main passenger building with passenger and cargo
processing facilities and the associated customs, transport and ancillary
facilities. The connecting road
alignment consists of six main sections:
1)
Lin Ma Hang to Frontier Closed Area (FCA) Boundary ¡V this section
comprises at-grade and viaducts and includes the improvement works at Lin Ma
Hang Road;
2)
Ping Yeung to Wo Keng Shan ¡V this section
stretches from the Frontier Closed Area Boundary to the tunnel portal at Cheung
Shan and comprises at-grade and viaducts including an interchange at Ping
Yeung;
3)
North Tunnel ¡V this section comprises the tunnel segment at Cheung Shan
and includes a ventilation building at the portals on either end of the tunnel;
4)
Sha Tau Kok Road ¡V this section stretches from
the tunnel portal at Wo Keng Shan to the tunnel
portal south of Loi Tung and comprises at-grade and
viaducts including an interchange at Sha Tau Kok and
an administration building;
5)
South Tunnel ¡V this section comprises a tunnel segment that stretches from
Loi Tung to Fanling and
includes a ventilation building at the portals on either end of the tunnel as
well as a ventilation building in the middle of the tunnel near Lau Shui Heung;
6)
Fanling ¡V this section comprises the at-grade, viaducts
and interchange connection to the existing Fanling
Highway.
1.1.4.
Action-United Environmental Services & Consulting has been commissioned as an Independent ET to implement the
relevant EM&A programme in accordance
with the approved EM&A Manual, as well as the associated duties.
1.1.5.
This is the 38th Quarterly EM&A Summary
Report presenting the monitoring results and inspection findings for the
Reporting Period from 1 November 2022 to 31 January 2023.
1.2.1
The Quarterly EM&A Summary Report is structured into the following
sections:-
Section 1 Introduction
Section 2 Project Organization and
Construction progress
Section 3 Summary of Impact monitoring Requirements
Section 4 Air Quality Monitoring
Section 5 Construction Noise
Monitoring
Section 6 Water Quality Monitoring
Section 7 Ecology Monitoring
Section 8 Waste Management
Section 9 Site Inspection
Section 10 Non-compliance, Complaints, Notifications of
Summons and Prosecutions
Section 11 Implementation Status of Mitigation Measures
Section 12 Conclusions and Recommendations
2.1.1
To facilitate the project management and
implementation, the Project would be divided by the following contracts:
¡P
Contract 2 (CV/2012/08)
¡P
Contract 3 (CV/2012/09)
¡P
Contract 4 (NE/2014/02)
¡P
Contract 5 (CV/2013/03)
¡P
Contract 6 (CV/2013/08)
¡P
Contract 7 (NE/2014/03)
¡P
ArchSD Contract No. SS C505
2.1.2
The
details of each contracts is summarized below and the delineation of each contracts is shown in Appendix A.
Contract 2 (CV/2012/08)
2.1.3
Contract 2 has awarded in December 2013 and
construction work was commenced on 19 May 2014. Major Scope of Work of the Contract 2 is
listed below:
¡P
construction of
an approximately 5.2km long dual two-lane connecting road (with about 0.4km of
at-grade road and 4.8km of tunnel) connecting the Fanling
Interchange with the proposed Sha Tau Kok
Interchange;
¡P
construction of a
ventilation adit tunnel and the mid-ventilation
building;
¡P
construction of
the north and south portal buildings of the Lung Shan Tunnel and their
associated slope works;
¡P
provision and
installation of ventilation system, E&M works and building services works
for Lung Shan tunnel and Cheung Shan tunnel and their portal buildings;
¡P
construction of
Tunnel Administration Building adjacent to Wo Keng
Shan Road and the associated E&M and building services works; and
¡P
construction of associated
footpath, slopes, retaining structures, drainage, sewerage, waterworks,
landscaping works and other ancillary works.
Contract 3 (CV/2012/09)
2.1.4
Contract 3 was awarded in July 2013 and
construction work was commenced on 5 November 2013. Major Scope of Work of the Contract 3 is
listed below:
¡P
construction of
four link roads connecting the existing Fanling
Highway and the south portal of the Lung Shan Tunnel;
¡P
realignment of
the existing Tai Wo Service Road West and Tai Wo Service Road East;
¡P
widening of the
existing Fanling Highway (HyD¡¦s
entrustment works);
¡P
demolishing
existing Kiu Tau vehicular bridge and Kiu Tau footbridge and reconstruction of the existing Kiu Tau Footbridge (HyD¡¦s
entrustment works); and
¡P
construction of associated
footpath, slopes, retaining structures, drainage, sewerage, waterworks, landscaping
works and other ancillary works.
Contract 4 (NE/2014/02)
2.1.5
Contract 4 was awarded in mid-April 2016 and construction work will be
commenced on 2 May 2017. The scope
of work of the Contract 4 includes:
¡P
design,
supply, delivery, installation, testing and commissioning of a traffic control
and surveillance system for the connecting road linking up the Liantang / Heung Yuen Wai Boundary Control Point and the
existing Fanling Highway.
Contract 5 (CV/2013/03)
2.1.6
Contract 5 has awarded in April 2013 and
construction work was commenced in August 2013. Major Scope of Work of the Contract 5 is
listed below:
¡P
site formation of about 23
hectares of land for the development of the BCP;
¡P
construction of an
approximately 1.6 km long perimeter road at the BCP including a 175m long
depressed road;
¡P
associated
diversion/modification works at existing local roads and junctions including
Lin Ma Hang Road;
¡P
construction of pedestrian
subway linking the BCP to Lin Ma Hang Road;
¡P
provision of resite area with supporting infrastructure for reprovisioning of the affected village houses; and
¡P
construction of associated footpath, slopes, retaining structures, drainage,
sewerage, waterworks, landscaping works and other ancillary works.
Contract 6 (CV/2013/08)
2.1.7
Contract 6 was awarded in June 2015 and
construction work was commenced on 23 October 2015. Major Scope of Work of the Contract 6 would
be included below:
construction of an approximately 4.6km long dual two-lane connecting
road (with about 0.6km of at-grade road, 3.3km of viaduct and 0.7km of tunnel)
connecting the BCP with the proposed Sha Tau Kok Road
Interchange and the associated ventilation buildings;
associated diversion/modification works at access roads to the resite of Chuk Yuen Village;
provision of sewage collection, treatment and disposal facilities for
the BCP and the resite of Chuk
Yuen Village;
construction of a pedestrian subway linking the BCP to Lin Ma Hang
Road;
provisioning of the affected facilities including Wo Keng Shan Road garden; and
construction of associated
footpath, slopes, retaining structures, drainage, sewerage, waterworks,
landscaping works and other ancillary works.
Contract 7 (NE/2014/03)
2.1.8
Contract 7 was awarded in December 2015 and
the construction work was commenced 15 February 2016. Major Scope of Work of the Contract 7 would
be included below:
construction of the Hong Kong Special
Administrative Region (HKSAR) portion of four vehicular bridge
construction of one
pedestrian bridge crossing Shenzhen (SZ) River (cross boundary bridges)
ArchSD Contract No. SS C505
2.1.9
SS C505 has been awarded in July 2015 and
construction work was commenced on 1 September 2015. Major Scope of Work of the SS C505 would
be included below:
passenger-related facilities including
processing kiosks and examination facilities for private cars and coaches,
passenger clearance building and halls, the interior fitting works for the
pedestrian bridge crossing Shenzhen River, etc.;
cargo processing facilities including kiosks
for clearance of goods vehicles, customs inspection platforms, X-ray building,
etc.;
accommodation for the facilities inside of the
Government departments providing services in connection with the BCP;
transport-related facilities inside the BCP
including road networks, public transport interchange, transport drop-off and
pick-up areas, vehicle holding areas and associated road furniture etc;
a public carpark; and
other ancillary
facilities such as sewerage and drainage, building services provisions and
electronic systems, associated environmental mitigation measure and landscape
works.
2.2.1
The project organization is shown in Appendix B. The responsibilities of respective parties are:
Civil
Engineering and Development Department (CEDD)
2.2.2
CEDD is the Project Proponent and the Permit Holder of the EP of the development
of the Project and will assume overall responsibility for the project. An
Independent Environmental Checker (IEC) shall be employed by CEDD to audit the
results of the EM&A works carried out by the ET.
Architectural
Services Department (ArchSD)
2.2.3
ArchSD acts as
the works agent for Development Bureau (DEVB), for Contract SS C505 Liantang/ Heung Yuen Wai Boundary Control Point (BCP) ¡V BCP
Buildings and Associated Facilities.
Environmental
Protection Department (EPD)
2.2.4
EPD is the statutory enforcement body for
environmental protection matters in Hong Kong.
Ronald Lu
& Partners (Hong Kong) Ltd (The Architect)
2.2.5
Ronald Lu & Partners (Hong Kong) Ltd is
appointed by ArchSD as an Architect for Contract SS
C505 Liantang/ Heung Yuen Wai Boundary Control Point
(BCP) ¡V BCP Buildings and Associated Facilities. It responsible for overseeing the
construction works of Contract SS C505 and for ensuring that the works are
undertaken by the Contractor in accordance with the specification and contract
requirements. The duties and responsibilities of the Architect with respect to
EM&A are:
Monitor the Contractors¡¦ compliance with
contract specifications, including the implementation and operation of the
environmental mitigation measures and their effectiveness
Monitor Contractors¡¦ and ET¡¦s compliance with
the requirements in the Environmental Permit (EP) and EM&A Manual
Facilitate ET¡¦s implementation of the EM&A
programme
Participate in joint site inspection by the ET
and IEC
Oversee the implementation of the agreed Event
/ Action Plan in the event of any exceedance
Adhere to the procedures for carrying out
complaint investigation
Liaison with DSD, Engineer/Engineer¡¦s
Representative, ET, IEC and the Contractor of the ¡§Construction of the DSD¡¦s
Regulation of Shenzhen River Stage 4 (RSR 4)¡¨ Project discussing regarding the
cumulative impact issues.
Engineer
or Engineers Representative (ER)
2.2.6
The ER is responsible for overseeing the
construction works and for ensuring that the works are undertaken by the
Contractor in accordance with the specification and contract requirements. The
duties and responsibilities of the ER with respect to EM&A are:
¡P
Monitor the Contractors¡¦ compliance with
contract specifications, including the implementation and operation of the
environmental mitigation measures and their effectiveness
¡P
Monitor Contractors¡¦s,
ET¡¦s and IEC¡¦s compliance with the requirements in the Environmental Permit
(EP) and EM&A Manual
¡P
Facilitate ET¡¦s implementation of the
EM&A programme
¡P
Participate in joint site inspection by the
ET and IEC
¡P
Oversee the implementation of the agreed
Event / Action Plan in the event of any exceedance
¡P
Adhere to the procedures for carrying out
complaint investigation
¡P
Liaison with DSD, Engineer/Engineer¡¦s
Representative, ET, IEC and the Contractor of the ¡§Construction of the DSD¡¦s Regulation
of Shenzhen River Stage 4 (RSR 4)¡¨ Project discussing regarding the cumulative
impact issues.
The
Contractor(s)
2.2.7
There will be one contractor for each
individual works contract. The
Contractor(s) should report to the ER. The duties and responsibilities of the
Contractor are:
¡P
Comply with the relevant contract conditions
and specifications on environmental protection
¡P
Employ an Environmental Team (ET) to
undertake monitoring, laboratory analysis and reporting of EM &A Facilitate
ET¡¦s monitoring and site inspection activities
¡P
Participate in the site inspections by the ET
and IEC, and undertake any corrective actions
¡P
Provide information / advice to the ET
regarding works programme and activities which may
contribute to the generation of adverse environmental impacts
¡P
Submit proposals on mitigation measures in
case of exceedances of Action and Limit levels in accordance with the Event /
Action Plans
¡P
Implement measures to reduce impact where
Action and Limit levels are exceeded
¡P
Adhere to the procedures for carrying out
complaint investigation
Environmental Team (ET)
2.2.8
One ET will be employed for this Project. The ET shall not be in any way an
associated body of the Contractor(s), and shall be employed by the Project
Proponent/Contractor to conduct the EM&A programme.
The ET should be managed by the ET
Leader. The ET Leader shall be a person who has at least 7 years¡¦ experience in
EM&A and has relevant professional qualifications. Suitably qualified staff
should be included in the ET, and resources for the implementation of the
EM&A programme should be allocated in time under
the Contract(s), to enable fulfillment of the Project¡¦s EM&A requirements
as specified in the EM&A Manual during construction of the Project. The ET shall report to the Project
Proponent and the duties shall include:
¡P
Monitor and audit various environmental
parameters as required in this EM&A Manual
¡P
Analyse the
environmental monitoring and audit data, review the success of EM&A programme and the adequacy of mitigation measures
implemented, confirm the validity of the EIA predictions and identify any
adverse environmental impacts arising
¡P
Carry out regular site inspection to
investigate and audit the Contractors¡¦ site practice, equipment/plant and work
methodologies with respect to pollution control and environmental mitigation,
and effect proactive action to pre-empt problems
¡P
Monitor compliance with conditions in the EP,
environmental protection, pollution prevention and control regulations and
contract specifications
¡P
Audit environmental conditions on site
¡P
Report on the environmental monitoring and
audit results to EPD, the ER, the lEC and Contractor(s) or their delegated representatives
¡P
Recommend suitable mitigation measures to the
Contractor in the case of exceedance of Action and Limit levels in accordance
with the Event and Action Plans
¡P
Liaise with the IEC on all environmental
performance matters and timely submit all relevant EM&A proforma
for approval by IEC
¡P
Advise the Contractor(s) on environmental
improvement, awareness, enhancement measures etc., on site
¡P
Adhere to the procedures for carrying out
complaint investigation
¡P
Liaison with the client departments,
Engineer/Engineer¡¦s Representative, ET, lEC and the
Contractor(s) of the concurrent projects as listed under Section 2.3 below
regarding the cumulative impact issues.

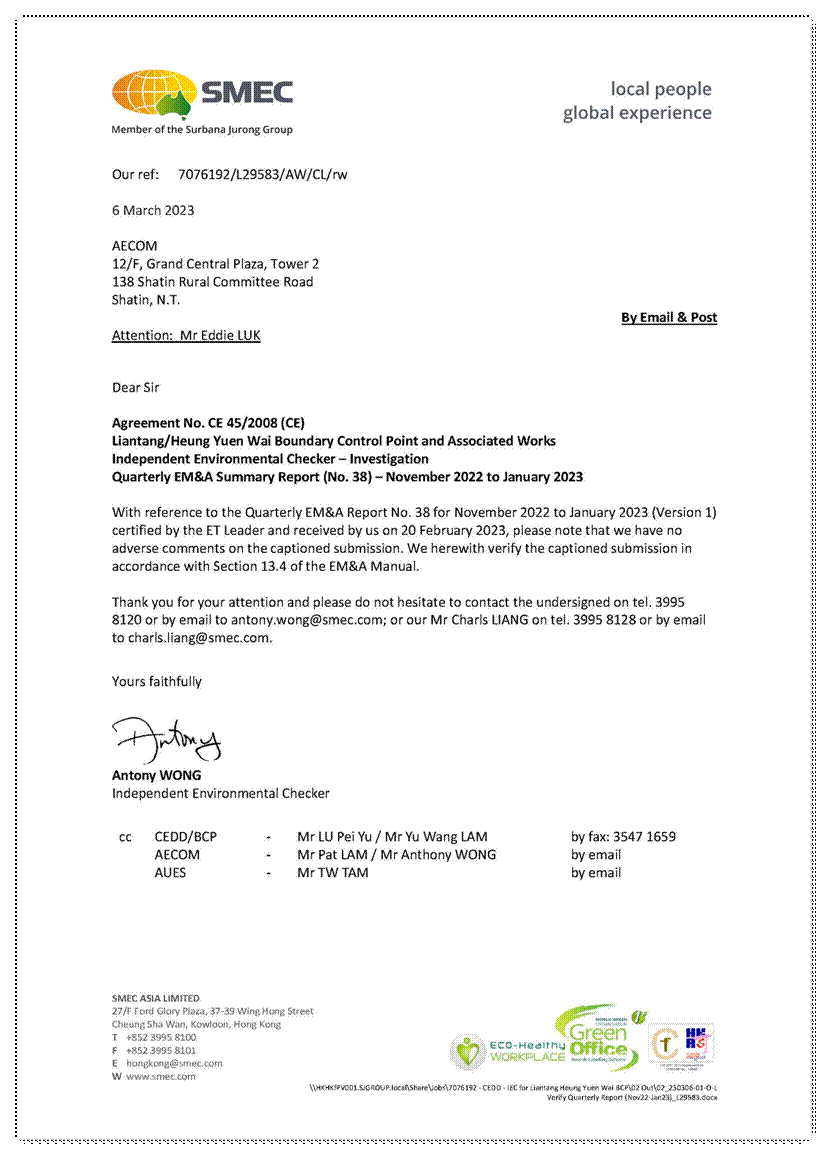

Independent Environmental Checker (IEC)
2.2.9
One IEC will be employed for this Project. The Independent Environmental Checker
(IEC) should not be in any way an associated body of the Contractor(s) or the
ET for the Project. The IEC should
be employed by the Permit Holder (i.e., CEDD) prior to
the commencement of the construction of the Project. The IEC should have at least 10 years¡¦
experience in EM&A and have relevant professional qualifications. The duty of IEC should be:
¡P
Provide proactive advice to the ER and the
Project Proponent on EM&A matters related to the project, independent from
the management of construction works, but empowered to audit the environmental
performance of construction
¡P
Review and audit all aspects of the EM&A programme implemented by the ET
¡P
Review and verify the monitoring data and all
submissions in connection with the EP and EM&A Manual submitted by the ET
¡P
Arrange and conduct regular, at least monthly
site inspections of the works during construction phase, and ad hoc inspections
if significant environmental problems are identified
¡P
Check compliance with the agreed Event /
Action Plan in the event of any exceedance
¡P
Check compliance with the procedures for
carrying out complaint investigation
¡P
Check the effectiveness of corrective
measures
¡P
Feedback audit results to ET by signing off
relevant EM&A proforma
¡P
Check that the mitigation measures are
effectively implemented
¡P
Report the works conducted, the findings,
recommendation and improvement of the site inspections, after reviewing ET¡¦s
and Contractor¡¦s works, and advices to the ER and Project Proponent on a
monthly basis
¡P
Liaison with the client departments,
Engineer/Engineer¡¦s Representative, ET, lEC and the
Contractor(s) of the concurrent projects as listed under Section 2.3 below
regarding the cumulative impact issues.
2.3.1
The concurrent construction works that may be
carried out include, but not limited to, the following:
(a)
Regulation of Shenzhen River Stage IV;
(b)
Widening of Fanling
Highway ¡V Tai Hang to Wo Hop Shek
Interchange ¡V Contract No. HY/2012/06;
(c)
Construction of BCP facilities in Shenzhen.
2.4.1
Following the partial commencement of the
Project, the major construction works under the Project were substantially
completed. Proposal for partial
termination of the construction phase EM&A programme
for Contracts 2, 4, 7 and SS C505 was approved by EPD on 9 July 2020 (EPD¡¦s
ref.: ( ) in Ax (3) to EP 2/N7/A/52 Pt.17). Moreover, termination proposal for Contract
3 was approved by EPD on 4 May 2021 (EPD¡¦s ref.: () in Ax (3) to EP 2/N7/A52
Pt.18).
Contract 6 (CV/2013/08)
2.4.2
Contract 6 has awarded in June 2015 and
construction work was commenced on 23 October 2015. In this Reporting Period,
construction activities conducted are listed below:
Construction of
Flood Walls and Vehicular Maintenance Ramp near Kong Yiu Channel
2.5.1
In according to the EP, the required
documents have submitted to EPD which listed in below:
Project Layout Plans of Contracts 2, 3, 4, 5,
6, 7 and SS C505
Landscape Plan
Topsoil Management Plan
Environmental Monitoring and Audit Programme
Baseline Monitoring Report
(TCS00690/13/600/R0030v3) for the Project
Waste Management Plan of the Contracts 2, 3, 4,
5, 6, 7 and SS C505
Contamination Assessment Plan (CAP) and
Contamination Assessment Report (CAR) for Po Kat Tsai, Loi
Tung and the workshops in Fanling
Vegetation Survey Report
Woodland Compensation Plan
Habitat Creation Management Plan
2.5.2
Summary of
the relevant permits, licenses, and/or notifications on environmental
protection for the Project of each contracts are presented in Table 2-1.
Table
2-1 Status
of Environmental Licenses and Permits of the Contracts
Item |
Description |
License/Permit
Status |
||
Ref.
no. |
Effective Date |
Expiry Date |
||
Contract 6 |
||||
1 |
Air
pollution Control (Construction Dust) Regulation |
Ref. No: 390614 |
29 Jun 2015 |
Till the
end of Contract |
2 |
Chemical
Waste Producer Registration |
Waste Producers Number
No.: 5213-652-C3969-01 |
31 Aug 2015 |
Till the
end of Contract |
3 |
Water
Pollution Control Ordinance - Discharge License |
WT00041417-2022 |
20 Jun 2022 |
Valid
until 30 Jun 2027 |
4 |
Waste Disposal
Regulation - Billing Account for Disposal of Construction Waste |
Account No. 7022707 |
9 Jul 2015 |
Till the
end of Contract |
5 |
Construction Noise
Permit |
GW-RN0825-22 |
3 Oct
2022 |
2 Jan
2023 |
GW-RN1135-22 |
3 Jan
2023 |
2 May
2023 |
3.1.1
The Environmental Monitoring and Audit
requirements are set out in the Approved EM&A manual. Environmental issues
such as air quality, construction noise and water quality were identified as
the key issues during the construction phase of the Project.
3.1.2
A summary of construction phase EM&A
requirements are presented in the sub-sections
below.
3.2.1
The EM&A program of construction phase
monitoring shall cover the following environmental issues:
•
Air quality;
•
Construction noise; and
•
Water quality
3.2.2
A summary of the monitoring parameters is
presented in Table 3-1.
Table 3-1 Summary
of EM&A Requirements
