|
|
|
||||
|
|
|
||||
|
|
|
||||
|
|
Job No.: TCS00694/13 |
|
|
||
|
|
|
|
|
||
|
|
Agreement No. CE 45/2008
(CE) Liantang/ Heung Yuen Wai
Boundary Control Point
and Associated Works |
|
|
||
|
|
|
|
|
||
|
|
Monthly Environmental Monitoring and Audit Report
(No.80) ¡V March 2020 |
|
|
||
|
|
Prepared For |
|
|
||
|
|
Civil Engineering and Development Department (CEDD) |
|
|
||
Date |
Reference No. |
Prepared By |
Certified By |
14 April 2020 |
TCS00694/13/600/R2380v2 |
|
|
Nicola Hon (Environmental Consultant) |
Tam Tak Wing (Environmental Team Leader) |
Version |
Date |
Remarks |
1 |
8 April 2020 |
First
Submission |
2 |
14 April 2020 |
Amended
against IEC¡¦s comment |
|
|
|
executive summary
ES01
This is the 80th monthly EM&A
report presenting the monitoring results and inspection findings for the reporting period from 1 to 31 March 2020 (hereinafter ¡¥the
Reporting Period¡¦).
Environmental
Monitoring and Audit Activities
ES02
To facilitate the project management and
implementation, Liantang/Heung Yuen Wai Boundary Control Point and Associated Works of the
Project is divided to seven CEDD contracts including Contract 2 (CV/2012/08),
Contract 3 (CV/2012/09), Contract 4 (NE/2014/02),
Contract 5 (CV/2013/03), Contract 6 (CV/2013/08) and Contract 7 (NE/2014/03)
and an ArshSD contract (Contract SS C505).
ES03
In the Reporting Period, the major
construction works under Liantang/ Heung Yuen Wai
Boundary Control Point and Associated Works of the Project
included Contract 2, Contract 3, Contract 4, Contract
6, Contract 7 and Contract SS C505.
Environmental monitoring activities under the EM&A programme in the Reporting Period are summarized in the
following table.
Environmental Aspect |
Environmental Monitoring Parameters /
Inspection |
Reporting Period |
|
Number of Monitoring Locations to undertake |
Total Occasions |
||
Air Quality |
1-hour
TSP |
9 |
135 |
24-hour
TSP |
9 |
45 |
|
Construction Noise |
Leq(30min) Daytime |
10 |
40 |
Water Quality |
Water in-situ measurement and/or sampling |
WM1
& WM1-C |
13 Scheduled &
0 extra |
WM2A(a)
& WM2A-Cx |
13 Scheduled &
0 extra |
||
WM2B
& WM2B-C |
13 Scheduled &
0 extra (*) |
||
WM3x
&WM3-C |
13 Scheduled &
0 extra (*) |
||
WM4,
WM4-CA &WM4-CB |
13 Scheduled &
0 extra |
||
Ecology |
Woodland
compensation i)
General Health condition of planted species ii) Survival
of planted species |
9
Quadrats and transect |
0 |
Wetland compensation i)
Site inspection |
Contract
6 |
4 |
|
Joint Site Inspection / Audit |
IEC, ET,
the Contractor and RE joint site Environmental Inspection and Auditing |
Contract
2 |
4 |
Contract
3 |
4 |
||
Contract
4 |
4 |
||
Contract
6 |
4 |
||
Contract
7 |
4 |
||
Contract
SS C505 |
4 |
Remark: (*)Water
sampling was unable to
carry out at WM2B, WM2B-C and WM3-C in the Reporting Period due to shallow
water (water depth under 150mm).
Action and Limit (A/L) Levels exceedance
ES04
In the Reporting Period, no exceedance was recorded for construction noise, air quality and water quality monitoring. The summary of
exceedance in the Reporting Period is shown below.
Environmental Aspect |
Monitoring
Parameters |
Action Level |
Limit Level |
Event
& Action |
|||
NOE
Issued |
Investigation
Result |
Project
related exceedance |
Corrective
Actions |
||||
Air Quality |
1-hour TSP |
0 |
0 |
0 |
-- |
-- |
-- |
24-hour TSP |
0 |
0 |
0 |
-- |
-- |
-- |
|
Construction Noise |
Leq(30min) Daytime |
0 |
0 |
0 |
-- |
-- |
-- |
Water Quality |
DO |
0 |
0 |
0 |
-- |
-- |
-- |
Turbidity |
0 |
0 |
0 |
-- |
-- |
||
SS |
0 |
0 |
0 |
Environmental
Complaint
ES05
In this Reporting Period,
one environmental complaint was received regarding night time construction work
(at about 2330 ¡V 0300 hrs) and construction dust nuisance related to Contract 6. The investigation report was conducted by
ET accordingly and revealed that there were no construction activities under
Contract 6 during the concerned period and it is considered that the complaint was
no valid to Contract 6.
Notification
of Summons and Successful Prosecutions
ES06
No environmental summons
and prosecutions were recorded in the Reporting Period.
Reporting Change
ES07
No reporting
change was recorded in the Reporting period.
Site Inspection
ES08
In this Reporting Period, joint site inspection to evaluate the site
environmental performance at Contract 2 has been
carried out by the RE, ET and the Contractor on 6, 13, 20 and 27 March
2020 in which IEC joined the site inspection on 20 March
2020. No non-compliance was noted during the site inspection.
ES09
In the Reporting Period, joint site
inspection to evaluate the site environmental performance at Contract
3 has been carried out by the RE, ET and the Contractor on 5, 13, 19 and 25 March
2020 in which IEC joined the site inspection on 19 March
2020. No non-compliance was noted during the site inspection.
ES10
In the Reporting Period, joint site
inspection to evaluate
the site environmental performance at Contract 4 has been
carried out by the RE, ET and the Contractor on 6, 13, 16 and 27 March
2020 in which IEC joined the site inspection on 16 March
2020. No non-compliance was noted during the site inspection.
ES11
In the Reporting Period, joint site
inspection to evaluate the site environmental performance at Contract
6 has been carried out by the RE, ET and the Contractor on 5, 12, 17 and 26 March
2020 in which IEC joined the site inspection on 17 March
2020. No non-compliance was noted during the site inspection.
ES12
In the Reporting Period, joint site
inspection to evaluate the site environmental performance at Contract
7 has been carried out by the RE, ET and the Contractor on 5, 12, 17 and 26 March
2020 in which IEC joined the site inspection on 17 March
2020. No non-compliance was noted during the site inspection.
ES13
In the Reporting Period, joint site
inspection to evaluate the site environmental performance at Contract
SS C505 has been carried out by the RE, ET and the Contractor on 5, 12, 20 and 26 March
2020. IEC carried
out site inspection on 20 March 2020. No non-compliance was noted during the site inspection.
Future Key Issues
ES14
As wet season is approaching, preventive measures for muddy water or other
water pollutants from site surface flow to local stream such as Kong Yiu Channel, Ma Wat Channel, Ping
Yuen River, Kwan Tei River or public area should be
properly maintained. The
Contractors should paid special attention on water quality mitigation measures and
fully implement according ISEMM of the EM&A Manual.
ES15
In addition, all
effluent discharge shall be ensure to fulfill Technical Memorandum of Effluent
Discharged into Drainage and Sewerage Systems, inland and Coastal Waters
criteria or discharge permits stipulation.
ES16
Construction noise would be a key
environmental issue during construction work of the Project. Noise mitigation measures such as using
quiet plants should be implemented in accordance with the EM&A requirement.
Table of Contents
2 Project
Organization and Construction progress
2.1 Construction
Contract Packaging
2.5 Summary of Environmental Submissions
3 Summary
of Impact Monitoring Requirements
3.4 Monitoring
Frequency and Period
3.8 Derivation
of Action/Limit (A/L) Levels
3.9 Data
Management and Data QA/QC Control
4.2 Air
Quality Monitoring Results
5 Construction
Noise Monitoring
6.2 Results
of Water Quality Monitoring
7.1 Monitoring on Woodland Compensation
7.2 Monitoring on Wetland Compensation
8.2 Records
of Waste Quantities
9.2 Findings
/ Deficiencies During the Reporting Month
10 Environmental
Complaint and Non-Compliance
10.1 Environmental
Complaint, Summons and Prosecutions
11 Implementation
Status of Mitigation Measures
11.2 Tentative
Construction Activities in the Coming Month
11.3 Key
Issues for the Coming Month
12 Conclusions
and Recommendations
List
of TABLES
Table 2-1 Status
of Environmental Licenses and Permits of the Contracts
Table 3-1 Summary
of EM&A Requirements
Table 3-2 Impact
Monitoring Stations - Air Quality
Table 3-3 Impact
Monitoring Stations - Construction Noise
Table 3-4 Impact
Monitoring Stations - Water Quality
Table 3-5 Air
Quality Monitoring Equipment
Table 3-6 Construction
Noise Monitoring Equipment
Table 3-7 Water
Quality Monitoring Equipment
Table 3-8 Action
and Limit Levels for Air Quality Monitoring
Table 3-9 Action
and Limit Levels for Construction Noise
Table 3-10 Action and Limit
Levels for Water Quality
Table 4-1 Summary
of 24-hour and 1-hour TSP Monitoring Results ¡V AM1c
Table 4-2 Summary
of 24-hour and 1-hour TSP Monitoring Results ¡V AM2
Table 4-3 Summary
of 24-hour and 1-hour TSP Monitoring Results ¡V AM3
Table 4-4 Summary
of 24-hour and 1-hour TSP Monitoring Results ¡V AM4b
Table 4-5 Summary
of 24-hour and 1-hour TSP Monitoring Results ¡V AM5a
Table 4-6 Summary
of 24-hour and 1-hour TSP Monitoring Results ¡V AM6
Table 4-7 Summary
of 24-hour and 1-hour TSP Monitoring Results ¡V AM7b
Table 4-8 Summary
of 24-hour and 1-hour TSP Monitoring Results ¡V AM8
Table 4-9 Summary
of 24-hour and 1-hour TSP Monitoring Results ¡V AM9b
Table 5-1 Summary
of Construction Noise Monitoring Results
Table 5-2 Summary
of Construction Noise Monitoring Results
Table 6-1 Water
Quality Monitoring Results Associated of Contracts 2 and 3
Table 6-2 Water
Quality Monitoring Results Associated of Contracts 6 and SS C505
Table 6-3 Water
Quality Monitoring Results Associated only Contract 6
Table 6-4 Water
Quality Monitoring Results Associated Contracts 2 and 6
Table 6-5 Action
and Limit (A/L) Levels Exceedance Recorded
Table 8-1 Summary
of Quantities of Inert C&D Materials for the Project
Table 8-2 Summary
of Quantities of C&D Wastes for the Project
Table 9-1 Site
Observations for Contract 2
Table 9-2 Site
Observations for Contract 3
Table 9-3 Site
Observations for Contract 4
Table 9-4 Site Observations
for Contract 6
Table 9-5 Site
Observations for Contract SS C505
Table 9-6 Site
Observations for Contract 7
Table 10-1 Statistical
Summary of Environmental Complaints
Table 10-2 Statistical
Summary of Environmental Summons
Table 10-3 Statistical
Summary of Environmental Prosecutions
Table 11-1 Environmental
Mitigation Measures
List of Appendices
Appendix
A Layout Plan of the
Project
Appendix
B Organization Chart
Appendix
C 3-month rolling
construction program
Appendix
D Designated Monitoring
Locations as Recommended in the Approved EM&A Manual
Appendix
E Monitoring
Locations for Impact Monitoring
Appendix
F Calibration
Certificate of Monitoring Equipment and HOKLAS-accreditation Certificate of the
Testing Laboratory
Appendix
G Event and Action
Plan
Appendix
H Impact Monitoring
Schedule
Appendix
I Database of
Monitoring Result
Appendix
J Graphical
Plots for Monitoring Result
Appendix K Meteorological
Data
Appendix L Photographic
record for site inspection at Wetland Compensation Area
Appendix M Waste Flow Table
Appendix N Investigation
Report for exceedance
Appendix O Implementation
Schedule for Environmental Mitigation Measures
Appendix P Implementation
Status of Mitigation Measures for Operation Phase
Appendix Q Implementation
Status of water quality mitigation measures
Appendix R Investigation
Report for Complaint
1.1.1
Civil Engineering and Development Department is the Project Proponent and the Permit Holder of Agreement No. CE 45/2008 (CE) Liantang / Heung Yuen Wai Boundary Control Point and
Associated Works, which is a Designated Project to be implemented under
Environmental Permit number EP-404/2011/D
granted on 20 January 2017.
1.1.2
The Project consists of two main components: Construction of a Boundary
Control Point (hereinafter referred as ¡§BCP¡¨); and Construction of a connecting
road alignment. Layout plan of the Project is shown in Appendix A.
1.1.3
The proposed BCP is located at the boundary with Shenzhen near the
existing Chuk Yuen Village, comprising a main
passenger building with passenger and cargo processing facilities and the
associated customs, transport and ancillary facilities. The connecting road alignment consists
of six main sections:
1)
Lin Ma Hang to Frontier Closed Area (FCA) Boundary ¡V this section
comprises at-grade and viaducts and includes the improvement works at Lin Ma
Hang Road;
2)
Ping Yeung to Wo Keng Shan ¡V this section
stretches from the Frontier Closed Area Boundary to the tunnel portal at Cheung
Shan and comprises at-grade and viaducts including an interchange at Ping
Yeung;
3)
North Tunnel ¡V this section comprises the tunnel segment at Cheung Shan
and includes a ventilation building at the portals on either end of the tunnel;
4)
Sha Tau Kok Road ¡V this section stretches from
the tunnel portal at Wo Keng Shan to the tunnel
portal south of Loi Tung and comprises at-grade and
viaducts including an interchange at Sha Tau Kok and
an administration building;
5)
South Tunnel ¡V this section comprises a tunnel segment that stretches from
Loi Tung to Fanling and
includes a ventilation building at the portals on either end of the tunnel as
well as a ventilation building in the middle of the tunnel near Lau Shui Heung;
6)
Fanling ¡V this section comprises the at-grade, viaducts
and interchange connection to the existing Fanling
Highway.
1.1.4
Action-United Environmental
Services & Consulting has been
commissioned as an Independent ET to implement the relevant EM&A
program in accordance with the approved
EM&A Manual, as well as the associated duties. As part of the EM&A program,
the baseline monitoring has carried out between 13 June 2013 and 12 July
2013 for all parameters including air quality, noise and water quality
before construction work commencement.
The Baseline Monitoring Report summarized the key findings and the

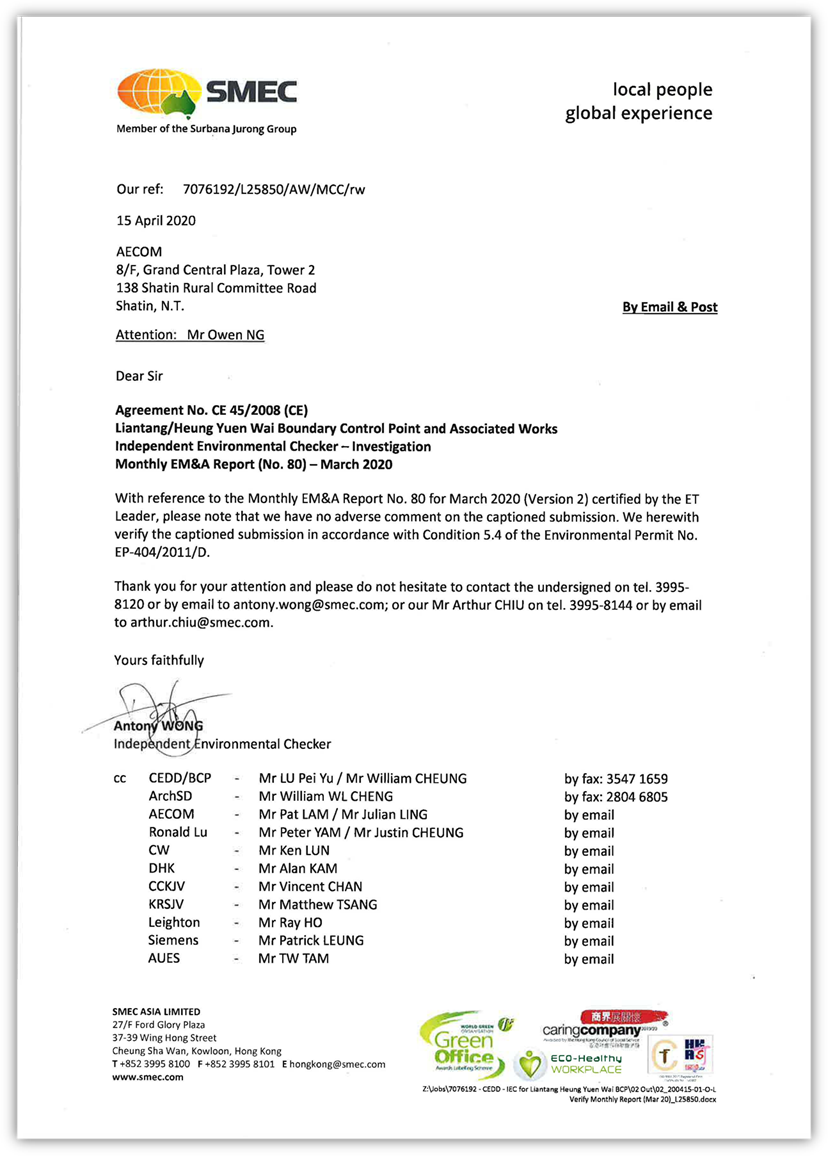

rationale behind determining a set of Action and Limit Levels (A/L Levels) from
the baseline data. Also, the
Project baseline monitoring report which verified by the IEC has been submitted
to EPD on 16 July 2013 for
endorsement. The major construction
works of the Project was commenced on 16
August 2013 in accordance with the EP Section 5.3 stipulation.
1.1.5
This is 80th monthly EM&A
report presenting the monitoring results and inspection findings for reporting period from 1 to 31 March 2020.
1.2.1
The Monthly Environmental Monitoring and
Audit (EM&A) Report is structured into the following sections:-
Section 1 Introduction
Section 2 Project Organization and Construction
Progress
Section 3 Summary
of Impact Monitoring Requirements
Section 4 Air Quality Monitoring
Section 5 Construction Noise Monitoring
Section 6 Water Quality Monitoring
Section 7 Ecology Monitoring
Section 8 Waste Management
Section 9 Site Inspections
Section 10 Environmental
Complaints and Non-Compliance
Section 11 Implementation
Status of Mitigation Measures
Section 12 Conclusions
and Recommendations
2.1.1
To
facilitate the project management and implementation, the Project would be
divided by the following contracts:
¡P
Contract 2 (CV/2012/08)
¡P
Contract 3 (CV/2012/09)
¡P
Contract 4 (NE/2014/02)
¡P
Contract 5 (CV/2013/03)
¡P
Contract 6 (CV/2013/08)
¡P
Contract 7 (NE/2014/03)
¡P
ArchSD Contract No. SS C505
2.1.2
The
details of each contracts is summarized below and the delineation of each contracts is shown in Appendix A.
Contract 2 (CV/2012/08)
2.1.3
Contract 2 has awarded in December 2013 and
construction work was commenced on 19 May 2014. Major Scope of Work of the Contract 2 is
listed below:
¡P
construction of
an approximately 5.2km long dual two-lane connecting road (with about 0.4km of
at-grade road and 4.8km of tunnel) connecting the Fanling
Interchange with the proposed Sha Tau Kok
Interchange;
¡P
construction of a
ventilation adit tunnel and the mid-ventilation building;
¡P
construction of
the north and south portal buildings of the Lung Shan Tunnel and their
associated slope works;
¡P
provision and
installation of ventilation system, E&M works and building services works
for Lung Shan tunnel and Cheung Shan tunnel and their portal buildings;
¡P
construction of
Tunnel Administration Building adjacent to Wo Keng
Shan Road and the associated E&M and building services works; and
¡P
construction of associated
footpath, slopes, retaining structures, drainage, sewerage, waterworks,
landscaping works and other ancillary works.
Contract 3 (CV/2012/09)
2.1.4
Contract 3 was awarded in July 2013 and
construction work was commenced on 5 November 2013. Major Scope of Work of the Contract 3 is
listed below:
¡P
construction of
four link roads connecting the existing Fanling
Highway and the south portal of the Lung Shan Tunnel;
¡P
realignment of
the existing Tai Wo Service Road West and Tai Wo Service Road East;
¡P
widening of the
existing Fanling Highway (HyD¡¦s
entrustment works);
¡P
demolishing
existing Kiu Tau vehicular bridge and Kiu Tau footbridge and reconstruction of the existing Kiu Tau Footbridge (HyD¡¦s
entrustment works); and
¡P
construction of associated
footpath, slopes, retaining structures, drainage, sewerage, waterworks,
landscaping works and other ancillary works.
Contract 4 (NE/2014/02)
2.1.5
Contract
4 has awarded in mid-April 2016 and
construction work was commenced
on 2 May 2017. The scope of work of the Contract 4
includes:
¡P
design, supply,
delivery, installation, testing and commissioning of a traffic control and
surveillance system for the connecting road linking up the Liantang
/ Heung Yuen Wai Boundary Control Point and the existing Fanling
Highway.
Contract 5 (CV/2013/03)
2.1.6
Contract 5 has awarded in April 2013 and
construction work was commenced in August 2013. Major Scope of Work of the Contract 5 is
listed below:
¡P
site formation of about 23
hectares of land for the development of the BCP;
¡P
construction of an
approximately 1.6 km long perimeter road at the BCP including a 175m long depressed
road;
¡P
associated
diversion/modification works at existing local roads and junctions including
Lin Ma Hang Road;
¡P
construction of pedestrian
subway linking the BCP to Lin Ma Hang Road;
¡P
provision of resite area with supporting infrastructure for reprovisioning of the affected village houses; and
¡P
construction of associated footpath, slopes, retaining structures, drainage,
sewerage, waterworks, landscaping works and other ancillary works.
Contract 6 (CV/2013/08)
2.1.7
Contract 6 has awarded in June 2015 and
construction work was commenced on 23 October 2015. Major Scope of Work of the Contract 6 would
be included below:
construction of an approximately 4.6km long dual two-lane connecting
road (with about 0.6km of at-grade road, 3.3km of viaduct and 0.7km of tunnel)
connecting the BCP with the proposed Sha Tau Kok Road
Interchange and the associated ventilation buildings;
associated diversion/modification works at access roads to the resite of Chuk Yuen Village;
provision of sewage collection, treatment and disposal facilities for
the BCP and the resite of Chuk
Yuen Village;
construction of a pedestrian subway linking the BCP to Lin Ma Hang
Road;
provisioning of the affected facilities including Wo Keng Shan Road garden; and
construction of associated footpath, slopes, retaining
structures, drainage, sewerage, waterworks, landscaping works and other
ancillary works.
Contract 7 (NE/2014/03)
2.1.8
Contract 7 has awarded in December 2015 and
the construction works of Contract 7 was commenced on 15 February 2016. Major Scope of Work of the Contract 7 would
be included below:
construction of the Hong Kong Special
Administrative Region (HKSAR) portion of four vehicular bridge
construction of one pedestrian bridge crossing Shenzhen (SZ) River
(cross boundary bridges)
ArchSD Contract No. SS
C505
2.1.9
SS C505 has awarded in July 2015 and
construction work was commenced on 1 September 2015. Major Scope of Work of the SS C505 would
be included below:
passenger-related facilities including
processing kiosks and examination facilities for private cars and coaches,
passenger clearance building and halls, the interior fitting works for the pedestrian
bridge crossing Shenzhen River, etc.;
cargo processing facilities including kiosks
for clearance of goods vehicles, customs inspection platforms, X-ray building,
etc.;
accommodation for the facilities inside of the
Government departments providing services in connection with the BCP;
transport-related facilities inside the BCP
including road networks, public transport interchange, transport drop-off and
pick-up areas, vehicle holding areas and associated road furniture etc;
a public carpark; and
other ancillary
facilities such as sewerage and drainage, building services provisions and
electronic systems, associated environmental mitigation measure and landscape
works.
2.2.1
The project organization is shown in Appendix B. The responsibilities
of respective parties are:
Civil
Engineering and Development Department (CEDD)
2.2.2
CEDD is the Project Proponent and the Permit Holder of the EP of the development
of the Project and will assume overall responsibility for the project. An Independent
Environmental Checker (IEC) shall be employed by CEDD to audit the results of
the EM&A works carried out by the ET.
Architectural
Services Department (ArchSD)
2.2.3
ArchSD acts as
the works agent for Development Bureau (DEVB), for Contract SS C505 Liantang/ Heung Yuen Wai Boundary Control Point (BCP) ¡V BCP
Buildings and Associated Facilities.
Environmental
Protection Department (EPD)
2.2.4
EPD is the statutory enforcement body for
environmental protection matters in Hong Kong.
Ronald Lu
& Partners (Hong Kong) Ltd (The Architect)
2.2.5
Ronald Lu & Partners (Hong Kong) Ltd is
appointed by ArchSD as an Architect for Contract SS
C505 Liantang/ Heung Yuen Wai Boundary Control Point
(BCP) ¡V BCP Buildings and Associated Facilities. It responsible for overseeing the
construction works of Contract SS C505 and for ensuring that the works are
undertaken by the Contractor in accordance with the specification and contract
requirements. The duties and responsibilities of the Architect with respect to
EM&A are:
Monitor the Contractors¡¦ compliance with
contract specifications, including the implementation and operation of the
environmental mitigation measures and their effectiveness
Monitor Contractors¡¦ and ET¡¦s compliance with
the requirements in the Environmental Permit (EP) and EM&A Manual
Facilitate ET¡¦s implementation of the EM&A
programme
Participate in joint site inspection by the ET
and IEC
Oversee the implementation of the agreed Event
/ Action Plan in the event of any exceedance
Adhere to the procedures for carrying out
complaint investigation
Liaison with DSD, Engineer/Engineer¡¦s
Representative, ET, IEC and the Contractor of the ¡§Construction of the DSD¡¦s
Regulation of Shenzhen River Stage 4 (RSR 4)¡¨ Project discussing regarding the
cumulative impact issues.
Engineer
or Engineers Representative (ER)
2.2.6
The ER is responsible for overseeing the
construction works and for ensuring that the works are undertaken by the
Contractor in accordance with the specification and contract requirements. The
duties and responsibilities of the ER with respect to EM&A are:
¡P
Monitor the Contractors¡¦ compliance with
contract specifications, including the implementation and operation of the
environmental mitigation measures and their effectiveness
¡P
Monitor Contractors¡¦s,
ET¡¦s and IEC¡¦s compliance with the requirements in the Environmental Permit
(EP) and EM&A Manual
¡P
Facilitate ET¡¦s implementation of the
EM&A programme
¡P
Participate in joint site inspection by the
ET and IEC
¡P
Oversee the implementation of the agreed
Event / Action Plan in the event of any exceedance
¡P
Adhere to the procedures for carrying out
complaint investigation
¡P
Liaison with DSD, Engineer/Engineer¡¦s
Representative, ET, IEC and the Contractor of the ¡§Construction of the DSD¡¦s Regulation
of Shenzhen River Stage 4 (RSR 4)¡¨ Project discussing regarding the cumulative
impact issues.
The
Contractor(s)
2.2.7
There will be one contractor for each
individual works contract. Once the contractors are appointed, EPD, ET and IEC
will be notified the details of the contractor.
2.2.8
The Contractor for Contracts under CEDD should
report to the ER. For ArchSD Contract, the Contractor
should report to the Architect or Architect¡¦s Representative (AR). The duties
and responsibilities of the Contractor are:
¡P
Comply with the relevant contract conditions
and specifications on environmental protection
¡P
Employ an Environmental Team (ET) to
undertake monitoring, laboratory analysis and reporting of EM &A Facilitate
ET¡¦s monitoring and site inspection activities
¡P
Participate in the site inspections by the ET
and IEC, and undertake any corrective actions
¡P
Provide information / advice to the ET
regarding works programme and activities which may
contribute to the generation of adverse environmental impacts
¡P
Submit proposals on mitigation measures in
case of exceedances of Action and Limit levels in accordance with the Event /
Action Plans
¡P
Implement measures to reduce impact where
Action and Limit levels are exceeded
¡P
Adhere to the procedures for carrying out
complaint investigation
Environmental Team (ET)
2.2.9
Once the ET is appointed, the EPD, CEDD, ER,
Architect and IEC will be notified the details of the ET.
2.2.10
The ET shall not be in any way an associated
body of the Contractor(s), and shall be employed by the Project
Proponent/Contractor to conduct the EM&A programme. The ET should be managed by the ET
Leader. The ET Leader shall be a person who has at least 7 years¡¦ experience in
EM&A and has relevant professional qualifications. Suitably qualified staff
should be included in the ET, and resources for the implementation of the
EM&A programme should be allocated in time under
the Contract(s), to enable fulfillment of the Project¡¦s EM&A requirements
as specified in the EM&A Manual during construction of the Project. The ET shall report to the Project
Proponent and the duties shall include:
¡P
Monitor and audit various environmental
parameters as required in this EM&A Manual
¡P
Analyse the
environmental monitoring and audit data, review the success of EM&A programme and the adequacy of mitigation measures
implemented, confirm the validity of the EIA predictions and identify any
adverse environmental impacts arising
¡P
Carry out regular site inspection to
investigate and audit the Contractors¡¦ site practice, equipment/plant and work
methodologies with respect to pollution control and environmental mitigation,
and effect proactive action to pre-empt problems
¡P
Monitor compliance with conditions in the EP,
environmental protection, pollution prevention and control regulations and
contract specifications
¡P
Audit environmental conditions on site
¡P
Report on the environmental monitoring and
audit results to EPD, the ER, the Architect, the lEC
and Contractor or their delegated representatives
¡P
Recommend suitable mitigation measures to the
Contractor in the case of exceedance of Action and Limit levels in accordance with
the Event and Action Plans
¡P
Liaise with the IEC on all environmental
performance matters and timely submit all relevant EM&A proforma
for approval by IEC
¡P
Advise the Contractor(s) on environmental
improvement, awareness, enhancement measures etc., on site
¡P
Adhere to the procedures for carrying out
complaint investigation
¡P
Liaison with the client departments,
Engineer/Engineer¡¦s Representative, ET, lEC and the
Contractor(s) of the concurrent projects as listed under Section 2.3 below
regarding the cumulative impact issues.
Independent Environmental Checker (IEC)
2.2.11
One IEC will be employed for this Project.
Once the IEC is appointed, EPD, ER, the Architect and ET will be notified the
details of the IEC.
2.2.12
The Independent Environmental Checker (IEC)
should not be in any way an associated body of the Contractor or the ET for the
Project. The IEC should be employed by the Permit Holder (i.e., CEDD) prior to
the commencement of the construction of the Project. The IEC should have at
least 10 years¡¦ experience in EM&A and have relevant professional
qualifications. The appointment of IEC should be subject to the approval of
EPD. The IEC should:
¡P
Provide proactive advice to the ER and the
Project Proponent on EM&A matters related to the project, independent from
the management of construction works, but empowered to audit the environmental
performance of construction
¡P
Review and audit all aspects of the EM&A programme implemented by the ET
¡P
Review and verify the monitoring data and all
submissions in connection with the EP and EM&A Manual submitted by the ET
¡P
Arrange and conduct regular, at least monthly
site inspections of the works during construction phase, and ad hoc inspections
if significant environmental problems are identified
¡P
Check compliance with the agreed Event /
Action Plan in the event of any exceedance
¡P
Check compliance with the procedures for
carrying out complaint investigation
¡P
Check the effectiveness of corrective
measures
¡P
Feedback audit results to ET by signing off
relevant EM&A proforma
¡P
Check that the mitigation measures are
effectively implemented
¡P
Verify the log-book(s) mentioned in Condition
2.2 of the EP, notify the Director by fax, within one working day of receipt of
notification from the ET Leader of each and every occurrence, change of
circumstances or non-compliance with the EIA Report and/or the EP, which might
affect the monitoring or control of adverse environmental impacts from the
Project
¡P
Report the works conducted, the findings, recommendation
and improvement of the site inspections, after reviewing ET¡¦s and Contractor¡¦s
works, and advices to the ER and Project Proponent on a monthly basis
¡P
Liaison with the client departments,
Engineer/Engineer¡¦s Representative, the Architect, ET, lEC
and the Contractor of the concurrent projects as listed under Section 2.3 below
regarding the cumulative impact issues.
2.3.1
The concurrent construction works that may be
carried out include, but not limited to, the following:
(a)
Regulation of Shenzhen River Stage IV;
(b)
Widening of Fanling
Highway ¡V Tai Hang to Wo Hop Shek
Interchange ¡V Contract No. HY/2012/06;
(c)
Construction of BCP
facilities in Shenzhen.
2.4.1
In the Reporting Period, the major
construction activity conducted under the Project is located in Contracts 2, 3,
6, 7 and SS C505 and they are summarized in below. Moreover, 3-month rolling construction
program for all the current contracts is enclosed in Appendix C.
Contract 2 (CV/2012/08)
2.4.2
The
contract commenced in May 2014. In this Reporting Period, construction
activities conducted are listed below:
Rectification of
identified defects
Rectification of
soft landscape defects
Maintenance
works during the defect liability period
Contract 3 (CV/2012/09)
2.4.3
The Contract commenced in November 2013. In this Reporting Period, construction
activities conducted are listed below:
Road pavement
works
Contract 4 (NE/2014/02)
2.4.4
The
Contract was awarded in mid-April 2016 and the construction work was commenced on 2 May 2017. In this Reporting Period, construction
activities conducted are listed below:
OPT & DLP of control room, TCSS & PA
Cabling, TCSS & FVMS installation
Contract 5 (CV/2013/03)
2.4.5
The
construction works under Contract 5 was substantially completed on 31 August
2016.
Contract 6 (CV/2013/08)
2.4.6
Contract 6 has awarded in June 2015 and
construction work was commenced on 23 October 2015. In this Reporting Period,
construction activities conducted are listed below:
Water
Pipe Connection Work
Road
Construction
Landscaping
Construction
of Wetland
Contract 7 (NE/2014/03)
2.4.7
Contract 7 has awarded in December 2015 and
construction work was commenced on 15 February 2016. In this Reporting Period, construction
activities conducted are listed below:
General Cleaning
Defect rectification
Contract SS C505
2.4.8
Contract SS C505 has awarded in July 2015 and
construction work was commenced on 1 September 2015. In this Reporting Period, construction
activities conducted are listed below:
Defect Rectification Works involving primarily:
Building cladding and curtain walls;
Building internal fit-out, finishing and signages;
E&M defect rectifications, testing and
commissioning;
Soft Landscaping and related green area maintenance
works
2.5.1
In according to the EP, the required
documents have submitted to EPD which listed in below:
Project Layout Plans of Contracts 2, 3, 4, 5,
6, 7 and SS C505
Landscape Plan
Topsoil Management Plan
Environmental Monitoring and Audit Programme
Baseline Monitoring Report
(TCS00690/13/600/R0030v3) for the Project
Waste Management Plan of the Contracts 2, 3, 4,
5, 6, 7 and SS C505
Contamination Assessment Plan (CAP) and
Contamination Assessment Report (CAR) for Po Kat Tsai, Loi
Tung and the workshops in Fanling
Vegetation Survey Report
Woodland Compensation Plan
Habitat Creation and Management Plan
Wetland Compensation Plan
2.5.2
Summary of
the relevant permits, licenses, and/or notifications on environmental
protection for the Project of each contracts are presented in Table 2-1.
Table 2-1 Status of Environmental
Licenses and Permits of the Contracts
Item |
Description |
License/Permit Status |
||||
Ref. no. |
Effective Date |
Expiry Date |
||||
Contract 2 |
||||||
1 |
Air pollution Control (Construction Dust) Regulation |
Ref No.: 368864 |
31 Dec 2013 |
Till Contract ends |
||
2 |
Chemical Waste Producer Registration |
North Portal Waste
Producers Number: No.5213-652-D2523-01 |
25 Mar 2014 |
Till Contract ends |
||
Mid-Vent Portal Waste
Producers Number: No.5213-634-D2524-01 |
25 Mar 2014 |
Till Contract ends |
||||
South Portal Waste
Producers Number: No.5213-634-D2526-01 |
9 Apr 2014 |
Till Contract ends |
||||
3 |
Waste Disposal Regulation - Billing Account for
Disposal of Construction Waste |
Account No. 7019105 |
8 Jan 2014 |
Till Contract ends |
||
Contract 3 |
||||||
1 |
Air pollution Control (Construction Dust) Regulation |
Ref. No: 362101 |
17 Jul 2013 |
Till Contract ends |
||
2 |
Chemical Waste Producer Registration |
Waste Producers Number:
No.:5113-634-C3817-01 |
7 Oct 2013 |
Till Contract ends |
||
3 |
Water Pollution Control Ordinance - Discharge License |
No.:WT00032188 ¡V 2018 |
20 Sep 2018 |
31 Aug 2023 |
||
4 |
Waste Disposal Regulation - Billing Account for
Disposal of Construction Waste |
Account No. 7017914 |
2 Aug 2013 |
Till Contract ends |
||
Contract 6 |
||||||
1 |
Air pollution Control (Construction Dust) Regulation |
Ref. No: 390614 |
29 Jun 2015 |
Till the end of Contract |
||
2 |
Chemical Waste Producer Registration |
Waste Producers Number No.: 5213-652-C3969-01 |
31 Aug 2015 |
Till the end of Contract |
||
3 |
Waste Disposal Regulation - Billing Account for
Disposal of Construction Waste |
Account No. 7022707 |
9 Jul 2015 |
Till the end of Contract |
||
4 |
Water Pollution Control Ordinance - Discharge License |
No.:WT00024574-2016 |
31 May
2016 |
31 May
2021 |
||
No.:WT00024576-2016 |
31 May
2016 |
31 May
2021 |
||||
No.:WT00024742-2016 |
14 June 2016 |
30 June 2021 |
||||
No.:WT00024746-2016 |
14 June 2016 |
30 June 2021 |
||||
5 |
Construction Noise
Permit |
GW-RN0058-20 |
15 Feb 2020 |
31 May 2020 |
||
Contract SS C505 |
||||||
1 |
Air pollution Control (Construction Dust) Regulation |
Ref. No: 390974 |
13 Jul 2015 |
Till the end of Contract |
||
2 |
Chemical Waste Producer Registration |
Waste Producer No.: 5213-642-L1048-07 |
16 Sep 2015 |
Till the end of Contract |
||
3 |
Water Pollution Control Ordinance - Discharge License |
No.: WT00024865-2016 |
8 Jul 2016 |
30 Nov 2020 |
||
4 |
Waste Disposal Regulation - Billing Account for
Disposal of Construction Waste |
Account No. 7022831 |
23 Jul 2015 |
Till the end of Contract |
||
5 |
Construction Noise
Permit |
GW-RN0040-20 |
9 Feb 2020 |
8 Jun 2020 |
||
Contract
7 |
||||||
1 |
Air pollution Control (Construction Dust) Regulation |
Ref. No: 397015 |
21 Dec 2015 |
Till the end of Contract |
||
2 |
Chemical Waste Producer Registration |
Waste Producer No.: 5214-641-K3202-01 |
24 Mar 2016 |
Till the end of Contract |
||
3 |
Water Pollution Control Ordinance - Discharge License |
No.: WT00024422-2016 |
10 May
2016 |
31 May
2021 |
||
4 |
Waste Disposal Regulation - Billing Account for
Disposal of Construction Waste |
Account No. 7024129 |
21 Jan 2016 |
Till the end of Contract |
||
Contract 4 |
||||||
1 |
Air pollution Control (Construction Dust) Regulation |
Ref. No.
405353 |
22 July 2016 |
Till the end of Contract |
||
2 |
Waste Disposal Regulation - Billing Account for
Disposal of Construction Waste |
Account No. 7024973 |
13 May 2016 |
Till the end of Contract |
||
3.1.1
The Environmental Monitoring and Audit
requirements are set out in the Approved EM&A manual. Environmental issues
such as air quality, construction noise and water quality were identified as
the key issues during the construction phase of the Project.
3.1.2
A summary of construction phase EM&A
requirements are presented in the
sub-sections below.
3.2.1
The EM&A program of construction phase
monitoring shall cover the following environmental issues:
•
Air quality;
•
Construction noise; and
•
Water quality
3.2.2
A summary of the monitoring parameters is
presented in Table 3-1.
Table 3-1 Summary
of EM&A Requirements
Environmental Issue |
Parameters |
Air Quality |
1-hour
TSP by Real-Time Portable Dust Meter; and 24-hour
TSP by High Volume Air Sampler. |
Noise |
Leq(30min) in
normal working days (Monday to Saturday) 07:00-19:00 except public holiday;
and 3 sets
of consecutive Leq(5min) on
restricted hours i.e. 19:00 to 07:00 next day, and whole day of public
holiday or Sunday Supplementary
information for data auditing, statistical results such as L10 and
L90 shall also be obtained for reference. |
Water Quality |
In-situ Measurements Dissolved
Oxygen Concentration (mg/L); Dissolved
Oxygen Saturation (% ); Turbidity
(NTU); pH unit; Water
depth (m); and Temperature
(¢J). |
Laboratory Analysis
Suspended
Solids (mg/L) |
3.3.1
The designated monitoring locations as
recommended in the EM&A Manual
are shown in Appendix D. As the access to some of the designated
monitoring locations was questionable due to safety reason or denied by the
landlords, alternative locations therefore have had proposed. The latest alternative monitoring locations has been updated in the revised EM&A Programme
(Rev.7) which approved by EPD on 7 April 2017. Besides, in view of Location AM1b was demolished
and returned to the landlord on 27 April
2018, alterative location AM1c was proposed by ET and approved by EPD on 26 November 2018. Table 3-2, Table 3-3 and Table 3-4
listed the air quality, construction noise and water quality monitoring
locations for the Project and a map showing these monitoring stations is
presented in Appendix E.
Table 3-2 Impact
Monitoring Stations - Air Quality
Station ID |
Description |
Works Area |
Related to the Work Contract |
AM1c (*) |
Open area of Tsung Yuen Ha Village No. 63 |
BCP |
SS C505 Contract 7 |
AM2 |
Village House
near Lin Ma Hang Road |
LMH to Frontier
Closed Area |
Contract 6 |
AM3 |
Ta Kwu Ling Fire Service Station of Ta Kwu
Ling Village. |
LMH to Frontier
Closed Area |
Contract 6 |
AM4b^ |
House no. 10B1 Nga Yiu Ha Village |
LMH to Frontier
Closed Area |
Contract 6 |
AM5a^ |
Ping Yeung
Village House |
Ping Yeung to
Wo Keng Shan |
Contract 6 |
AM6 |
Wo Keng Shan Village House |
Ping Yeung to
Wo Keng Shan |
Contract 6 |
AM7b@ |
Loi Tung Village House |
Sha Tau Kok Road |
Contract 2 Contract 6 |
AM8 |
Po Kat Tsai
Village No. 4 |
Po Kat Tsai |
Contract 2 |
AM9b# |
Nam Wa Po Village House No. 80 |
Fanling |
Contract 3 |
# Proposal
for the change of air quality monitoring location from AM9a to AM9b was
submitted to EPD on 4 Nov 2013 after verified by the IEC and it was approved by
EPD (EPD¡¦s ref.: (15) in EP 2/N7/A/52 Pt.10 dated 8 Nov 2013).
@ Proposal for the change of air quality monitoring location from AM7a to
AM7b was submitted to EPD on 4 June 2014 after verified by the IEC. It was
approved by EPD (EPD¡¦s ref.: (7) in EP 2/N7/A/52 Pt.12 dated 9 Jun 2014).
^ Proposal for change
of air quality monitoring locations was enclosed in the updated EM&A Programme which approval by EPD on 29 Mar 2016. Besides,
Location AM1b was temporary suspended (24-hour TSP monitoring) since 27 April
2018 as the rented land was demolished and returned to the landlord.
* Revised proposal
for alterative location AM1c was submitted
to EPD on 31 October 2018 after
verified by the IEC and it was approved by EPD
(EPD¡¦s ref.: ( ) in Ax (1) to EP 2/N7/A/52 Pt.26 dated 26 November 2018).
Table 3-3 Impact
Monitoring Stations - Construction Noise
Station ID |
Description |
Works Area |
Related to the Work Contract |
NM1 |
Tsung Yuen Ha Village House No. 63 |
BCP |
SS C505 Contract 7 |
NM2a# |
Village House near Lin Ma Hang
Road |
Lin Ma Hang to Frontier Closed
Area |
Contract 6 |
NM3 |
Ping Yeung Village House (facade
facing northeast) |
Ping Yeung to Wo Keng Shan |
Contract 6 |
NM4 |
Wo Keng
Shan Village House |
Ping Yeung to Wo Keng Shan |
Contract 6 |
NM5 |
Village House, Loi
Tung |
Sha Tau Kok
Road |
Contract 2, Contract 6 |
NM6 |
Tai Tong Wu Village House 2 |
Sha Tau Kok
Road |
Contract 2, Contract 6 |
NM7 |
Po Kat Tsai Village |
Po Kat Tsai |
Contract 2 |
NM8 |
Village House, Tong Hang |
Fanling |
Contract 2 Contract 3 |
NM9 |
Village House, Kiu
Tau Village |
Fanling |
Contract 3 |
NM10 |
Nam Wa
Po Village House No. 80 |
Fanling |
Contract 3 |
# Proposal for the change of construction noise monitoring location from
NM2 to NM2a was verified by the IEC on 6 May 2016 and was effective on 9 May
2016.
Table 3-4 Impact
Monitoring Stations - Water Quality
Station ID |
Description |
Coordinates of Designated / Alternative Location |
Nature of the location |
Related to the Work Contract |
|
Easting |
Northing |
||||
WM1 |
Downstream of Kong Yiu Channel |
833 679 |
845 421 |
Alternative location located at upstream 51m of the designated location |
SS C505 Contract 6 |
WM1- Control |
Upstream of Kong Yiu Channel |
834 185 |
845 917 |
NA |
SS C505 Contract 6 |
WM2A |
Downstream of River Ganges |
834 204 |
844 471 |
Alternative location located at upstream 81m of the designated location |
Contract 6 |
WM2A(a)* |
Downstream of River Ganges |
834 191 |
844 474 |
Alternative location located at upstream 70m of the designated location |
Contract 6 |
WM2A- Controlx# |
Upstream of River Ganges |
835 377 |
844 188 |
Alternative location located at upstream 160m of the designated location |
Contract 6 |
WM2B |
Downstream of River Ganges |
835 433 |
843 397 |
NA |
Contract 6 |
WM2B- Control |
Upstream of River Ganges |
835 835 |
843 351 |
Alternative location located at downstream 31m of the designated
location |
Contract 6 |
WM3x# |
Downstream of River Indus |
836 206 |
842 270 |
Alternative location located at downstream 180m of the designated
location |
Contract 2 Contract 6 |
WM3- Control |
Upstream of River Indus |
836 763 |
842 400 |
Alternative location located at downstream 26m of the designated
location |
Contract 2 Contract 6 |
WM4 |
Downstream of Ma Wat Channel |
833 850 |
838 338 |
Alternative location located at upstream 11m of the designated location |
Contract 2 Contract 3 |
WM4¡V Control A |
Kau Lung Hang
Stream |
834 028 |
837 695 |
Alternative location located at downstream 28m of the designated
location |
Contract 2 Contract 3 |
WM4¡V Control B |
Upstream of Ma Wat Channel |
833760 |
837395 |
Alternative location located at upstream 15m of the designated location |
Contract 2 Contract 3 |
Note: EPD has
approved the revised EM&A Programme (Rev.7) which
proposed that (1) if the measured water depth of the monitoring station is
lower than 150 mm, alternative location based on the criteria were selected to
perform water monitoring; and (2) If no suitable alternative location could be
found within 15m far from the original location, the sampling at that location
will be cancelled since sampling at too far from the designated location could
not make a representative sample in accordance with the updated EM&A Programme (Rev. 07) (Section 4.1.4) (EPD ref.: ( ) in
EP2/N7/A/52 Ax(1) Pt.20 dated 7 April 2017)
(*)
Proposal for the
change of water monitoring location from WM2A to WM2A(a)
was verified by the IEC and it was approved by EPD. (EPD¡¦s ref. (10) in EP
2/N7/A/52 Pt.19)
(#) Proposal for the change of water quality monitoring location (WM3x and WM2A-Cx was included in the EM&A Programme Rev .05 which
approved by EPD on 29 March 2016 (EPD ref.: (3) in EP2/N7/A/52 Ax(1) Pt.19)
The requirements of impact monitoring are stipulated in Sections 2.1.6, 3.1.5 and 4.1.6 of the approved EM&A Manual and presented as
follows.
Air Quality Monitoring
3.4.1
Frequency of impact air quality monitoring is
as follows:
1-hour TSP |
3 times every six days
during course of works |
24-hour TSP |
Once every 6 days
during course of works. |
Noise Monitoring
3.4.2
One set of Leq(30min)
as 6 consecutive Leq(5min)
between 0700-1900 hours on normal weekdays and once every week during course of
works. If construction work
necessary to carry out at other time periods, i.e. restricted time period
(19:00 to 07:00 the next morning and whole day on public holidays) (hereinafter
referred as ¡§the restricted hours¡¨), additional weekly impact monitoring for Leq(5min) measurement shall be
employed during respective restricted hours periods.. Supplementary information for data
auditing, statistical results such as L10 and L90 shall
also be obtained for reference.
Water Quality Monitoring
3.4.3
The water quality monitoring frequency shall
be 3 days per week during course of works.
The interval between two sets of monitoring shall not be less than 36
hours.
Air Quality Monitoring
3.5.1
The 24-hour and 1-hour TSP levels shall be
measured by following the standard high volume sampling method as set out in
the Title 40 of the Code of Federal
Regulations, Chapter 1 (Part 50), Appendix B. If the ET proposes to use a direct
reading dust meter to measure 1-hour TSP levels, it shall submit sufficient
information to the IEC to approve.
3.5.2
The filter paper of
24-hour TSP measurement shall be determined by HOKLAS accredited laboratory.
3.5.3
All equipment to be used for air quality
monitoring is listed in Table 3-5.
Table 3-5 Air
Quality Monitoring Equipment
Equipment |
Model |
24-Hr TSP |
|
High
Volume Air Sampler |
TISCH High Volume
Air Sampler, HVS Model TE-5170* |
Calibration
Kit |
TISCH Model
TE-5025A* |
1-Hour TSP |
|
Portable Dust Meter |
Sibata LD-3B
Laser Dust monitor Particle Mass Profiler & Counter* |
* Instrument was used in the Reporting
Period and the calibration certificate could be referred in Appendix F.
Wind Data Monitoring Equipment
3.5.4
According to the approved EM&A Manual,
wind data monitoring equipment shall also be provided and set up for logging
wind speed and wind direction near the dust monitoring locations. The equipment installation location
shall be proposed by the ET and agreed with the IEC. For installation and operation of wind
data monitoring equipment, the following points shall be observed:
1)
The wind sensors should be installed 10 m
above ground so that they are clear of obstructions or turbulence caused by
buildings.
2)
The wind data should be captured by a data
logger. The data shall be downloaded for analysis at least once a month.
3)
The wind data monitoring equipment should be
re-calibrated at least once every six months.
4)
Wind direction should be divided into 16
sectors of 22.5 degrees each.
3.5.5
ET has liaised with the landlords of the
successful granted HVS installation premises. However, the owners rejected to provide premises
for wind data monitoring equipment installation.
3.5.6
Under this situation, the ET proposed
alternative methods to obtain representative wind data. Meteorological information as extracted
from ¡§the Hong Kong Observatory Ta Kwu Ling Station¡¨
is alternative method to obtain representative wind data. For Ta Kwu
Ling Station, it is located nearby the Project site. Moreover, this station is located at 15m
above mean sea level while its anemometer is located at 13m above the existing
ground which in compliance with the general setting up requirement. Furthermore, this station also can be to
provide the humidity, rainfall, and air pressure and temperature etc.
meteorological information. In Hong
Kong of a lot development projects, weather information extracted from Hong
Kong Observatory is common alternative method if weather station installation
not allowed.
Noise Monitoring
3.5.7
Sound
level meter in compliance with the International Electrotechnical
Commission Publications 651: 1979 (Type 1) and 804: 1985 (Type 1)
specifications shall be used for carrying out the noise monitoring. The sound level meter shall be checked
using an acoustic calibrator. The
wind speed shall be checked with a portable wind speed meter capable of
measuring the wind speed in m/s.
3.5.8
Noise monitoring equipment to be used for
monitoring is listed in Table 3-6.
Table 3-6 Construction
Noise Monitoring Equipment
Equipment |
Model |
Integrating Sound Level Meter |
B&K Type 2238* and Rion NL-52* |
Calibrator |
Rion NC-74* |
Portable Wind Speed Indicator |
Testo Anemometer |
* Instrument was used in the Reporting
Period and the calibration certificate could be referred in Appendix F.
3.5.9
Sound level meters listed above comply with
the International Electrotechnical
Commission Publications 651: 1979 (Type 1) and 804: 1985 (Type 1) specifications, as recommended in TM issued
under the NCO. The acoustic
calibrator and sound level meter to be used in the impact monitoring will be
calibrated yearly.
Water Quality Monitoring
3.5.10
DO and water temperature should be measured
in-situ by a DO/temperature meter. The instrument should be portable and
weatherproof using a DC power source. It should have a membrane electrode with
automatic temperature compensation complete with a cable. The equipment should
be capable of measuring:
•
a DO level
in the range of 0-20 mg/l and 0-200% saturation; and
•
a
temperature of between 0 and 45 degree Celsius.
3.5.11
A portable pH meter capable of measuring a
range between 0.0 and 14.0 should be provided to measure pH under the specified
conditions accordingly to the APHA Standard Methods.
3.5.12
The instrument should be portable and
weatherproof using a DC power source. It should have a photoelectric sensor
capable of measuring turbidity between 0-1000 NTU.
3.5.13
A portable, battery-operated echo sounder or
tape measure will be used for the determination of water depth at each
designated monitoring station as appropriate.
3.5.14
A water sampler e.g. Kahlsico
Water Sampler, which is a transparent PVC cylinder with capacity not less than
2 litres, will be used for water sampling if water
depth over than 0.5m. For
sampling from very shallow water depths e.g. <0.5 m, water sample collection
will be directly from water surface below 100mm use sampling plastic bottle to
avoid inclusion of bottom sediment or humus. Moreover, Teflon/stainless steel bailer
or self-made sampling buckets maybe used for water sampling. The equipment used for sampling will be
depended the sampling location and depth situations.
3.5.15
Water samples for laboratory measurement of
SS will be collected in high density polythene bottles, packed in ice (cooled
to 4 ºC without being frozen), and delivered to the laboratory in the same day
as the samples were collected.
3.5.16
Analysis of suspended solids should be
carried out in a HOKLAS or other accredited laboratory. Water samples of about
1L should be collected at the monitoring stations for carrying out the
laboratory suspended solids determination.
The SS determination work should start within 24 hours after collection
of the water samples. The SS analyses should follow the APHA Standard Methods 2540D with Limit of Reporting of 2 mg/L.
3.5.17
Water quality monitoring equipment used in
the impact monitoring is listed in Table 3-7. Suspended solids (SS)
analysis is carried out by a local HOKLAS-accredited laboratory, namely ALS Technichem
(HK) Pty Ltd.
Table 3-7 Water
Quality Monitoring Equipment
Equipment |
Model |
Water
Depth Detector |
Eagle
Sonar or tape measures |
Water Sampler |
A 2-litre transparent PVC cylinder with latex cups at
both ends or teflon/stainless steel bailer or
self-made sampling bucket |
Thermometer & DO meter |
YSI Professional Plus / YSI PRO20 Handheld Dissolved
Oxygen Instrument/ YSI 550A Multifunctional Meter*/ YSI Professional DSS |
pH meter |
YSI Professional Plus / AZ8685 pH pen-style meter*/ YSI 6820/ 650MDS/ YSI Professional DSS |
Turbidimeter |
Hach 2100Q*/ YSI 6820/
650MDS/ YSI Professional DSS |
Sample Container |
High density polythene bottles (provided by laboratory) |
Storage
Container |
¡¥Willow¡¦
33-liter plastic cool box with Ice pad |
* Instrument was used in the Reporting
Period and the calibration certificate could be referred in Appendix F.
1-hour TSP
Monitoring
3.6.1
The 1-hour TSP monitor was a brand named ¡§Sibata LD-3B Laser Dust monitor Particle Mass Profiler
& Counter¡¨ which is a portable, battery-operated laser photometer. The 1-hour TSP meter provides a real
time 1-hour TSP measurement based on 90o light scattering. The 1-hour TSP monitor consists of the
following:
(a.)
A pump to draw sample aerosol through the
optic chamber where TSP is measured;
(b.)
A sheath air system to isolate the aerosol in
the chamber to keep the optics clean for maximum reliability; and
(c.)
A built-in data logger compatible with
Windows based program to facilitate data collection, analysis and reporting.
3.6.2
The 1-hour TSP meter is used within the valid
period as follow manufacturer¡¦s Operation and Service Manual.
3.6.3
The equipment used for 24-hour TSP
measurement is Tisch Environmental, Inc. Model TE-5170
TSP high volume air sampling system, which complied with EPA Code of Federal Regulation, Appendix B
to Part 50. The High Volume Air Sampler (HVS) consists of the following:
(a.)
An anodized aluminum shelter;
(b.)
A 8¡¨x10¡¨ stainless steel filter holder;
(c.)
A blower motor assembly;
(d.)
A continuous flow/pressure recorder;
(e.)
A motor speed-voltage control/elapsed time
indicator;
(f.)
A 7-day mechanical timer, and
(g.)
A power supply of 220v/50 Hz
3.6.4
The HVS is operated and calibrated on a
regular basis in accordance with the manufacturer¡¦s instruction using Tisch Calibration Kit Model TE-5025A. Calibration would carry out in two month
interval.
3.6.5
24-hour TSP is collected by the ET on filters
of HVS and quantified by a local HOKLAS accredited laboratory, ALS Technichem (HK) Pty Ltd (ALS), upon receipt of the
samples. The ET keep all the
sampled 24-hour TSP filters in normal air conditioned room conditions, i.e. 70%
RH (Relative Humidity) and 25oC, for six months prior to disposal.
3.6.6
Noise measurements were taken in terms of the
A-weighted equivalent sound pressure level (Leq)
measured in decibels dB(A). Supplementary statistical
results (L10 and L90) were also obtained for reference.
3.6.7
During the monitoring, all noise measurements
would be performed with the meter set to FAST response and on the A-weighted
equivalent continuous sound pressure level (Leq). Leq(30min)
in six consecutive Leq(5min) measurements
will use as the monitoring parameter for the time period between 0700-1900
hours on weekdays; Leq(5min) measurements
would be used as monitoring parameter for other time periods (e.g. during
restricted hours), if necessary.
3.6.8
Prior of noise measurement, the accuracy of
the sound level meter is checked using an acoustic calibrator generating a
known sound pressure level at a known frequency. The checking is performed before and
after the noise measurement.
Water
Quality
3.6.9
Water quality monitoring is conducted at the
designated or alternative locations. The sampling procedures with the in-situ
monitoring are presented as below:
Sampling Procedure
3.6.10
A Digital Global
Positioning System (GPS) is used to identify the designated monitoring stations
prior to water sampling. A
portable, battery-operated echo sounder or tape measurement is used for the
determination of water depth at each station. At each station, water sample would be
collected from 0.1m below water surface or the water surface to prevent the
river bed sediment for stirring.
3.6.11
If the water level of a
monitoring station is too shallow when sampling, sediment would be disturbed
which affecting the accuracy of water quality monitoring. In order to avoid disturbing sediment,
depth limits should be set up for the water sampling for the ease of
reference. When the measured water
depth of the monitoring station (both control and impact stations) is lower
than 150mm, water monitoring would not be to perform at that monitoring
location. Instead, the monitoring
location will be moved to a temporary alternative location monitoring location
based on the criteria below:-
(a) the alternative location should be either
upstream or downstream of the original location and at the same the
river/drain channel
(b) the alternative location should be within 15m far from the original location
(c) if no suitable alternative location could be
found within 15m far from the original
location, the sampling at that location will be cancelled since sampling at too
far from the designated location could not make a representative sample.
3.6.12
The sample container will be rinsed with a
portion of the water sample. The
water sample then will be transferred to the high-density polythene bottles as provided by the laboratory,
labeled with a unique sample number and sealed with a screw cap.
3.6.13
Before sampling, general information such as
the date and time of sampling, weather condition as well as the personnel
responsible for the monitoring would be recorded on the field data sheet.
3.6.14
A ¡¥Willow¡¦ 33-liter plastic cool box packed
with ice will be used to preserve the water samples prior to arrival at the
laboratory for chemical determination.
The water temperature of the cool box is maintained at a temperature as
close to 40C as possible without being frozen. Samples collected are delivered to the
laboratory upon collection.
In-situ Measurement
3.6.15
YSI 550A Multifunctional Meter is used for water
in-situ measures, which automates the measurements and data logging of
temperature, dissolved oxygen and dissolved oxygen saturation.
3.6.16
A portable AZ Model 8685 is used for in-situ
pH measurement. The pH meter is
capable of measuring pH in the range of 0 ¡V 14 and readable to 0.1.
3.6.17
A portable Hach
2100Q Turbidimeter is used for in-situ turbidity
measurement. The turbidity meter is capable of measuring turbidity in the range
of 0 ¡V 1000 NTU.
3.6.18
All in-situ measurement equipment are calibrated by HOKLAS accredited laboratory of three
month interval.
Laboratory Analysis
3.6.19
All water samples analyzed Suspended Solids
(SS) will be carried out by a local HOKLAS-accredited testing laboratory (ALS Technichem (HK) Pty Ltd HOKLAS registration no. 66). SS determination using APHA
Standard Methods 2540D as specified in the EM&A Manual will start within
48 hours of water sample receipt.
3.7.1
Calibration of the HVS is performed upon
installation and thereafter at bimonthly intervals in accordance with the
manufacturer¡¦s instruction using the certified standard calibrator (TISCH Model
TE-5025A).
Moreover, the Calibration Kit would be calibrated annually. The calibration data are properly
documented and the records are maintained by ET for future reference.
3.7.2
The 1-hour TSP
meter was calibrated by the supplier prior to purchase. Zero response of the equipment would be
checked before and after each monitoring event. Annually calibration with the High
Volume Sampler (HVS) in same condition would be undertaken by the Laboratory.
3.7.3
The sound level
meter and calibrator are calibrated and certified by a laboratory accredited
under HOKLAS or any other international accreditation scheme at yearly basis.
3.7.4
All water quality monitoring equipment would
be calibrated by HOKLAS accredited laboratory of three month intervals.
3.7.5
The calibration
certificates of all monitoring equipment used for the impact monitoring program
in the Reporting Period and the HOKLAS accredited certificate of laboratory are attached in Appendix F.
3.8.1
The baseline results form the basis for
determining the environmental acceptance criteria for the impact
monitoring. According to the
approved Environmental Monitoring and Audit Manual, the air quality,
construction noise and water quality criteria were set up, namely Action and
Limit levels are listed in Tables 3-8, 3-9 and 3-10.
Table 3-8 Action and
Limit Levels for Air Quality Monitoring
Monitoring
Station |
Action Level (mg /m3) |
Limit Level (mg/m3) |
||
1-hour TSP |
24-hour TSP |
1-hour TSP |
24-hour TSP |
|
AM1c |
265 |
143 |
500 |
260 |
AM2 |
268 |
149 |
||
AM3 |
269 |
145 |
||
AM4b |
267 |
148 |
||
AM5a |
268 |
143 |
||
AM6 |
269 |
148 |
||
AM7b |
275 |
156 |
||
AM8 |
269 |
144 |
||
AM9b |
271 |
151 |
Table 3-9 Action
and Limit Levels for Construction Noise
Monitoring Location |
Action Level |
Limit Level in
dB(A) |
Time Period:
0700-1900 hours on normal weekdays |
||
NM1, NM2a, NM3,
NM4, NM5, NM6, NM7, NM8, NM9, NM10 |
When one
or more documented complaints are received |
75 dB(A)Note 1
& Note 2 |
Note 1: Acceptable Noise Levels
for school should be reduced to 70 dB(A)
and65 dB(A) during examination period.
Note 2: If works are to be
carried out during restricted hours, the conditions stipulated in the construction noise permit issued by the NCA have to be followed.
Table 3-10 Action and
Limit Levels for Water Quality
Parameter |
Performance
criteria |
Monitoring Location |
|||||
WM1 |
WM2A(a) |
WM2B |
WM3x |
WM4 |
|||
DO (mg/L) |
Action Level |
(*)4.23 |
(**)4.00 |
(*)4.74 |
(**)4.00 |
(*)4.14 |
|
Limit Level |
(#)4.19 |
(**)4.00 |
(#)4.60 |
(**)4.00 |
(#)4.08 |
||
Turbidity (NTU) |
Action Level |
51.3 |
24.9 |
11.4 |
13.4 |
35.2 |
|
AND 120% of upstream control station of
the same day |
|||||||
Limit Level |
67.6 |
33.8 |
12.3 |
14.0 |
38.4 |
||
AND 130% of upstream control station of the same day |
|||||||
SS (mg/L) |
Action Level |
54.5 |
14.6 |
11.8 |
12.6 |
39.4 |
|
AND 120% of upstream control station of the
same day |
|||||||
Limit Level |
64.9 |
17.3 |
12.4 |
12.9 |
45.5 |
||
AND 130% of upstream control station of the same day |
|||||||
Remarks: (*) The
Proposed Action Level of Dissolved
Oxygen is adopted to be used 5%-ile of
baseline data (**) The
Proposed Action & Limit Level of Dissolved
Oxygen is used 4mg/L (#) The
Proposed Limit Level of Dissolved
Oxygen is adopted to be used 1%-ile of
baseline data |
|||||||
3.8.2
Should non-compliance of the environmental
quality criteria occurs, remedial actions will be triggered according to the
Event and Action Plan which presented in Appendix G.
3.9.1
All monitoring data will be handled by the ET¡¦s in-house data recording and management system. The monitoring data
recorded in the equipment will be downloaded directly from the equipment at the
end of each monitoring day. The
downloaded monitoring data will input into a computerized database maintained
by the ET. The laboratory results
will be input directly into the computerized database and checked by personnel
other than those who input the data.
3.9.2
For monitoring parameters that require
laboratory analysis, the local laboratory shall follow the QA/QC requirements
as set out under the HOKLAS scheme for the relevant laboratory tests.
4.1.1
In the Reporting Period, construction works under the
project have been commenced in Contracts
2, 3, 4, 6, 7 and
Contract SS C505. Hence, air quality monitoring was performed at all designated
locations.
4.1.2
The air quality monitoring schedule is
presented in Appendix H and the monitoring results are summarized in the
following sub-sections.
4.2.1
In the Reporting Period, a total of 135 events of 1-hour TSP and 45 events 24-hours TSP monitoring were carried
out and the monitoring results are summarized in Tables 4-1 to 4-9. The detailed 24-hour TSP monitoring data
are presented in Appendix I and the relevant graphical plots are shown in Appendix
J.
Table 4-1 Summary
of 24-hour and 1-hour TSP Monitoring Results ¡V AM1c
Date |
24-hour
TSP (mg/m3) |
1-hour
TSP (mg/m3) |
||||
Date |
Start Time |
1st
reading |
2nd
reading |
3rd
reading |
||
5-Mar-20 |
26
|
3-Mar-20 |
9:32 |
68 |
73 |
80 |
11-Mar-20 |
44
|
9-Mar-20 |
9:21 |
57 |
61 |
65 |
17-Mar-20 |
72
|
14-Mar-20 |
9:53 |
64 |
68 |
71 |
23-Mar-20 |
49
|
20-Mar-20 |
9:42 |
55 |
59 |
63 |
28-Mar-20 |
37
|
26-Mar-20 |
9:24 |
51 |
54 |
58 |
Average (Range) |
46 (26 ¡V 72) |
Average (Range) |
63 (51 ¡V 80) |
Table 4-2 Summary
of 24-hour and 1-hour TSP Monitoring Results ¡V AM2
Date |
24-hour
TSP (mg/m3) |
1-hour
TSP (mg/m3) |
||||
Date |
Start Time |
1st
reading |
2nd
reading |
3rd
reading |
||
5-Mar-20 |
117
|
3-Mar-20 |
9:44 |
104 |
109 |
117 |
11-Mar-20 |
136
|
9-Mar-20 |
9:27 |
113 |
119 |
125 |
17-Mar-20 |
131
|
14-Mar-20 |
9:42 |
125 |
127 |
131 |
23-Mar-20 |
96
|
20-Mar-20 |
9:36 |
112 |
115 |
119 |
28-Mar-20 |
101
|
26-Mar-20 |
9:39 |
98 |
102 |
108 |
Average (Range) |
116 (96 ¡V 136) |
Average (Range) |
115 (98 ¡V 131) |
Table 4-3 Summary
of 24-hour and 1-hour TSP Monitoring Results ¡V AM3
Date |
24-hour
TSP (mg/m3) |
1-hour
TSP (mg/m3) |
||||
Date |
Start Time |
1st
reading |
2nd
reading |
3rd
reading |
||
5-Mar-20 |
24
|
3-Mar-20 |
13:16 |
84 |
95 |
89 |
11-Mar-20 |
71
|
9-Mar-20 |
9:32 |
61 |
64 |
71 |
17-Mar-20 |
93
|
14-Mar-20 |
13:51 |
87 |
93 |
99 |
23-Mar-20 |
63
|
20-Mar-20 |
9:31 |
66 |
69 |
73 |
28-Mar-20 |
67
|
26-Mar-20 |
13:37 |
64 |
67 |
70 |
Average (Range) |
64 (24 ¡V 93) |
Average (Range) |
77 (61 ¡V 99) |
Table 4-4 Summary
of 24-hour and 1-hour TSP Monitoring Results ¡V AM4b
Date |
24-hour
TSP (mg/m3) |
1-hour
TSP (mg/m3) |
||||
Date |
Start Time |
1st
reading |
2nd
reading |
3rd
reading |
||
3-Mar-20 |
54
|
4-Mar-20 |
9:20 |
68 |
63 |
72 |
9-Mar-20 |
53
|
10-Mar-20 |
9:15 |
71 |
76 |
74 |
14-Mar-20 |
66
|
16-Mar-20 |
9:15 |
72 |
72 |
69 |
20-Mar-20 |
73
|
21-Mar-20 |
9:09 |
61 |
66 |
59 |
26-Mar-20 |
45
|
27-Mar-20 |
9:21 |
78 |
65 |
55 |
Average (Range) |
58 (45 ¡V 73) |
Average (Range) |
68 (55 ¡V 78) |
Table 4-5 Summary
of 24-hour and 1-hour TSP Monitoring Results ¡V AM5a
Date |
24-hour
TSP (mg/m3) |
1-hour
TSP (mg/m3) |
||||
Date |
Start Time |
1st
reading |
2nd
reading |
3rd
reading |
||
3-Mar-20 |
90
|
4-Mar-20 |
13:00 |
66 |
71 |
76 |
9-Mar-20 |
57
|
10-Mar-20 |
9:19 |
71 |
64 |
62 |
14-Mar-20 |
88
|
16-Mar-20 |
9:18 |
71 |
68 |
65 |
20-Mar-20 |
77
|
21-Mar-20 |
9:15 |
73 |
61 |
66 |
26-Mar-20 |
56
|
27-Mar-20 |
9:33 |
68 |
57 |
71 |
Average (Range) |
74 (56 ¡V 90) |
Average (Range) |
67 (57 ¡V 76) |
|
|
Table 4-6 Summary
of 24-hour and 1-hour TSP Monitoring Results ¡V AM6
Date |
24-hour
TSP (mg/m3) |
1-hour
TSP (mg/m3) |
||||
Date |
Start Time |
1st
reading |
2nd
reading |
3rd
reading |
||
3-Mar-20 |
88
|
4-Mar-20 |
10:30 |
67 |
74 |
65 |
9-Mar-20 |
71
|
10-Mar-20 |
9:34 |
71 |
74 |
69 |
14-Mar-20 |
118
|
16-Mar-20 |
9:25 |
67 |
70 |
72 |
20-Mar-20 |
54
|
21-Mar-20 |
9:26 |
70 |
66 |
75 |
26-Mar-20 |
92
|
27-Mar-20 |
9:45 |
99 |
78 |
83 |
Average (Range) |
85 (54 ¡V 118) |
Average (Range) |
73 (65 ¡V 99) |
Table 4-7 Summary
of 24-hour and 1-hour TSP Monitoring Results ¡V AM7b
Date |
24-hour
TSP (mg/m3) |
1-hour
TSP (mg/m3) |
||||
Date |
Start Time |
1st
reading |
2nd
reading |
3rd
reading |
||
3-Mar-20 |
47
|
4-Mar-20 |
9:38 |
65 |
68 |
64 |
9-Mar-20 |
45
|
10-Mar-20 |
9:47 |
60 |
65 |
68 |
14-Mar-20 |
71
|
16-Mar-20 |
9:29 |
66 |
68 |
64 |
20-Mar-20 |
63
|
21-Mar-20 |
14:02 |
69 |
62 |
75 |
26-Mar-20 |
39
|
27-Mar-20 |
13:09 |
86 |
91 |
77 |
Average (Range) |
53 (39 ¡V 71) |
Average (Range) |
70 (60¡V 91) |
Table 4-8 Summary
of 24-hour and 1-hour TSP Monitoring Results ¡V AM8
Date |
24-hour
TSP (mg/m3) |
1-hour
TSP (mg/m3) |
||||
Date |
Start Time |
1st
reading |
2nd
reading |
3rd
reading |
||
3-Mar-20 |
39
|
4-Mar-20 |
13:13 |
61 |
64 |
59 |
9-Mar-20 |
28
|
10-Mar-20 |
9:34 |
53 |
52 |
56 |
14-Mar-20 |
79
|
16-Mar-20 |
9:41 |
64 |
66 |
61 |
20-Mar-20 |
55
|
21-Mar-20 |
14:10 |
72 |
61 |
69 |
26-Mar-20 |
27
|
27-Mar-20 |
13:19 |
83 |
77 |
71 |
Average (Range) |
46 (27 ¡V 79) |
Average (Range) |
65 (52 ¡V 83) |
Table 4-9 Summary
of 24-hour and 1-hour TSP Monitoring Results ¡V AM9b
Date |
24-hour
TSP (mg/m3) |
1-hour
TSP (mg/m3) |
||||
Date |
Start Time |
1st
reading |
2nd
reading |
3rd
reading |
||
5-Mar-20 |
38
|
3-Mar-20 |
9:26 |
77 |
70 |
73 |
11-Mar-20 |
89
|
9-Mar-20 |
9:08 |
60 |
56 |
57 |
17-Mar-20 |
90
|
14-Mar-20 |
14:21 |
68 |
67 |
62 |
23-Mar-20 |
28
|
20-Mar-20 |
9:19 |
68 |
62 |
65 |
28-Mar-20 |
45
|
26-Mar-20 |
14:08 |
61 |
63 |
60 |
Average (Range) |
58 (28 ¡V 90) |
Average (Range) |
65 (56 ¡V 77) |
4.2.2
As shown in Tables 4-1 to 4-9, all
the 1-hour and 24-hour TSP
monitoring results were below the Action/Limit Levels. No Notification of Exceedance (NOE) was
issued in this Reporting Period.
4.2.3
The meteorological data during the impact
monitoring days are summarized in Appendix K.
5.1.1
In the Reporting Period, construction works under the
project have been commenced in Contracts
2, 3, 4, 6, 7 and
Contract SS C505 and noise monitoring was performed at all designated
locations.
5.1.2
The noise monitoring schedule is presented in
Appendix
H and the monitoring results are summarized in the following
sub-sections.
5.2.1
In the Reporting Period, a total of 40 events noise measurements were carried out at the
designated locations. The sound
level meter was set in 1m from the exterior of the building façade including
noise monitoring locations NM1, NM3, NM4, NM5, NM6, NM7, NM8 and NM9. Therefore, no façade correction (+3 dB(A)) is added according to acoustical principles and EPD
guidelines. However, free-field
status were performed at NM2a and NM10 and façade correction (+3 dB(A)) has added according to the requirement in this
month. The noise monitoring results
at the designated locations are summarized in Tables 5-1 and 5-2. The detailed noise monitoring
data are presented in Appendix I and the relevant
graphical plots are shown in Appendix J.
Table 5-1 Summary of Construction Noise Monitoring Results
Construction Noise Level (Leq30min), dB(A) |
|||||
Date |
NM1 |
NM2a(*) |
NM8 |
NM9 |
NM10(*) |
3-Mar-20 |
56
|
68 |
59 |
62 |
62 |
9-Mar-20 |
55
|
71 |
58 |
63 |
60 |
20-Mar-20 |
55
|
71 |
59 |
60 |
61 |
26-Mar-20 |
51
|
68 |
57 |
61 |
62 |
Limit Level |
75 dB(A) |
Remarks
(*) façade
correction (+3 dB(A) is added according to acoustical
principles and EPD guidelines
Table 5-2 Summary of Construction Noise Monitoring Results
Construction Noise Level (Leq30min), dB(A) |
|
|||||||
Date |
NM3 |
NM4 |
NM5 |
NM6 |
NM7 |
|
||
4-Mar-20 |
58 |
60 |
55 |
56 |
51 |
|
||
10-Mar-20 |
59 |
63 |
51 |
59 |
46 |
|
||
16-Mar-20 |
59 |
63 |
53 |
59 |
53 |
|
||
27-Mar-20 |
60 |
63 |
56 |
59 |
56 |
|
||
Limit Level |
75 dB(A) |
|
|
54 |
5.2.2
As shown in Tables
5-1 and 5-2, no
construction noise measurement results that exceeded the Limit Level were
recorded. Moreover, no valid noise complaint (which triggered Action Level
exceedance) was recorded in the Reporting Period.
6.1.1
In the Reporting Period, construction works under the
project has been commenced in Contracts
2, 3, 4, 6, 7 and
Contract SS C505 and water quality monitoring was performed at all designated
locations. The water quality
monitoring schedule is presented in Appendix H. The monitoring results are summarized in
the following sub-sections.
6.2.1
In the Reporting Period, a total of thirteen (13) sampling days were scheduled
to carry out for all designated locations with their control stations.
6.2.2
The key monitoring parameters including Dissolved Oxygen, Turbidity and Suspended
Solids are summarized in Tables 6-1 to 6-5. Breaches of water quality monitoring
criteria are shown in Table 6-6. Detailed monitoring database including
in-situ measurements and laboratory analysis data are shown in Appendix
I and the relevant graphical plot are shown in Appendix J.
Table 6-1 Water
Quality Monitoring Results Associated of Contracts 2 and 3
Date |
Dissolved Oxygen (mg/L) |
Turbidity (NTU) |
Suspended Solids (mg/L) |
||||||
WM4 |
WM4-CA |
WM4-CB |
WM4 |
WM4-CA |
WM4-CB |
WM4 |
WM4-CA |
WM4-CB |
|
2-Mar-20 |
5.7 |
7.2 |
6.3 |
4.4 |
0.8 |
13.0 |
6.0 |
<2 |
25.5 |
4-Mar-20 |
6.0 |
7.1 |
7.8 |
4.0 |
1.6 |
10.7 |
5.5 |
<2 |
21.0 |
6-Mar-20 |
6.5 |
6.8 |
8.0 |
6.8 |
1.6 |
15.6 |
8.5 |
2.0 |
18.5 |
9-Mar-20 |
5.5 |
6.7 |
6.7 |
4.3 |
2.1 |
11.5 |
8.0 |
2.0 |
19.5 |
11-Mar-20 |
5.8 |
6.8 |
7.0 |
2.4 |
0.9 |
7.7 |
4.0 |
<2 |
16.5 |
13-Mar-20 |
5.7 |
6.9 |
8.0 |
4.1 |
2.0 |
8.7 |
8.0 |
3.0 |
12.5 |
16-Mar-20 |
6.1 |
6.5 |
9.5 |
2.9 |
0.8 |
8.5 |
5.0 |
<2 |
12.5 |
18-Mar-20 |
6.6 |
7.0 |
6.7 |
175.0 |
90.7 |
208.5 |
198.0 |
185.5 |
434.0 |
20-Mar-20 |
5.8 |
6.4 |
7.4 |
3.8 |
3.4 |
12.2 |
5.0 |
4.0 |
28.0 |
23-Mar-20 |
5.7 |
6.6 |
8.1 |
5.0 |
1.5 |
10.0 |
7.5 |
<2 |
15.5 |
25-Mar-20 |
5.7 |
6.6 |
8.7 |
6.6 |
0.8 |
8.0 |
10.0 |
<2 |
12.5 |
27-Mar-20 |
5.8 |
6.3 |
8.9 |
4.3 |
1.3 |
8.6 |
6.0 |
<2 |
12.0 |
30-Mar-20 |
6.4 |
7.6 |
6.9 |
12.4 |
2.7 |
9.3 |
25.5 |
3.5 |
19.0 |
|
|
Table 6-2 Water
Quality Monitoring Results Associated of Contracts 6 and SS C505
Date |
Dissolved Oxygen (mg/L) |
Turbidity (NTU) |
Suspended Solids (mg/L) |
|||
WM1 |
WM1-C |
WM1 |
WM1-C |
WM1 |
WM1-C |
|
2-Mar-20 |
7.2 |
3.7 |
10.8 |
62.0 |
15.5 |
63.0 |
4-Mar-20 |
7.3 |
7.0 |
18.5 |
52.8 |
17.0 |
93.5 |
6-Mar-20 |
8.6 |
7.5 |
42.3 |
57.8 |
36.0 |
117.0 |
9-Mar-20 |
4.7 |
7.7 |
6.4 |
69.4 |
4.5 |
136.0 |
11-Mar-20 |
5.4 |
3.2 |
60.2 |
96.0 |
84.0 |
119.0 |
13-Mar-20 |
5.3 |
4.0 |
10.0 |
23.1 |
4.5 |
12.5 |
16-Mar-20 |
8.1 |
3.8 |
6.1 |
50.7 |
2.0 |
53.5 |
18-Mar-20 |
6.6 |
3.0 |
3.8 |
69.4 |
2.0 |
73.0 |
20-Mar-20 |
6.1 |
3.7 |
717.0 |
Ove range |
300.5 |
476.5 |
23-Mar-20 |
5.1 |
2.1 |
41.5 |
210.0 |
27.5 |
129.5 |
25-Mar-20 |
6.5 |
5.8 |
13.9 |
79.1 |
9.5 |
62.5 |
27-Mar-20 |
7.2 |
3.7 |
40.6 |
639.0 |
34.5 |
618.5 |
30-Mar-20 |
6.8 |
5.8 |
16.9 |
105.5 |
7.0 |
79.0 |
|
Table 6-3 Water
Quality Monitoring Results Associated only Contract 6
Date |
Dissolved Oxygen (mg/L) |
Turbidity (NTU) |
Suspended Solids (mg/L) |
|||||||||
WM2A(a) |
WM2A- Cx |
WM2B |
WM2B- C |
WM2A(a) |
WM2A- Cx |
WM2B |
WM2B- C |
WM2A(a) |
WM2A- Cx |
WM2B |
WM2B- C |
|
2-Mar-20 |
4.9 |
7.4 |
* |
* |
7.1 |
4.7 |
* |
* |
7.0 |
<2 |
* |
* |
4-Mar-20 |
6.4 |
8.0 |
* |
* |
14.5 |
6.3 |
* |
* |
7.5 |
<2 |
* |
* |
6-Mar-20 |
5.0 |
8.3 |
* |
* |
14.1 |
2.9 |
* |
* |
13.5 |
<2 |
* |
* |
9-Mar-20 |
5.5 |
6.8 |
* |
* |
8.0 |
3.9 |
* |
* |
12.5 |
4.0 |
* |
* |
11-Mar-20 |
4.9 |
7.8 |
* |
* |
8.4 |
4.0 |
* |
* |
14.5 |
3.0 |
* |
* |
13-Mar-20 |
6.2 |
7.5 |
* |
* |
5.9 |
3.4 |
* |
* |
7.5 |
<2 |
* |
* |
16-Mar-20 |
6.0 |
7.5 |
* |
* |
7.7 |
4.2 |
* |
* |
10.0 |
2.0 |
* |
* |
18-Mar-20 |
4.5 |
6.9 |
* |
* |
10.4 |
5.5 |
* |
* |
8.5 |
<2 |
* |
* |
20-Mar-20 |
6.7 |
6.4 |
* |
* |
22.4 |
25.3 |
* |
* |
13.5 |
12.0 |
* |
* |
23-Mar-20 |
6.3 |
7.4 |
* |
* |
18.4 |
2.8 |
* |
* |
10.0 |
2.0 |
* |
* |
25-Mar-20 |
4.6 |
6.3 |
* |
* |
20.2 |
8.8 |
* |
* |
10.5 |
7.5 |
* |
* |
27-Mar-20 |
5.7 |
6.5 |
* |
* |
21.3 |
6.0 |
* |
* |
14.0 |
3.0 |
* |
* |
30-Mar-20 |
6.6 |
7.1 |
* |
* |
19.8 |
4.6 |
* |
* |
11.5 |
3.0 |
* |
* |
Remarks: * water sampling was unable to carry out at WM2B
and WM2B-C due to shallow water (water depth under 150mm) |
Table 6-4 Water
Quality Monitoring Results Associated Contracts 2 and 6
Date |
Dissolved Oxygen (mg/L) |
Turbidity (NTU) |
Suspended Solids (mg/L) |
|||
WM3x |
WM3-C |
WM3x |
WM3-C |
WM3x |
WM3-C |
|
2-Mar-20 |
8.2 |
* |
4.2 |
* |
6.5 |
* |
4-Mar-20 |
8.0 |
* |
2.7 |
* |
<2 |
* |
6-Mar-20 |
8.6 |
* |
4.5 |
* |
2.5 |
* |
9-Mar-20 |
7.9 |
* |
5.0 |
* |
4.5 |
* |
11-Mar-20 |
8.3 |
* |
3.5 |
* |
2.5 |
* |
13-Mar-20 |
8.2 |
* |
6.2 |
* |
4.5 |
* |
16-Mar-20 |
8.4 |
* |
5.3 |
* |
11.5 |
* |
18-Mar-20 |
9.2 |
* |
11.4 |
* |
12.0 |
* |
20-Mar-20 |
5.4 |
* |
3.1 |
* |
5.5 |
* |
23-Mar-20 |
4.6 |
* |
5.1 |
* |
7.0 |
* |
25-Mar-20 |
4.9 |
* |
3.1 |
* |
11.0 |
* |
27-Mar-20 |
6.0 |
* |
3.1 |
* |
3.0 |
* |
30-Mar-20 |
6.2 |
* |
4.2 |
* |
5.0 |
* |
Remarks: * water sampling was unable to
carry out at WM3-C due to shallow water (water depth under 150mm)
Table 6-5 Action
and Limit (A/L) Levels Exceedance Recorded
Location |
Dissolved Oxygen |
Turbidity |
Suspended Solids |
Total Exceedance |
Project Related exceedance |
|||||
AL |
LL |
AL |
LL |
AL |
LL |
AL |
LL |
AL |
LL |
|
WM1 |
0 |
0 |
0 |
0 |
0 |
0 |
0 |
0 |
0 |
0 |
WM2A(a) |
0 |
0 |
0 |
0 |
0 |
0 |
0 |
0 |
0 |
0 |
WM2B |
0 |
0 |
0 |
0 |
0 |
0 |
0 |
0 |
0 |
0 |
WM3x |
0 |
0 |
0 |
0 |
0 |
0 |
0 |
0 |
0 |
0 |
WM4 |
0 |
0 |
0 |
0 |
0 |
0 |
0 |
0 |
0 |
0 |
No of Exceedance |
0 |
0 |
0 |
0 |
0 |
0 |
0 |
0 |
0 |
0 |
6.2.3
In this Reporting Period, no exceedance was
recorded for water quality monitoring. No corrective measure was therefore
required.
7.1.1
According to
the approved Woodland Compensation Plan (WCP), ecological monitoring for woodland compensation shall be conducted at
bi-monthly interval for the first year and the monitoring frequency would be
reduced to quarterly from the second year.
7.1.2
As Stage 2
of the enhancement planting work was undertaken in August 2019 has covered all
of the 9 monitoring quadrats, the monitoring frequency should have increased
from quarterly to bi-monthly interval for the first year of enhancement
planting.
7.1.3
The bi-monthly
ecological monitoring for period of January 2020 to February 2020 had carried
out on 17th and 18th February 2020 by transects
inspection and quadrat monitoring. The
bi-monthly Ecological Monitoring Report was verified by IEC on 19 March 2020
and it has been submitted as a stand-alone copy to supplement the EM&A
Report on 19 March 2020.
7.2.1
According to
the approved Habitat Creation and Management Plan (HCMP), the proposed Wetland
Compensation Area (WCA) near the Ping Yeung Interchange adjacent to the section
of Ping Yuen River was adopted. Ecological
monitoring at implementation and establishment periods of WCA will be conducted
to cover the ecological attributes. Implementation of the wetland will
commence within the construction phase after completion of the construction
works at Ping Yeung Section. Monitoring
on the WCA will be conducted in implementation and establishment stages.
7.2.2
Site
inspection for the implementation of WCA was conducted by ET as part of the
weekly inspection of Contract 6 on 5, 12, 17 and 26 March 2020. It was observed that excavation of the water
ponds was completed and water proof layering was on-going in the WCA. The forthcoming remaining activities
would be landscaping in the WCA. There
was no
non-compliance observed during the site inspection. The findings / deficiencies observed during site inspection could be
referred to Table 9-4 Site
Observations for Contract 6.
7.2.3
The photographic record for site inspection of
WCA is presented in Appendix L.
8.1.1
Waste management was carried out in
accordance with the Waste Management Plan (WMP) for each contract.
8.2.1
All types of waste arising from the
construction work are classified into the following:
l Construction
& Demolition (C&D) Material;
l Chemical
Waste;
l General
Refuse; and
l Excavated
Soil.
8.2.2
The quantities of waste for disposal in this
Reporting Period are summarized in Tables 8-1 and 8-2 and the Monthly
Summary Waste Flow Table is shown in Appendix M.
Whenever possible, materials were reused on-site as far as practicable.
Table 8-1 Summary
of Quantities of Inert C&D Materials for the Project
Type of Waste |
Contract 2 |
Contract 3 |
Contract 4 |
Contract 6 |
Contract 7 |
Contract SS C505 |
Total Qty. |
||||||
Qty. |
Disposal location |
Qty. |
Disposal location |
Qty. |
Disposal location |
Qty. |
Disposal location |
Qty. |
Disposal location |
Qty. |
Disposal location |
||
C&D Materials (Inert) (in '000m3) |
2.5938 |
-- |
0.089 |
-- |
0 |
-- |
7.623 |
-- |
0 |
-- |
0.026 |
-- |
10.3318 |
Reused in this Contract (Inert) (in '000 m3) |
0 |
-- |
0 |
-- |
0 |
-- |
0 |
-- |
0 |
-- |
0 |
-- |
0 |
Reused in other Contracts/ Projects (Inert) (in '000 m3) |
0 |
-- |
0 |
-- |
0 |
-- |
0 |
-- |
0 |
-- |
0 |
-- |
0 |
Disposal as Public Fill (Inert) (in '000 m3) |
2.5938 |
Tuen Mun 38 |
0.089 |
Tuen Mun 38 |
0 |
-- |
7.623 |
Tuen Mun 38 |
0 |
-- |
0.026 |
Tuen Mun 38 |
10.3318 |
Table 8-2 Summary
of Quantities of C&D Wastes for the Project
Type of Waste |
Contract 2 |
Contract 3 |
Contract 4 |
Contract 6 |
Contract 7 |
Contract SS C505 |
Total Quantity |
||||||
Qty. |
Disposal location |
Qty. |
Disposal location |
Qty. |
Disposal location |
Qty. |
Disposal location |
Qty. |
Disposal location |
Qty. |
Disposal location |
||
Recycled Metal (¡¥000kg) # |
0 |
-- |
0 |
- |
0 |
-- |
0 |
-- |
0 |
-- |
0 |
-- |
0 |
Recycled
Paper / Cardboard Packing (¡¥000kg) # |
0 |
-- |
0 |
- |
0 |
- |
0 |
-- |
0 |
- |
0 |
-- |
0 |
Recycled Plastic (¡¥000kg) # |
0 |
-- |
0 |
- |
0 |
- |
0 |
-- |
0 |
- |
0 |
-- |
0 |
Chemical Wastes (¡¥000kg) # |
0 |
-- |
0 |
- |
0 |
-- |
0 |
-- |
0 |
-- |
0 |
-- |
0 |
General Refuses (¡¥000m3) |
0.0634 |
NENT |
0.025 |
NENT |
0 |
-- |
0.417 |
NENT |
0 |
-- |
0.234 |
NENT |
0.7394 |
Remark #: Unit of recycled metal, recycled paper/ cardboard packing and recycled plastic under Contract 3 was in (¡¥000m3) while the unit of chemical wastes for Contract 3 was in (¡¥m3).
9.1.1
According to the approved EM&A Manual,
the environmental site inspection shall be formulation by ET Leader. Weekly environmental site inspections
should carry out to confirm the environmental performance.
Contract 2
9.2.1
In the Reporting Period, joint site
inspection for Contract 2 to evaluate the site environmental performance has
been carried out by the RE, ET and the Contractor on 6, 13, 20 and 27 March
2020 in which IEC joined the
site inspection on 20 March 2020. No non-compliance was noted.
9.2.2
The findings / deficiencies of Contract
2 that observed during the weekly site inspection are listed in Table
9-1.
Table 9-1 Site
Observations for Contract 2
Date |
Findings / Deficiencies |
Follow-Up Status |
6 March 2020 |
No adverse environmental issue was
observed. |
NA |
13 March 2020 |
The Contractor was reminded to remove
silt in the channel. |
Not required for reminder. |
20 March 2020 |
The Contractor was reminded to remove
silt and stagnant water in the channel. |
Not required for reminder. |
27 March 2020 |
No adverse environmental issue was
observed. |
NA |
Contract 3
9.2.3
In the Reporting Period, joint site
inspection for Contract 3 to evaluate the site environmental performance has
been carried out by the RE, ET and the Contractor on 5, 13, 19 and 25 March
2020 in which IEC joined the
site inspection on 19 March 2020.
No non-compliance was noted.
9.2.4
The findings / deficiencies of Contract
3 that observed during the weekly site inspection are listed in Table
9-2.
Table 9-2 Site
Observations for Contract 3
Date |
Findings / Deficiencies |
Follow-Up Status |
5 March 2020 |
Muddy trails were observed at TWSRE. The Contractor should
clean the trail and ensure wash the wheel thoroughly before leaving the site.
The
Contractor was reminded to removed silt and waste in the channel. |
The muddy trail was removed. Not required for reminder. |
13 March 2020 |
The Contractor was reminded to cover the
stockpile properly. The Contractor was reminded to maintain
site exit clean and tidy. |
Not
required for reminder. Not
required for reminder. |
19 March 2020 |
Muddy trail was observed at TWSRE site
exit. The Contractor should clean the muddy trail as soon as possible and
wash the wheels thoroughly before leaving the site. Open stockpile was observed at TWSRW. The
Contractor should cover the stockpile with tarpaulin sheet to reduce dust
emission. The Contractor was reminded to provide
drip tray for any chemical containers. |
Muddy trail was removed. Water spraying was provided to reduce
dust impact. Not required for reminder. |
25 March 2020 |
Free standing chemical containers were
observed at TWSRW. The Contractor should provide drip tray for chemical
containers to prevent land contamination. |
Chemical containers were removed. |
Contract 4
9.2.5
In the Reporting Period, joint site
inspection for Contract 4 to
evaluate the site environmental performance has been carried out by the RE, ET
and the Contractor on 6, 13, 16 and 27 March 2020 in which IEC joined the site inspection on 16
March 2020. No non-compliance was noted.
9.2.6
The findings / deficiencies of Contract
4 that
observed during the weekly site inspection are listed in Table 9-3.
Table 9-3 Site
Observations for Contract 4
Date |
Findings / Deficiencies |
Follow-Up Status |
6 March 2020 |
No adverse environmental issue was
observed. |
NA |
13 March 2020 |
No adverse environmental issue was
observed. |
NA |
16 March 2020 |
No adverse environmental issue was
observed. |
NA |
27 March 2020 |
No adverse environmental issue was
observed. |
NA |
Contract 6
9.2.7
In the Reporting Period, joint site
inspection for Contract 6 to evaluate the site environmental performance has
been carried out by the RE, ET and the Contractor on 5, 12, 17 and 26 March
2020 in which IEC joined the
site inspection on 17 March 2020.
No non-compliance was noted.
9.2.8
The findings / deficiencies of Contract
6 that observed during the weekly site inspection are listed in Table
9-4.
Table 9-4 Site
Observations for Contract 6
Date |
Findings / Deficiencies |
Follow-Up Status |
5 March 2020 |
Muddy trail was observed at check dam.
The contractor should clean the trail and provide proper wheel washing
facility. Free standing chemical containers were
observed at WCA. The Contractor should place drip tray underneath the
containers to prevent land contamination. |
Muddy trail was cleaned. Chemical containers were removed. |
12 March 2020 |
No adverse environmental issue was
observed. |
NA |
17 March 2020 |
No adverse environmental issue was
observed. |
NA |
26 March 2020 |
Free standing chemical containers were
observed on ground at WCA. The Contractor should provide drip tray underneath
the containers to prevent land contamination. |
Chemical containers were removed. |
Contract SS C505
9.2.9
In the Reporting Period, joint site
inspection for Contract SS C505 to evaluate the site environmental performance
has been carried out by the RE, ET and the Contractor on 5, 12, 20 and 26 March
2020. IEC carried out site inspection
on 20 March 2020. No non-compliance was noted.
9.2.10
The findings / deficiencies of Contract
SS C505 that observed during the weekly site inspection are listed in Table
9-5.
Table 9-5 Site
Observations for Contract SS C505
Date |
Findings / Deficiencies |
Follow-Up Status |
5 March 2020 |
No adverse environmental issue was
observed. |
NA |
12 March 2020 |
No adverse environmental issue was
observed. |
NA |
20 March 2020 |
No adverse environmental issue was
observed. |
NA |
26 March 2020 |
No adverse environmental issue was
observed. |
NA |
Contract 7
9.2.11
In the Reporting Period, joint site
inspection for Contract 7 to evaluate the site environmental performance has
been carried out by the RE, ET and the Contractor on 5, 12, 17 and 26 March
2020 in which IEC joined the
site inspection on 17 March 2020.
No non-compliance was noted.
9.2.12
The findings / deficiencies of Contract
7 that observed during the weekly site inspection are listed in Table
9-6.
Table 9-6 Site
Observations for Contract 7
Date |
Findings / Deficiencies |
Follow-Up Status |
5 March 2020 |
No adverse environmental issue was
observed. |
NA |
12 March 2020 |
No adverse environmental issue was
observed. |
NA |
17 March 2020 |
No adverse environmental issue was
observed. |
NA |
26 March 2020 |
No adverse environmental issue was
observed. |
NA |
9.2.13
General housekeeping such as daily site
tidiness and cleanliness should be
maintained for all Contracts. Furthermore, the Contractors were
reminded to implement Waste Management Plan of the Project.
10.1.1
In the Reporting Period, one environmental complaint regarding to noise and dust nuisance was
recorded. The status of the investigation report in reporting months is
summarized below.
Date of complaint |
Complaint Detail |
Investigation Status |
26 March 2020 |
EPD received a public
complaint in early March 2020 against the captioned C6 project about night
time construction work (at about 2330-0030 hrs) and construction dust
nuisance and requested follow up. (Contract 6) |
In our investigation,
there were no construction activities under Contract 6 during the concerned period, it is considered that the complaint is not valid
to Contract 6. Nevertheless, CCKJV
was reminded to strictly follow the relevant requirements of the CNP when
carrying out the construction works in restricted hours. The IR was completed by
ET without comment by IEC which enclosed in Appendix R. |
10.1.2
No summons
and prosecution
under the EM&A Programme was lodged for all Contracts.
10.1.3
The statistical summary of environmental complaint is
presented in Tables 10-1, 10-2 and 10-3.
Table 10-1 Statistical
Summary of Environmental Complaints
Reporting Period |
Contract No |
Environmental
Complaint Statistics |
Project related
complaint |
||
Frequency |
Cumulative |
Complaint Nature |
|||
19 May 2014 ¡V 29 February 2020 |
Contract 2 |
0 |
38 |
(19)Water Quality (10) Dust (6) Noise (1) dust & noise (1) waste management
(1) Water quality and dust |
(7) water quality (3) dust (1) noise |
06 Nov 2013 ¡V 29 February 2020 |
Contract 3 |
0 |
10 |
(3) Dust (3) Water quality (2) Noise (2) site
cleanliness (dust & water quality) |
(1) site
cleanliness (dust & water quality) |
16 Aug 2013 ¡V 29 February 2020 |
Contract 4 |
0 |
0 |
NA |
NA |
16 Aug 2013 ¡V 29 February 2020 |
Contract 6 |
0 |
45 |
(24) Water Quality (12) Dust (3) Noise (1) Nuisance (1) Noise and dust (3) Water quality and dust (1) Water quality and noise |
(8) water quality (3) dust (1) nuisance (1) water quality and dust (1) water quality and noise |
15 Feb 2016 ¡V 29 February 2020 |
Contract 7 |
0 |
4 |
(1) Noise (3) Water quality and dust |
(1) water quality and dust |
16 Aug 2013 ¡V 29 February 2020 |
SS C505 |
0 |
8 |
(1) Noise (2) dust (3) Water quality and dust (2) Water quality |
(1) water quality and dust |
1 ¡V 31 March 2020 |
Contract 2 |
0 |
38 |
(19)Water Quality (10) Dust (6) Noise (1) dust & noise (1) waste management
(1) Water quality and dust |
NA |
Contract 3 |
0 |
10 |
(3) Dust (3) Water quality (2) Noise (2) site
cleanliness (dust & water quality) |
NA |
|
Contract 4 |
0 |
0 |
NA |
NA |
|
Contract 6 |
1 |
46 |
(24) Water Quality (12) Dust (3) Noise (1) Nuisance (2) Noise and dust (3) Water quality and dust (1) Water quality and noise |
NA |
|
Contract 7 |
0 |
4 |
(1) Noise (3) Water quality and dust |
NA |
|
SS C505 |
0 |
8 |
(1) Noise (2) dust (3) Water quality and dust (2) Water quality |
NA |
Table 10-2 Statistical
Summary of Environmental Summons
Reporting Period |
Contract No |
Environmental
Summons Statistics |
||
Frequency |
Cumulative |
Complaint Nature |
||
19 May 2014 ¡V 29 February 2020 |
Contract 2 |
0 |
1 |
contravening the Water Pollution Control
(General) Regulations |
06 Nov 2013 ¡V 29 February 2020 |
Contract 3 |
0 |
0 |
NA |
16 Aug 2013 ¡V 29 February 2020 |
Contract 5 |
0 |
0 |
NA |
16 Aug 2013 ¡V 29 February 2020 |
Contract 6 |
0 |
0 |
NA |
15 Feb 2016 ¡V 29 February 2020 |
Contract 7 |
0 |
0 |
NA |
16 Aug 2013 ¡V 29 February 2020 |
SS C505 |
0 |
0 |
NA |
1 ¡V 31 March 2020 |
Contract 2 |
0 |
1 |
NA |
Contract 3 |
0 |
0 |
NA |
|
Contract 4 |
0 |
0 |
NA |
|
Contract 6 |
0 |
0 |
NA |
|
Contract 7 |
0 |
0 |
NA |
|
SS C505 |
0 |
0 |
NA |
Table 10-3 Statistical
Summary of Environmental Prosecutions
Reporting Period |
Contract No |
Environmental Prosecutions Statistics |
||
Frequency |
Cumulative |
Complaint Nature |
||
19 May 2014 ¡V 29 February 2020 |
Contract 2 |
0 |
1 |
contravening the Water Pollution Control
(General) Regulations |
06 Nov 2013 ¡V 29 February 2020 |
Contract 3 |
0 |
0 |
NA |
16 Aug 2013 ¡V 29 February 2020 |
Contract 5 |
0 |
0 |
NA |
16 Aug 2013 ¡V 29 February 2020 |
Contract 6 |
0 |
0 |
NA |
15 Feb 2016 ¡V 29 February 2020 |
Contract 7 |
0 |
0 |
NA |
16 Aug 2013 ¡V 29 February 2020 |
SS C505 |
0 |
0 |
NA |
1 ¡V 31 March 2020 |
Contract 2 |
0 |
1 |
NA |
Contract 3 |
0 |
0 |
NA |
|
Contract 4 |
0 |
0 |
NA |
|
Contract 6 |
0 |
0 |
NA |
|
Contract 7 |
0 |
0 |
NA |
|
SS C505 |
0 |
0 |
NA |
11.1.1
The environmental mitigation measures that
recommended in the Implementation Schedule for Environmental Mitigation
Measures (ISEMM) in the approved EM&A Manual covered the issues of dust,
noise, water and waste and they are summarized presented in Appendix
O.
Implementation of Mitigation
Measures during Construction Phase
11.1.2
All contracts under the Project shall be
implementing the required environmental mitigation measures according to the
approved EM&A Manual as subject to the site condition. Environmental mitigation measures
generally implemented by Contracts 2, 3, 4, 6, 7 and Contract SS C505 in this Reporting Period are summarized in Table
11-1.
Table 11-1 Environmental
Mitigation Measures
Issues |
Environmental
Mitigation Measures |
Water Quality |
¡P Wastewater to be treated by
the wastewater treatment facilities i.e. sedimentation tank or similar
facility before discharge. |
Air Quality |
¡P Maintain damp / wet surface
on access road ¡P Low vehicular speed within
the works areas. ¡P All vehicles must use wheel
washing facility before off site ¡P Sprayed water during
breaking works ¡P A
cleaning truck was regularly performed on the public road to prevent fugitive dust emission |
Noise |
¡P Restrain operation time of
plants from 07:00 to 19:00 on any working day except for Public Holiday and
Sunday. ¡P Keep good maintenance of
plants ¡P Place noisy plants away from
residence or school ¡P Provide noise barriers or
hoarding to enclose the noisy plants or works ¡P Shut down the plants when
not in used. |
Waste and Chemical Management |
¡P On-site sorting prior to
disposal ¡P Follow requirements and
procedures of the ¡§Trip-ticket System¡¨ ¡P Predict required quantity of
concrete accurately ¡P Collect the unused fresh
concrete at designated locations in the sites for subsequent disposal |
General |
¡P The site was generally kept
tidy and clean. |
Implementation of Mitigation
Measures during Operation Phase
11.1.3
The Heung Yuen Wai
(HYW) Highway and connecting roads under the Project was opened on 26 May
2019. Since partial commencement of
operation is the same as the commencement of operation for the entire project
from EIAO perspective. All relevant
requirements as stipulated in the EP and the approved EIA report (including the
EM&A Manual) for the commencement of operation of the Project shall be
strictly complied with.
11.1.4
In general, the recommended mitigation measures for operation stage of HYW Highway and connecting roads under the Project have been implemented. The implementation status of mitigation
measures for operation phase in the Reporting Period are summarized in Appendix P.
11.1.5
For more details
about the implementation status of mitigation measures for operation phase with
photo illustration, an Environmental Monitoring and Audit report on the
implementation of the mitigation measures for operation stage of the Project
will be disposed to EPD not later than three months after the commencement of
operation of the Project under EP-404/2011/D condition 5.5. The abovementioned
report was submitted to EPD on 23 August 2019.
11.1.6
Pursuant to EM&A Manual Section 10.2, the implementation of
landscape mitigation measures during establishment period shall be audited by a
qualified landscape architect of the ET, to ensure compliance with the aims of
proposed measures. Site inspection should be undertaken at least once per
month. The checklist for the implementation
status is shown in Appendix P.
11.2.1
As advised by the ER, the construction works
under Contract 5 was substantially completed on 31 August 2016. Construction activities for other
Contracts in the coming month are listed below:
Contract 2
Rectification of identified defects
Rectification of soft landscape defects
Maintenance works during the defect liability
period
Contract 3
Road pavement works
Contract 4
OPT & DLP of control room, TCSS & PA
Cabling, TCSS&FVMS installation
Contract 6
Water Pipe Connection Work
Road Construction
Landscaping
Landscaping works for the proposed Wetland
Contract 7
General cleaning
Defect rectification
Street Lighting
Ducting at Bridge B&D
Contract SS C505
Defect Rectification Works involving
primarily:
Building cladding and curtain walls;
Building internal fit-out, finishing and signages;
E&M defect rectifications, testing and
commissioning;
Soft Landscaping and related green area
maintenance works
11.3.1
Key
issues to be considered in the coming month for Contracts 2, 3, 4, 6, 7 and SS C505 include:
Implementation of control measures for rainstorm;
Regular clearance of stagnant water during wet
season;
Implementation of dust suppression measures at all
times;
Potential wastewater quality impact due to surface
runoff;
Potential fugitive dust quality impact due from the
dry/loose/exposure soil surface/dusty material;
Disposal of empty engine oil containers within site
area;
Ensure dust suppression measures are implemented
properly;
Sediment catch-pits and silt removal facilities
should be regularly maintained;
Management of chemical wastes;
Discharge of site effluent to the nearby wetland,
stockpiling or disposal of materials, and any dredging or construction area at
this area are prohibited;
Follow-up of improvement on general waste
management issues; and
Implementation of construction noise preventative
control measures
11.3.2
The project (except
for the BCP building complex) was commenced on 26 May 2019. All relevant
requirements as stipulated in the EP and the approved EIA report (including the EM&A Manual) for the
commencement of operation of the Project shall be strictly complied with.
11.3.3
As rainy season approaching,
the contractors should pay special attention on water quality mitigation
measures and fully implement according to the ISEMM of the EM&A Manual, in
particular to prevent muddy water or other water pollutants from site surface
overflow to public area should be properly maintained. The statuses of implemented water
quality mitigation measures for the project are shown in Appendix Q.
12.1.1
This is the 80th monthly EM&A report presenting the monitoring results and inspection
findings for the Reporting Period from 1 to 31 March 2020.
12.1.2
The project (except
for the BCP building complex) was commenced on 26 May 2019. In view of the partial commencement of
operation to be considered as the same as the commencement of operation for the
entire project, all relevant requirements as stipulated in the EP and the
approved EIA report (including the EM&A Manual) for the commencement of
operation of the Project shall be strictly complied with. The implementation status of mitigation
measures for operation phase in the Reporting Period will be presented in the
Report.
12.1.3
For
air quality monitoring, no 1-hour TSP and 24-hour TSP monitoring results triggered the Action /Limit Level was recorded.
12.1.4
In the Reporting Period, no construction
noise measurement results that exceeded the Limit Level were recorded. Moreover, no valid noise
complaint (which
triggered an Action Level)
exceedance was recorded.
12.1.5
In the Reporting Period, no exceedance was
recorded for water quality monitoring.
12.1.6
Site
inspection for the construction of WCA was conducted by ET as part of the
weekly inspection of Contract 6 on 5, 12, 17 and 26 March 2020. It was observed that excavation of the water
ponds was completed and water proof layering was on-going in the WCA. There was
no
non-compliance observed during the site inspection. The forthcoming remaining activities
would be landscaping in the WCA.
12.1.7
In this Reporting Period,
one environmental complaint was received regarding night time construction work
(at about 2330 ¡V 0300 hrs) and construction dust
nuisance related to Contract 6. The
investigation report was conducted by ET accordingly and revealed that there
were no construction activities under Contract 6 during the concerned period
and it is considered that the complaint was no valid to Contract 6.
12.1.8
During
the Reporting Period, weekly joint site inspection by the RE, ET with the relevant Main-contractor were
carried out for Contracts 2, 3, 4, 6,
7 and SS
C505 in accordance with the EM&A Manual stipulation. Weekly
joint site inspection was carried out
by the RE, IEC, ET
and main-contractor
whereas IEC performed
monthly site inspection. No non-compliance observed during the
site inspection.
12.2.1
As wet season approaching, preventive
measures for muddy water or other water pollutants from site surface flow to local
stream such as Kong Yiu Channel, Ma Wat Channel, Ping Yuen River, Kwan Tei River or
public area should be properly maintained.
The Contractors should paid special attention on water quality
mitigation measures and fully implement according ISEMM of the EM&A Manual.
12.2.2
In
addition, all effluent discharge shall be ensure to fulfill Technical
Memorandum of Effluent Discharged into Drainage and Sewerage Systems, inland
and Coastal Waters criteria or discharge permits stipulation.
12.2.3
Construction
noise would be a key environmental issue during construction work of the
Project. Noise mitigation measures
such as using quiet plants should be implemented in accordance with the
EM&A requirement.
12.2.4
Furthermore, daily cleaning and weekly tidiness shall be properly performed
and maintained. In addition, mosquito
control should be kept to prevent mosquito breeding on site.
