Job No.: TCS00694/13 |
|
|
||
|
|
|
|
|
||
|
|
Agreement No. CE 45/2008
(CE) Liantang/Heung Yuen Wai Boundary Control Point
and Associated Works |
|
|
||
|
|
|
|
|
||
|
|
21st Quarterly Environmental Monitoring & Audit Summary Report ¡V (August
to October 2018) |
|
|
||
|
|
Prepared
For |
|
|
||
|
|
Civil Engineering and Development Department (CEDD) |
|
|
||
Quality Index |
|||
Date |
Reference No. |
Prepared By |
Certified By |
17 January 2019 |
TCS00694/13/600/R1891v4 |
|
|
Nicola
Hon (Environmental Consultant) |
T.W. Tam (Environmental Team Leader) |
Version |
Date |
Description |
1 |
7 January 2019 |
First
Submission |
2 |
11 January 2019 |
Amended
against IEC¡¦s comment |
3 |
14 January 2019 |
Further
amended against IEC¡¦s comment |
4 |
17 January 2019 |
Further
amended against IEC¡¦s comment |
This
report has been prepared by Action-United Environmental Services &
Consulting with all reasonable skill, care and diligence within the terms of
the Agreement with the client, incorporating our General Terms and Conditions
of Business and taking account of the resources devoted to it by agreement
with the client. We disclaim any responsibility to the client and others in
respect of any matters outside the scope of the above. This report is
confidential to the client and we accept no responsibility of whatsoever
nature to third parties to whom this report, or any part thereof, is made
known. Any such party relies upon the report at their own risk. |
Executive Summary
ES.01.
This is the 21st Quarterly
EM&A Summary Report for the ¡§Liantang/Heung Yuen Wai Boundary Control Point
and Associated Works¡¨ under Environmental Permit No. EP-404/2011/D (hereinafter ¡¥¡¥the EP¡¦¡¦), covering the period from 1 August to 31 October
2018
(hereinafter ¡§Reporting Period¡¨).
Environmental Monitoring and
Audit Activities
ES.02. In the
Reporting Period, the construction works under Liantang/Heung Yuen Wai
Boundary Control Point and Associated Works of the Project
included Contract 2, Contract 3, Contract 6, Contract 7 and Contract SS C505. Environmental monitoring
activities under the EM&A programme in the
Reporting Period are summarized in the following table.
Environmental Aspect |
Monitoring
Parameters / Inspection |
Reporting Period |
|
Monitoring Locations
/ Contracts |
Total Occasions |
||
Air Quality |
1-hour TSP |
9 |
432 |
24-hour TSP |
9 |
144 |
|
Construction Noise |
Leq(30min) Daytime |
10 |
130 |
Water Quality |
Water in-situ measurement and/or sampling |
WM1 & WM1-C, |
40 scheduled and 2 extra of sampling day |
WM2A & WM2A-Cx |
40 scheduled and 12
extra of
sampling day |
||
WM2B & WM2B-C |
(*) 40 Scheduled |
||
WM3 &WM3-C |
40 scheduled and 4 extra of sampling day |
||
WM4, WM4-CA &WM4-CB |
40 scheduled and 2 extra of sampling day |
||
Ecology |
Woodland compensation i) General Health condition of planted species ii) Survival of planted species |
9 Quadrats |
1 |
Joint Site Inspection / Audit |
IEC, ET, the Contractor and RE joint site Environmental Inspection and Auditing |
Contract 2 |
13 |
Contract 3 |
13 |
||
Contract 4 |
13 |
||
Contract 6 |
13 |
||
Contract 7 |
13 |
||
Contract SS C505 (#) |
14 |
Note:
Extra monitoring day was due to measurement results exceedance
(#) IEC only joined inspection for Contract SS C505 once per month.
(*) During
the whole reporting period, water sampling was unable to carry out at WM2B and WM2B-C due to shallow
water (water depth under 150mm)
Breaches
of Action/Limit levels
ES.03. In the
Reporting Period, no noise exceedance and
valid noise complaint was registered for construction noise. For air quality, no exceedance
recorded for 1-hour TSP monitoring, however, two (2) Limit Level exceedances of
24-hour TSP monitoring was recorded. For water
quality monitoring, a total of 56 Action Level/Limit Level exceedances were recorded under the Project. The summary of exceedance for the
Reporting Period is shown below.
Environmental
Aspect |
Monitoring Parameters |
Action Level |
Limit Level |
Event & Action |
||
NOE Issued |
Investigation |
Corrective Actions |
||||
Air Quality |
1-hour TSP |
0 |
0 |
0 |
-- |
-- |
24-hour TSP |
0 |
2 |
2 |
• Refer to ES.04 |
The Contractor should
fully implement the dust mitigation measures |
|
Construction Noise |
Leq(30min) Daytime |
0 |
0 |
0 |
-- |
-- |
Water Quality |
DO |
0 |
0 |
0 |
-- |
-- |
Turbidity |
1 |
26 |
27 |
• Refer to ES.05 |
The Contractor should fully implement water quality mitigation measure. |
|
SS |
2 |
27 |
29 |
ES.04. Investigation
Report for exceedances of 24-hour TSP was completed by ET. Investigation Report revealed that there
were many other heavy vehicles apart from the project using LMH Road and
exceedance was also triggered at AM3 which far from the project site,
therefore, it is considered that the major dust source leaded to the TSP
exceedance was the traffic dust along Lin Ma hang Road and the Project only has
minor contribution to the exceedance. Nevertheless, the Contractor should fully
implement the dust mitigation measures as recommended in the implementation
schedule for environmental mitigation measures in the EM&A Manual.
ES.05. Investigation
Report for all water quality exceedances was completed by ET. Most of investigation results revealed
that the Contractor had properly implemented water quality mitigation measures
such as well-maintained the wastewater treatment facility and covered the
expose area with impervious sheet and it was concluded that the exceedances
were related to the unknown source of muddy water contributed from outside the project
area and not caused by the works under the Project. However, some
investigations results revealed that exceedances recorded at WM4 concluded as partially
related to the work under Contract 2 while the Contractor has promptly rectified
the deficiency. Nevertheless, the
Contractor was reminded to fully implement the water quality mitigation measure throughout the constriction phase as far as practicable.
Environmental
Complaint
ES.06.
In this Reporting
Period, four (4) documented environmental complaints were received under the
EM&A programme with respective to the dust, muddy
water and noise issues. The
complaint details and status of investigation are summarized below.
(a) A public complaint was received by 1823 on 15 August 2018 regarding the
cleanliness of road which underneath the viaduct at Lin Ma Hang Road. Investigation
has conducted by ET and the report revealed that muddy trails were observed at
the site exit of Bridge Y and it has been rectified immediately. However, the
presence of roadside debris and small amount of gravels was related to the
frequent use of road by the project as well the villager nearby. In response to
the complaint, CCKJV has deployed manual sweeping for road edge behind the
water-filled barrier. It is
considered that CCKJV has promptly rectified the deficiencies and provided
remedial action to response the complaint.
(b) A public complaint was received on 5 October 2018 regarding
the dust concerns near the junction of Sha Tau Kok
Road and Wo Keng Shan Road and site exit at Tai Tong
Wu. Investigation has conducted by
ET and the report revealed the Contractors have implemented wheel washing
facilities and no dust and soil carrying by
site vehicles to STK road were observed.
It is considered that the complaint was not valid to the project.
(c) A public complaint was on 5
October 2018 regarding
muddy road found on
Ping Yeung Village and the
noise of construction equipment that leading to nuisance to nearby residents at
night. Investigation has conducted
by ET and the report revealed that the muddy road was related to the
unpaved haul road near the Ping Yeung Interchange
and insufficient cleaning of vehicles at site exit. Rectification works has immediately
undertaken by the Contractor. Besides, the noise issue was considered that not
valid to the project.
(d) A public complaint was received
on 25 October 2018 regarding dust concern in Shui
Lau Hang Village
intersection with Ng Chow Road. Investigation has conducted by ET and the report
revealed the Contractor has implemented wheel washing facilities and no loose materials carrying by site vehicles to Ng Chow Road was observed. It is considered
that the complaint was not valid to the project.
Notification of Summons and Successful Prosecutions
ES.07. No environmental summons or successful
prosecutions were recorded in the Reporting Period.
Reporting Changes
ES.08. No reporting
changes were made in the Reporting Period.
Future key issues
ES.09. During dry
season, special attention should be paid on the potential construction dust
impact since most of the construction sites are adjacent to villages. The
Contractor should fully implement the construction dust mitigation measures as appropriately.
ES.10. Preventive
measures for muddy water or other water pollutants from site surface flow to local
stream such as Kong Yiu Channel, Ma Wat Channel, Ping Yuen River, Kwan Tei River or
public area should be properly maintained.
The Contractors should paid special attention on water quality
mitigation measures and fully implement according ISEMM of the EM&A Manual,
in particular for working areas near Ma Wat Channel and Ping Yuen River.
ES.11. In
addition, all effluent discharge shall be ensure to fulfill Technical Memorandum
of Effluent Discharged into Drainage and Sewerage Systems, inland and Coastal
Waters criteria or discharge permits stipulation.
ES.12. Construction
noise would be a key environmental issue during construction work of the
Project. Noise mitigation measures
such as using quiet plants should be implemented in accordance with the
EM&A requirement.
ES.13. Since most
of construction sites under the Project are located adjacent to villages, the
Contractors should fully implement air quality mitigation measures to reduce
construction dust emission.
Table of Contents
2 Project Organization and
Construction progress
2.1 Construction
Contract Packaging
2.5 Summary of Environmental Submissions
3 Project Organization and
Construction progress
3.4 Monitoring
Frequency and Period
3.8 Derivation
of Action/Limit (A/L) Levels
3.9 Data
Management and Data QA/QC Control
4.2 Summary
of Monitoring Results
5 Construction Noise
Monitoring
5.2 Summary
of Monitoring Results
6.2 Summary
of Monitoring Results
8.2 Records
of Waste Quantities
10 Non-compliance, Complaints,
Notifications of Summons and Prosecutions
10.1 Status
of Non-compliance Environmental Complaint, Summons and Prosecution
11 Implementation Status of Mitigation
Measures
12 Conclusions and Recommendations
List
of tables
Table 2-1 Status
of Environmental Licenses and Permits of the Contracts
Table 3-1 Summary
of EM&A Requirements
Table 3-2 Impact
Monitoring Stations - Air Quality
Table 3-3 Impact
Monitoring Stations - Construction Noise
Table 3-4 Impact
Monitoring Stations - Water Quality
Table 3-5 Air
Quality Monitoring Equipment
Table 3-6 Construction
Noise Monitoring Equipment
Table 3-7 Water
Quality Monitoring Equipment
Table 3-8 Action
and Limit Levels for Air Quality Monitoring
Table 3-9 Action
and Limit Levels for Construction Noise
Table 3-10 Action
and Limit Levels for Water Quality
Table 4-1 Summary
of Air Quality Monitoring Results
Table 4-2 Summaries
of Breaches of Air Quality A/L Levels
Table 5-1 Summary
of Construction Noise Monitoring Results
Table 5-2 Summaries
of Breaches of Construction Noise A/L Levels
Table 6-1 Summary
of the Water Quality Monitoring Results ¡V Contracts SS C505 & 6
Table 6-2 Summary
of the Water Quality Monitoring Results ¡V Contracts 2 & 3
Table 6-3 Summary
of the Water Quality Monitoring Results ¡V Contract 6
Table 6-4 Summary
of the Water Quality Monitoring Results ¡V Contracts 2 & 6
Table 6-5 Summaries
of Breaches of the Existing Water Quality A/L Levels
Table 6-6 Summary
of Water Quality Exceedance in the Reporting Period
Table 8-1 Summary
of Quantities of Inert C&D Materials
Table 8-2 Summary
of Quantities of C&D Wastes
Table 9-1 Summary
of Reminders/Observations of Site Inspection ¡V Contract 2
Table 9-2 Summary
of Reminders/Observations of Site Inspection ¡V Contract 3
Table 9-3 Summary
of Reminders/Observations of Site Inspection ¡V Contract 4
Table 9-4 Summary
of Reminders/Observations of Site Inspection ¡V Contract 6
Table 9-5 Summary
of Reminders/Observations of Site Inspection ¡V Contract SS C505
Table 9-6 Summary
of Reminders/Observations of Site Inspection ¡V Contract 7
Table 10-1 Statistical
Summary of Environmental Complaints
Table 10-2 Statistical
Summary of Environmental Summons
Table 10-3 Statistical
Summary of Environmental Prosecution
Table 11-1 Environmental
Mitigation Measures
List of Annexes
Appendix A Layout plan of the Project
Appendix B Environmental Management Organization Chart
Appendix C Designated Monitoring Locations as Recommended in the Approved
EM&A Manual
Appendix D Monitoring Locations for Impact Monitoring
Appendix E Event and Action Plan
Appendix F Graphical Plots for Monitoring
Result
Appendix G Weather information
Appendix H Waste Flow Table
Appendix I Implementation Schedule for
Environmental Mitigation Measures
1.1.1. Civil Engineering and
Development Department is the Project
Proponent and the Permit Holder of Agreement No. CE 45/2008 (CE) Liantang /
Heung Yuen Wai Boundary Control Point and Associated Works, which is
a Designated Project to be implemented under Environmental Permit number EP-404/2011/C granted on 12 March
2015 and the latest Environmental Permit
number EP-404/2011/D granted on 20 January 2017.
1.1.2. The Project consists of two main
components: Construction of a Boundary Control Point (hereinafter referred as
¡§BCP¡¨); and Construction of a connecting road alignment. Layout plan of the Project is shown in Appendix A.
1.1.3. The proposed BCP is located at the
boundary with Shenzhen near the existing Chuk Yuen
Village, comprising a main passenger building with passenger and cargo
processing facilities and the associated customs, transport and ancillary
facilities. The connecting road
alignment consists of six main sections:
1)
Lin Ma Hang to Frontier Closed Area (FCA) Boundary ¡V this section
comprises at-grade and viaducts and includes the improvement works at Lin Ma
Hang Road;
2)
Ping Yeung to Wo Keng Shan ¡V this section
stretches from the Frontier Closed Area Boundary to the tunnel portal at Cheung
Shan and comprises at-grade and viaducts including an interchange at Ping
Yeung;
3)
North Tunnel ¡V this section comprises the tunnel segment at Cheung Shan
and includes a ventilation building at the portals on either end of the tunnel;
4)
Sha Tau Kok Road ¡V this section stretches from
the tunnel portal at Wo Keng Shan to the tunnel
portal south of Loi Tung and comprises at-grade and
viaducts including an interchange at Sha Tau Kok and
an administration building;
5)
South Tunnel ¡V this section comprises a tunnel segment that stretches from
Loi Tung to Fanling and
includes a ventilation building at the portals on either end of the tunnel as
well as a ventilation building in the middle of the tunnel near Lau Shui Heung;
6)
Fanling ¡V this section comprises the at-grade, viaducts
and interchange connection to the existing Fanling
Highway.
1.1.4.
Action-United Environmental Services & Consulting has been commissioned as an Independent ET to implement the
relevant EM&A program in accordance
with the approved EM&A Manual, as well as the associated duties.
1.1.5.
This is the 21st Quarterly EM&A Summary
Report presenting the monitoring results and inspection findings for the
Reporting Period from 1 August to 31 October 2018.
1.2.1
The Quarterly Environmental Monitoring and
Audit (EM&A) Summary Report is structured into the following sections:-
Section 1 Introduction
Section 2 Project Organization and
Construction progress
Section 3 Summary of Impact monitoring Requirements
Section 4 Air Quality Monitoring
Section 5 Construction Noise
Monitoring
Section 6 Water Quality Monitoring
Section 7 Ecology Monitoring
Section 8 Waste Management
Section 9 Site Inspection
Section 10 Non-compliance, Complaints,
Notifications of Summons and Prosecutions
Section 11 Implementation Status of Mitigation Measures
Section 12 Conclusions and Recommendations
2.1.1
To facilitate the project management and
implementation, the Project would be divided by the following contracts:
¡P
Contract 2 (CV/2012/08)
¡P
Contract 3 (CV/2012/09)
¡P
Contract 4 (NE/2014/02)
¡P
Contract 5 (CV/2013/03)
¡P
Contract 6 (CV/2013/08)
¡P
Contract 7 (NE/2014/03)
¡P
ArchSD Contract No. SS C505
2.1.2
The
details of each contracts is summarized below and the delineation of each contracts is shown in Appendix A.
Contract 2 (CV/2012/08)
2.1.3
Contract 2 has awarded in December 2013 and
construction work was commenced on 19 May 2014. Major Scope of Work of the Contract 2 is
listed below:
¡P
construction of
an approximately 5.2km long dual two-lane connecting road (with about 0.4km of
at-grade road and 4.8km of tunnel) connecting the Fanling
Interchange with the proposed Sha Tau Kok
Interchange;
¡P
construction of a
ventilation adit tunnel and the mid-ventilation
building;
¡P
construction of
the north and south portal buildings of the Lung Shan Tunnel and their
associated slope works;
¡P
provision and
installation of ventilation system, E&M works and building services works
for Lung Shan tunnel and Cheung Shan tunnel and their portal buildings;
¡P
construction of
Tunnel Administration Building adjacent to Wo Keng
Shan Road and the associated E&M and building services works; and
¡P
construction of associated
footpath, slopes, retaining structures, drainage, sewerage, waterworks,
landscaping works and other ancillary works.
Contract 3 (CV/2012/09)
2.1.4
Contract 3 was awarded in July 2013 and
construction work was commenced on 5 November 2013. Major Scope of Work of the Contract 3 is
listed below:
¡P
construction of
four link roads connecting the existing Fanling
Highway and the south portal of the Lung Shan Tunnel;
¡P
realignment of
the existing Tai Wo Service Road West and Tai Wo Service Road East;
¡P
widening of the
existing Fanling Highway (HyD¡¦s
entrustment works);
¡P
demolishing
existing Kiu Tau vehicular bridge and Kiu Tau footbridge and reconstruction of the existing Kiu Tau Footbridge (HyD¡¦s
entrustment works); and
¡P
construction of associated
footpath, slopes, retaining structures, drainage, sewerage, waterworks,
landscaping works and other ancillary works.
Contract 4 (NE/2014/02)
2.1.5
Contract 4 was awarded in mid-April 2016 and construction work will be
commenced on 2 May 2017. The scope
of work of the Contract 4 includes:
¡P
design,
supply, delivery, installation, testing and commissioning of a traffic control
and surveillance system for the connecting road linking up the Liantang / Heung Yuen Wai Boundary Control Point and the
existing Fanling Highway.
Contract 5 (CV/2013/03)
2.1.6
Contract 5 has awarded in April 2013 and
construction work was commenced in August 2013. Major Scope of Work of the Contract 5 is
listed below:
¡P
site formation of about 23
hectares of land for the development of the BCP;
¡P
construction of an
approximately 1.6 km long perimeter road at the BCP including a 175m long
depressed road;
¡P
associated
diversion/modification works at existing local roads and junctions including
Lin Ma Hang Road;
¡P
construction of pedestrian
subway linking the BCP to Lin Ma Hang Road;
¡P
provision of resite area with supporting infrastructure for reprovisioning of the affected village houses; and
¡P
construction of associated footpath, slopes, retaining structures, drainage,
sewerage, waterworks, landscaping works and other ancillary works.
Contract 6 (CV/2013/08)
2.1.7
Contract 6 was awarded in June 2015 and
construction work was commenced on 23 October 2015. Major Scope of Work of the Contract 6 would
be included below:
construction of an approximately 4.6km long dual two-lane connecting
road (with about 0.6km of at-grade road, 3.3km of viaduct and 0.7km of tunnel)
connecting the BCP with the proposed Sha Tau Kok Road
Interchange and the associated ventilation buildings;
associated diversion/modification works at access roads to the resite of Chuk Yuen Village;
provision of sewage collection, treatment and disposal facilities for
the BCP and the resite of Chuk
Yuen Village;
construction of a pedestrian subway linking the BCP to Lin Ma Hang
Road;
provisioning of the affected facilities including Wo Keng Shan Road garden; and
construction of associated
footpath, slopes, retaining structures, drainage, sewerage, waterworks,
landscaping works and other ancillary works.
Contract 7 (NE/2014/03)
2.1.8
Contract 7 was awarded in December 2015 and
the construction work was commenced 15 February 2016. Major Scope of Work of the Contract 7 would
be included below:
construction of the Hong Kong Special
Administrative Region (HKSAR) portion of four vehicular bridge
construction of one
pedestrian bridge crossing Shenzhen (SZ) River (cross boundary bridges)
ArchSD Contract No. SS
C505
2.1.9
SS C505 has been awarded in July 2015 and
construction work was commenced on 1 September 2015. Major Scope of Work of the SS C505 would
be included below:
passenger-related facilities including
processing kiosks and examination facilities for private cars and coaches,
passenger clearance building and halls, the interior fitting works for the
pedestrian bridge crossing Shenzhen River, etc.;
cargo processing facilities including kiosks
for clearance of goods vehicles, customs inspection platforms, X-ray building,
etc.;
accommodation for the facilities inside of the
Government departments providing services in connection with the BCP;
transport-related facilities inside the BCP
including road networks, public transport interchange, transport drop-off and
pick-up areas, vehicle holding areas and associated road furniture etc;
a public carpark; and
other ancillary
facilities such as sewerage and drainage, building services provisions and
electronic systems, associated environmental mitigation measure and landscape
works.
2.2.1
The project organization is shown in Appendix B. The responsibilities of respective parties are:
Civil
Engineering and Development Department (CEDD)
2.2.2
CEDD is the Project Proponent and the Permit Holder of the EP of the development
of the Project and will assume overall responsibility for the project. An
Independent Environmental Checker (IEC) shall be employed by CEDD to audit the
results of the EM&A works carried out by the ET.
Architectural
Services Department (ArchSD)
2.2.3
ArchSD acts as
the works agent for Development Bureau (DEVB), for Contract SS C505 Liantang/ Heung Yuen Wai Boundary Control Point (BCP) ¡V BCP
Buildings and Associated Facilities.
Environmental
Protection Department (EPD)
2.2.4
EPD is the statutory enforcement body for
environmental protection matters in Hong Kong.
Ronald Lu
& Partners (Hong Kong) Ltd (The Architect)
2.2.5
Ronald Lu & Partners (Hong Kong) Ltd is
appointed by ArchSD as an Architect for Contract SS
C505 Liantang/ Heung Yuen Wai Boundary Control Point
(BCP) ¡V BCP Buildings and Associated Facilities. It responsible for overseeing the
construction works of Contract SS C505 and for ensuring that the works are
undertaken by the Contractor in accordance with the specification and contract
requirements. The duties and responsibilities of the Architect with respect to
EM&A are:
Monitor the Contractors¡¦ compliance with
contract specifications, including the implementation and operation of the
environmental mitigation measures and their effectiveness
Monitor Contractors¡¦ and ET¡¦s compliance with
the requirements in the Environmental Permit (EP) and EM&A Manual
Facilitate ET¡¦s implementation of the EM&A
programme
Participate in joint site inspection by the ET
and IEC
Oversee the implementation of the agreed Event
/ Action Plan in the event of any exceedance
Adhere to the procedures for carrying out
complaint investigation
Liaison with DSD, Engineer/Engineer¡¦s
Representative, ET, IEC and the Contractor of the ¡§Construction of the DSD¡¦s
Regulation of Shenzhen River Stage 4 (RSR 4)¡¨ Project discussing regarding the
cumulative impact issues.
Engineer
or Engineers Representative (ER)
2.2.6
The ER is responsible for overseeing the
construction works and for ensuring that the works are undertaken by the
Contractor in accordance with the specification and contract requirements. The
duties and responsibilities of the ER with respect to EM&A are:
¡P
Monitor the Contractors¡¦ compliance with
contract specifications, including the implementation and operation of the
environmental mitigation measures and their effectiveness
¡P
Monitor Contractors¡¦s,
ET¡¦s and IEC¡¦s compliance with the requirements in the Environmental Permit
(EP) and EM&A Manual
¡P
Facilitate ET¡¦s implementation of the
EM&A programme
¡P
Participate in joint site inspection by the
ET and IEC
¡P
Oversee the implementation of the agreed
Event / Action Plan in the event of any exceedance
¡P
Adhere to the procedures for carrying out
complaint investigation
¡P
Liaison with DSD, Engineer/Engineer¡¦s
Representative, ET, IEC and the Contractor of the ¡§Construction of the DSD¡¦s Regulation
of Shenzhen River Stage 4 (RSR 4)¡¨ Project discussing regarding the cumulative
impact issues.
The
Contractor(s)
2.2.7
There will be one contractor for each
individual works contract. The
Contractor(s) should report to the ER. The duties and responsibilities of the
Contractor are:
¡P
Comply with the relevant contract conditions
and specifications on environmental protection
¡P
Employ an Environmental Team (ET) to
undertake monitoring, laboratory analysis and reporting of EM &A Facilitate
ET¡¦s monitoring and site inspection activities
¡P
Participate in the site inspections by the ET
and IEC, and undertake any corrective actions
¡P
Provide information / advice to the ET
regarding works programme and activities which may
contribute to the generation of adverse environmental impacts
¡P
Submit proposals on mitigation measures in
case of exceedances of Action and Limit levels in accordance with the Event /
Action Plans
¡P
Implement measures to reduce impact where
Action and Limit levels are exceeded
¡P
Adhere to the procedures for carrying out
complaint investigation
Environmental Team (ET)
2.2.8
One ET will be employed for this Project. The ET shall not be in any way an
associated body of the Contractor(s), and shall be employed by the Project
Proponent/Contractor to conduct the EM&A programme.
The ET should be managed by the ET
Leader. The ET Leader shall be a person who has at least 7 years¡¦ experience in
EM&A and has relevant professional qualifications. Suitably qualified staff
should be included in the ET, and resources for the implementation of the
EM&A programme should be allocated in time under
the Contract(s), to enable fulfillment of the Project¡¦s EM&A requirements
as specified in the EM&A Manual during construction of the Project. The ET shall report to the Project
Proponent and the duties shall include:
¡P
Monitor and audit various environmental
parameters as required in this EM&A Manual
¡P
Analyse the
environmental monitoring and audit data, review the success of EM&A programme and the adequacy of mitigation measures
implemented, confirm the validity of the EIA predictions and identify any adverse
environmental impacts arising
¡P
Carry out regular site inspection to
investigate and audit the Contractors¡¦ site practice, equipment/plant and work
methodologies with respect to pollution control and environmental mitigation,
and effect proactive action to pre-empt problems
¡P
Monitor compliance with conditions in the EP,
environmental protection, pollution prevention and control regulations and
contract specifications
¡P
Audit environmental conditions on site
¡P
Report on the environmental monitoring and audit
results to EPD, the ER, the lEC and Contractor(s) or their delegated representatives
¡P
Recommend suitable mitigation measures to the
Contractor in the case of exceedance of Action and Limit levels in accordance
with the Event and Action Plans
¡P
Liaise with the IEC on all environmental
performance matters and timely submit all relevant EM&A proforma
for approval by IEC
¡P
Advise the Contractor(s) on environmental
improvement, awareness, enhancement measures etc., on site
¡P
Adhere to the procedures for carrying out
complaint investigation
¡P
Liaison with the client departments,
Engineer/Engineer¡¦s Representative, ET, lEC and the
Contractor(s) of the concurrent projects as listed under Section 2.3 below
regarding the cumulative impact issues.
Independent Environmental Checker (IEC)
2.2.9
One IEC will be employed for this Project. The Independent Environmental Checker
(IEC) should not be in any way an associated body of the Contractor(s) or the
ET for the Project. The IEC should
be employed by the Permit Holder (i.e., CEDD) prior to
the commencement of the construction of the Project. The IEC should have at least 10 years¡¦
experience in EM&A and have relevant professional qualifications. The duty of IEC should be:
¡P
Provide proactive advice to the ER and the
Project Proponent on EM&A matters related to the project, independent from
the management of construction works, but empowered to audit the environmental
performance of construction
¡P
Review and audit all aspects of the EM&A programme implemented by the ET
¡P
Review and verify the monitoring data and all
submissions in connection with the EP and EM&A Manual submitted by the ET
¡P
Arrange and conduct regular, at least monthly
site inspections of the works during construction phase, and ad hoc inspections
if significant environmental problems are identified
¡P
Check compliance with the agreed Event /
Action Plan in the event of any exceedance
¡P
Check compliance with the procedures for
carrying out complaint investigation
¡P
Check the effectiveness of corrective
measures
¡P
Feedback audit results to ET by signing off
relevant EM&A proforma
¡P
Check that the mitigation measures are
effectively implemented
¡P
Report the works conducted, the findings,
recommendation and improvement of the site inspections, after reviewing ET¡¦s
and Contractor¡¦s works, and advices to the ER and Project Proponent on a
monthly basis
¡P
Liaison with the client departments,
Engineer/Engineer¡¦s Representative, ET, lEC and the
Contractor(s) of the concurrent projects as listed under Section 2.3 below
regarding the cumulative impact issues.
2.3.1
The concurrent construction works that may be
carried out include, but not limited to, the following:
(a)
Regulation of Shenzhen River Stage IV;
(b)
Widening of Fanling
Highway ¡V Tai Hang to Wo Hop Shek
Interchange ¡V Contract No. HY/2012/06;
(c)
Construction of BCP facilities in Shenzhen.
2.4.1
In the Reporting Period, the major
construction activity conducted under the Project is located in Contracts 2, 3,
4, 6, 7 and SS C505 and they are summarized in below.
Contract 2 (CV/2012/08)
2.4.2
Construction work of Contract 2 was commenced
on May 2014, the following activities were conducted
in the Reporting Period.
Mid-Vent Portal |
Building fit out and E&M installation
Construction of flexible barrier and permanent
drainage and external works
Landscaping works. |
North Portal |
Construction of retaining wall, permanent
drainage and slip road
Tunnel backfilling, VE panel and E&M installation
Construction of tunnel cross passage and internal
structure
Landscaping works
North ventilation building superstructure,
internal structure and backfilling
Construction of retaining wall, permanent
drainage and slip road
North Portal - Tunnel backfilling, VE panel and
E&M installation |
South Portal |
Construction of tunnel internal structure, tunnel
backfilling and E&M installation
South ventilation building fit out and E&M
installation
Construction of flexible barrier, permanent
drainage and slip road
Landscaping works.
Backfilling and construction of slip road
Tunnel Backfilling, VE panel and E&M
installation |
Admin Building |
Building fit out, permanent drainage and E&M
installation
Landscaping works |
Contract 3 (CV/2012/09)
2.4.3
Contract commenced in November 2013, the
following activities were conducted in the Reporting Period.
Cable detection
and trial trenches
Remaining works
on new Footbridge
Noise barrier
construction
Road pavement
works
Water main
laying works (on Grade and on bridge deck)
Installation of
Noise barrier steel column & panel, and sign gantry (on Grade and on bridge
deck)
Construction of
Pavilion and Pai Lau
Parapet
Installation on bridge deck
Road Drainage
Works
Construction of
profile barrier & Planter wall on Bridge deck
Bitumen paving
on bridge deck
Installation of
deck cell light inside the bridge deck
Installation of
movement joint on the bridge
Construction of
retaining wall
Landscaping
works
Contract 4 (NE/2014/02)
2.4.4
The Contract was awarded in mid-April 2016
and the construction work was commenced on 2 May 2017. In this Reporting
Period, construction activities conducted are listed below:
E&M
installation at Admin Building
E&M
installation at Ventilation Building
E&M
installation at OHVD & tunnel
High mast
erection
Cladding
installation at Cheung Shan Tunnel
Sign fabrication
& installation
E&M
installation at tunnel
Contract 5 (CV/2013/03)
1.1.1
The construction works
under Contract 5 was substantially completed on 31 August 2016.
Contract 6 (CV/2013/08)
2.4.5
Contract 6 has awarded in June 2015 and
construction work was commenced on 23 October 2015. In this Reporting Period,
construction activities conducted are listed below:
Bridge
construction
Tunneling Works
Sewage Treatment
Plant Construction
Tunnel Ventilation
Building Construction
Slip
Road/At-grade Road/Periphery Road Construction
Contract 7 (NE/2014/03)
2.4.6
Contract 7 has awarded in December 2015 and
construction work was commenced on 15 February 2015. In this Reporting Period, construction
activities conducted are listed below:
Abutment and
deck construction at Bridge E
Profile barrier
construction at Bridges A & E
Noise barrier
construction at Bridge D &E
Installation of
Façade at Bridge C
Waterproofing
works at roof of Bridge C
Drainage and watermains at perimeter road
Bitumen pavement
perimeter road
Parapet
installation at Bridge A, B, D & E
Contract SS C505
2.4.7
Contract SS C505 has awarded in July 2015 and
construction work was commenced on 1 September 2015. In this Reporting Period, construction
activities conducted are listed below:
Passenger
Terminal Building (PTB) G/F - Structure Works, Backfiling
& Drainage, Under Ground Utilities, Fence Wall and On Grade Slab
PTB - ABWF Works
& MEP Installation - Front/Back of House Area, Nonstructure
Wall Erection, Curtain Wall Installation, Southern Entrance Construction
PTB - Major
Plant Rooms ABWF Works & MEP Installation from G/F to 2/F & E&MF,
Lift & Escalator Installation by NSC (Sigma), MVAC Vertical Connection, Plumbling & Drainage Connection
PTB - External
Works incl. Building 21-24, M/F External Wall (Ewall),
Roof & Upper Roof Roofing Works, Podium Coach Canopy, 21&22 (C&PC
KIOSKS) & 23&24 (PC Examination Building & MSRVSS) Superstructure
& ABWF Works and MEP Installation
C&ED
Detector Dog Base - Integrated ABWF & MEP Works G/F & R/F Works
HKPF Building
and Observation Tower - External Works, Integrated ABWF & MEP Works
Fire Station and
Drill Tower - External Works, Integradted ABWF &
MEP Works
Cargo
Examination Building (Inbound) - External Works, Integrated ABWF & MEP
Works
Cargo
Examination Building (Outbound) - Steel Structure Works, External Works,
Integrated ABWF & MEP Works
Fixed X-ray
Vehicle Inspection System (FXRVIS) Buildings (Inbound) - Structures, External
Works, Integrated ABWF & MEP Works
Fixed X-ray
Vehicle Inspection System (FXRVIS) Buildings (Outbound) - Structures, External
Works and Integrated ABWF & MEP Works
MXRVSS (Inbound)
- Structure Works, Integrated ABWF and MEP Works
MXRVSS
(Outbound) - Structure Works, Integrated ABWF and MEP Works
GV Kiosk
(Inbound) - On-Grade Slab Construction, Steel Structure Works, Integrated ABWF
and MEP Works
GV Kiosk
(Outbound) - Structures Works, On-Grade Slab Construction, Steel Structure
Works, Integrated ABWF & MEP Works
Public Toilets
(Inbound) - Structure Works, Integrated ABWF and MEP Works
Public Toilets
(Outbound) - Structures Works, Integrated ABWF and MEP Works
Disinsection Facilities (Inbound) - Structure Works, Integrated
ABWF & MEP Works
Disinsection Facilities (Outbound) - Substructure and Structure
Works, Integrated ABWF & MEP Works
Weigh Station -
Integrated ABWF and MEP Works
EUVSS &
Monitoring Room - Structure Works, Integrated ABWF & MEP Works
Refuse
Collection Point - Integrated ABWF and MEP Works
Traffic Control
Office (Inbound) - Structure Works, Integrated ABWF and MEP Works
Traffic Control
Office (Outbound) - Structure Works, Integrated ABWF and MEP Works
Inspection Post
- Structure Works, Integrated ABWF and MEP Work
Guard Booth
(Inbound/Outbound/Vehicle Detention Area) - Structure Works, Integrated ABWF
and MEP Works
Steel Canopies -
Structure Works, Integrated ABWF and MEP Works
Fire Hydrant
Tank & Pump Room - Integrated ABWF and MEP Works
Irrigation Pump
Room - Integrated ABWF & MEP Works
Master Water
Meter Room 1,2,3 - Integrated ABWF and MEP Works
Elevated Walkway
(E1, E2, E3 & E4) - Structures Works, ABWF and BS Works
Vehicular
bridges 1-5 - Retaining walls, Road and Finishes Works
External Works -
CLP Cable & Power ON Transfer room
External Works -
Water Meter Room Connection
External Works -
Underground Utilities, Structures and Inspection (Inbound & Outbound Areas)
External Works -
Road Works (Inbound & Outbound Area, PTB Area)
Landscape -
Inbound Area, Outbound Area & PTB podium Area
Testing &
Commissioning (T&C) and FSD Inspection, CBI, DOG, Inbound EVA & SFH,
HKPF, FSD, CBI, EVA and SFH T&C
2.5.1
In according to the EP, the required
documents have submitted to EPD which listed in below:
Project Layout Plans of Contracts 2, 3, 4, 5,
6, 7 and SS C505
Landscape Plan
Topsoil Management Plan
Environmental Monitoring and Audit Programme
Baseline Monitoring Report
(TCS00690/13/600/R0030v3) for the Project
Waste Management Plan of the Contracts 2, 3, 4,
5, 6, 7 and SS C505
Contamination Assessment Plan (CAP) and
Contamination Assessment Report (CAR) for Po Kat Tsai, Loi
Tung and the workshops in Fanling
Vegetation Survey Report
Woodland Compensation Plan
Habitat Creation Management Plan
Wetland Compensation Plan
2.5.2
Summary of
the relevant permits, licenses, and/or notifications on environmental
protection for the Project of each contracts are presented in Table 2-1.
Table
2-1 Status
of Environmental Licenses and Permits of the Contracts
Item |
Description |
License/Permit
Status |
||||||
Ref.
no. |
Effective Date |
Expiry Date |
||||||
Contract 2 |
||||||||
1 |
Air
pollution Control (Construction Dust) Regulation |
Ref No.: 368864 |
31 Dec 2013 |
Till Contract ends |
||||
2 |
Chemical
Waste Producer Registration |
North Portal Waste Producers Number: No.5213-652-D2523-01 |
25 Mar 2014 |
Till Contract ends |
||||
Mid-Vent Portal Waste Producers Number: No.5213-634-D2524-01 |
25 Mar 2014 |
Till Contract ends |
||||||
South Portal Waste Producers Number: No.5213-634-D2526-01 |
9 Apr 2014 |
Till Contract ends |
||||||
3 |
Water
Pollution Control Ordinance - Discharge
License |
No.WT00018374-2014 (South Portal ) |
3 Mar 2014 |
28 Feb 2019 |
||||
No. WT00023063-2015 (North Portal) |
18 Dec 2015 |
31 Mar
2019 |
||||||
No.: W5/1I392 (Admin Building) |
28 Mar 2014 |
31 Mar 2019 |
||||||
No.:
WT00025594-2016 (Mid-Vent Portal) |
7 Oct 2016 |
31 Mar 2019 |
||||||
4 |
Waste
Disposal Regulation - Billing Account for Disposal of Construction Waste |
Account No. 7019105 |
8 Jan 2014 |
Till Contract ends |
||||
5 |
Construction
Noise Permit |
GW-RN0211-18 |
North Portal |
10-May-2018 |
09-Nov-2018 |
|||
GW-RN0212-18 |
10-May-2018 |
09-Nov-2018 |
||||||
GW-RN0307-18 |
18-Jun-2018 |
17-Dec-2018 |
||||||
GW-RN0400-18 |
Mid Vent |
06-Aug-2018 |
01-Feb-2019 |
|||||
GW-RN0401-18 |
06-Aug-2018 |
31-Jan-2019 |
||||||
GW-RN0238-18 |
South Portal |
01-Jun-2018 |
30-Nov-2018 |
|||||
GW-RN0110-18 |
22-Mar-2018 |
21-Sep-2018 |
||||||
GW-RN0176-18 |
30-Apr-2018 |
27-Oct-2018 |
||||||
GW-RN0253-18 |
06-Jun-2018 |
05-Dec-2018 |
||||||
GW-RN0511-18 |
30-Sep-2018 |
25-Mar-2019 |
||||||
GW-RN0513-18 |
30-Sep-2018 |
25-Mar-2019 |
||||||
GW-RN0176-18 |
30-Apr-2018 |
27-Oct-2018 |
||||||
GW-RN0142-18 |
Admin Bldg |
5-Apr-2018 |
27-Sep-2018 |
|||||
GW-RN0523-18 |
28-Sep-2018 |
27-Mar-2019 |
||||||
GW-RN0140-18 |
Cheung Shan Tunnel |
3-Apr-2018 |
22-Sep-2018 |
|||||
GW-RN0522-18 |
26-Sep-2018 |
22-Mar-2019 |
||||||
6 |
Specified
Process License (Mortar Plant
Operation) |
L-3-251(1) |
12-Apr-2016 |
11-Apr-2021 |
||||
Contract 3 |
||||||||
1 |
Air
pollution Control (Construction Dust) Regulation |
Ref. No: 362101 |
17 Jul 2013 |
Till Contract ends |
||||
2 |
Chemical
Waste Producer Registration |
Waste Producers Number: No.:5113-634-C3817-01 |
7 Oct 2013 |
Till Contract ends |
||||
3 |
Water
Pollution Control Ordinance - Discharge
License |
No.:WT00016832 ¡V 2013 |
28 Aug 13 |
31 Aug 2018 |
||||
No.:WT00032188 ¡V 2018 |
20 Sep 2018 |
31 Aug 2023 |
||||||
4 |
Waste
Disposal Regulation - Billing Account for Disposal of Construction Waste |
Account No. 7017914 |
2 Aug 13 |
Till Contract ends |
||||
5 |
Construction Noise Permit |
GW-RN0259-18 |
19 Jun 2018 |
17 Dec 2018 |
||||
GW-RN0305-18 |
22 Jun 2018 |
17 Dec 2018 |
||||||
GW-RN0366-18 |
9 Jul 2018 |
18 Dec 2018 |
||||||
GW-RN0361-18 |
15 Jul 2018 |
18 Dec 2018 |
||||||
GW-RN0388-18 |
25 Aug 2018 |
24 Feb 2019 |
||||||
GW-RN0424-18 |
01 Sep 2018 |
21 Feb 2019 |
||||||
GW-RN0425-18 |
22 Aug 2018 |
21 Feb 2019 |
||||||
GW-RN0454-18 |
06 Sep 2018 |
05 Mar 2019 |
||||||
GW-RN0509-18 |
10 Oct
2018 |
17 Dec 2018 |
||||||
GW-RN0566-18 |
29 Oct
2018 |
04 Apr 2019 |
||||||
Contract
5 |
||||||||
1 |
Air
pollution Control (Construction Dust) Regulation |
Ref. No: 359338 |
13 May 2013 |
Till the end of Contract |
||||
2 |
Chemical
Waste Producer Registration |
Waste Producers Number No.: 5213-642-S3735-01 |
8 Jun 2013 |
Till the end of Contract |
||||
3 |
Water
Pollution Control Ordinance - Discharge
License |
No.: W5/1G44/1 |
8 Jun 13 |
30 Jun 2018 |
||||
4 |
Waste
Disposal Regulation - Billing Account for Disposal of Construction Waste |
Account No. 7017351 |
29 Apr 13 |
Till the end of Contract |
||||
Contract 6 |
||||||||
1 |
Air
pollution Control (Construction Dust) Regulation |
Ref. No: 390614 |
29 Jun 2015 |
Till the end of Contract |
||||
2 |
Chemical
Waste Producer Registration |
Waste Producers Number No.: 5213-652-C3969-01 |
31 Aug 2015 |
Till the end of Contract |
||||
3 |
Waste
Disposal Regulation - Billing Account for Disposal of Construction Waste |
Account No. 7022707 |
9 Jul 2015 |
Till the end of Contract |
||||
4 |
Water
Pollution Control Ordinance - Discharge
License |
No.:WT00024574-2016 |
31 May 2016 |
31 May 2021 |
||||
No.:WT00024576-2016 |
31 May 2016 |
31 May 2021 |
||||||
No.:WT00024742-2016 |
14 June 2016 |
30 June 2021 |
||||||
No.:WT00024746-2016 |
14 June 2016 |
30 June 2021 |
||||||
5 |
Construction Noise Permit |
GW-RW0121-18 |
30 Apr 2018 |
29 Oct 2018 |
||||
GW-RW0481-18 |
14 Sep 2018 |
13 Mar 2019 |
||||||
GW-RW0595-18 |
30 Oct 2018 |
28 Feb 2019 |
||||||
Contract SS C505 |
||||||||
1 |
Air
pollution Control (Construction Dust) Regulation |
Ref. No: 390974 |
13 Jul 2015 |
Till the end of Contract |
||||
2 |
Chemical
Waste Producer Registration |
Waste Producer No.: 5213-642-L1048-07 |
16 Sep 2015 |
Till the end of Contract |
||||
3 |
Water
Pollution Control Ordinance - Discharge
License |
No.: WT00024865-2016 |
8 Jul 2016 |
30 Nov 2020 |
||||
4 |
Waste
Disposal Regulation - Billing Account for Disposal of Construction Waste |
Account No. 7022831 |
23 Jul 2015 |
Till the end of Contract |
||||
5 |
Construction Noise Permit |
GW-RN0114-18 |
5 Apr 2018 |
4 Oct 2018 |
||||
GW-RN0198-18 |
8 May 2018 |
7 Nov 2018 |
||||||
GW-RN0529-18 |
5 Oct 2018 |
3 Apr 2019 |
||||||
Contract
7 |
||||||||
1 |
Air
pollution Control (Construction Dust) Regulation |
Ref. No: 397015 |
21 Dec 2015 |
Till the end of Contract |
||||
2 |
Chemical
Waste Producer Registration |
Waste Producer No.: 5214-641-K3202-01 |
24 Mar 2016 |
Till the end of Contract |
||||
3 |
Water
Pollution Control Ordinance - Discharge
License |
No.: WT00024422-2016 |
10 May 2016 |
31 May 2021 |
||||
4 |
Waste
Disposal Regulation - Billing Account for Disposal of Construction Waste |
Account No. 7024129 |
21 Jan 2016 |
Till the end of Contract |
||||
5 |
Construction Noise Permit |
GW-RN0206-18 |
8 May 2018 |
4 Nov 2018 |
||||
Contract 4 |
||||||||
1 |
Air
pollution Control (Construction Dust) Regulation |
Ref. No. 405353 |
22 July 2016 |
Till the end of Contract |
||||
2 |
Waste
Disposal Regulation - Billing Account for Disposal of Construction Waste |
Account No. 7024973 |
13 May 2016 |
Till the end of Contract |
||||
3 |
Construction Noise Permit |
GW-RN0568-18 |
15 Oct 2018 |
14 Dec 2018 |
||||
3.1.1
The Environmental Monitoring and Audit
requirements are set out in the Approved EM&A manual. Environmental issues
such as air quality, construction noise and water quality were identified as
the key issues during the construction phase of the Project.
3.1.2
A summary of construction phase EM&A
requirements are presented in the
sub-sections below.
3.2.1
The EM&A program of construction phase
monitoring shall cover the following environmental issues:
•
Air quality;
•
Construction noise; and
•
Water quality
3.2.2
A summary of the monitoring parameters is
presented in Table 3-1.
Table 3-1 Summary
of EM&A Requirements
Environmental
Issue |
Parameters |
Air
Quality |
1-hour
TSP by Real-Time Portable Dust Meter; and 24-hour
TSP by High Volume Air Sampler. |
Noise |
Leq(30min) in normal working days (Monday to
Saturday) 07:00-19:00 except public holiday; and 3 sets
of consecutive Leq(5min) on
restricted hours i.e. 19:00 to 07:00 next day, and whole day of public
holiday or Sunday Supplementary
information for data auditing, statistical results such as L10 and
L90 shall also be obtained for reference. |
Water
Quality |
In-situ
Measurements Dissolved
Oxygen Concentration (mg/L); Dissolved
Oxygen Saturation (% ); Turbidity
(NTU); pH unit; Water
depth (m); and Temperature
(¢J). |
Laboratory Analysis Suspended
Solids (mg/L) |
3.3.1
The designated monitoring locations as
recommended in the EM&A Manual
are shown in Appendix C.
As the access to some of the designated monitoring locations was
questionable due to safety reason or denied by the landlords, alternative
locations therefore have had proposed. The latest alternative monitoring locations has been updated in the revised EM&A Programme (Rev.7) which
approved by EPD
on 7 April 2017. Besides, in view
of Location AM1b was demolished and returned to the landlord on 27 April 2018, alterative location AM1c was proposed by
ET. The proposal for alterative location AM1c which verified
by IEC on 5 June 2018 submitted to EPD for approval on 6 June 2018. EPD issued
comments on 16 July 2018 and the revised proposal was submitted to EPD on 20
August 2018. Further comment was given from EPD on 13 September 2018 and the
revised proposal was submitted to EPD on 31 October 2018. Table
3-2, Table 3-3 and Table 3-4 are respectively listed
the air quality, construction noise and water quality monitoring locations for
the Project and a map showing these monitoring stations is presented in Appendix D.
Table
3-2 Impact
Monitoring Stations - Air Quality
Station ID |
Description |
Works Area |
Related to the Work Contract |
AM1b^ |
Open area at Tsung
Yuen Ha Village |
BCP |
SS C505 Contract 7 |
AM1c(*) |
Open area of Tsung Yuen
Ha Village No. 63 |
BCP |
SS C505 Contract 7 |
AM2 |
Village House near Lin Ma Hang
Road |
LMH to Frontier Closed Area |
Contract 6 |
AM3 |
Ta Kwu
Ling Fire Service Station of Ta Kwu Ling Village. |
LMH to Frontier Closed Area |
Contract 6 |
AM4b^ |
House no. 10B1 Nga Yiu Ha
Village |
LMH to Frontier Closed Area |
Contract 6 |
AM5a^ |
Ping Yeung Village House |
Ping Yeung to Wo Keng Shan |
Contract 6 |
AM6 |
Wo Keng
Shan Village House |
Ping Yeung to Wo Keng Shan |
Contract 6 |
AM7b@ |
Loi Tung Village House |
Sha Tau Kok
Road |
Contract 2 Contract 6 |
AM8 |
Po Kat Tsai Village No. 4 |
Po Kat Tsai |
Contract 2 |
AM9b# |
Nam Wa
Po Village House No. 80 |
Fanling |
Contract 3 |
# Proposal for the change of air quality
monitoring location from AM9a to AM9b was submitted to EPD on 4 Nov 2013 after
verified by the IEC and it was approved by EPD (EPD¡¦s ref.: (15) in EP
2/N7/A/52 Pt.10 dated 8 Nov 2013).
@ Proposal for the change of air quality
monitoring location from AM7a to AM7b was submitted to EPD on 4 June 2014 after
verified by the IEC. It was approved by EPD (EPD¡¦s ref.: (7) in EP 2/N7/A/52
Pt.12 dated 9 Jun 2014).
^ Proposal for change of air quality monitoring
locations was enclosed in the updated EM&A Programme
which approval by EPD on 29 Mar 2016. Besides, Location AM1b was temporary
suspended (24-hour TSP monitoring) since 27 April 2018 as the rented land was
demolished and returned to the landlord.
* Proposal for alterative location AM1c which
verified by the IEC on 5 June 2018 was submitted to EPD on 6 June 2018. EPD issued comments on 16 July 2018 and
the revised proposal was submitted to EPD on 20 August 2018. Further comment
was given from EPD on 13 September 2018 and the revised proposal was submitted
to EPD on 31 October 2018.
Table
3-3 Impact
Monitoring Stations - Construction Noise
Station ID |
Description |
Works Area |
Related to the Work Contract |
NM1 |
Tsung Yuen Ha Village House
No. 63 |
BCP |
SS C505 Contract 7 |
NM2a# |
Village House near Lin Ma Hang Road |
Lin Ma Hang to Frontier Closed Area |
Contract 6 |
NM3 |
Ping Yeung Village House (facade facing northeast) |
Ping Yeung to Wo Keng Shan |
Contract 6 |
NM4 |
Wo Keng Shan Village House |
Ping Yeung to Wo Keng Shan |
Contract 6 |
NM5 |
Village House, Loi Tung |
Sha Tau Kok Road |
Contract 2, Contract 6 |
NM6 |
Tai Tong Wu Village House 2 |
Sha Tau Kok Road |
Contract 2, Contract 6 |
NM7 |
Po Kat Tsai Village |
Po Kat Tsai |
Contract 2 |
NM8 |
Village House, Tong Hang |
Fanling |
Contract 2 Contract 3 |
NM9 |
Village House, Kiu Tau
Village |
Fanling |
Contract 3 |
NM10 |
Nam Wa Po Village House No.
80 |
Fanling |
Contract 3 |
# Proposal for the change of construction
noise monitoring location from NM2 to NM2a was verified by the IEC on 6 May
2016 and was effective on 9 May 2016.
Table
3-4 Impact
Monitoring Stations - Water Quality
Station ID |
Description |
Coordinates of Designated / Alternative Location |
Nature of the location |
Related to the Work Contract |
|
WM1 |
Downstream of Kong Yiu Channel |
833 679 |
845 421 |
Alternative location
located at upstream 51m of the designated location |
SS C505 Contract 6 |
WM1- Control |
Upstream of Kong Yiu Channel |
834 185 |
845 917 |
NA |
SS C505 Contract 6 |
WM2A |
Downstream of River
Ganges |
834 204 |
844 471 |
Alternative location located
at downstream 81m of the designated location |
Contract 6 |
WM2A(a)* |
Downstream of River
Ganges |
834 191 |
844 474 |
Alternative location
located at upstream 70m of the designated location |
Contract 6 |
WM2A- Controlx# |
Upstream of River
Ganges |
835 377 |
844 188 |
Alternative location
located at upstream 160m of the designated location |
Contract 6 |
WM2B |
Downstream of River
Ganges |
835 433 |
843 397 |
NA |
Contract 6 |
WM2B- Control |
Upstream of River
Ganges |
835 835 |
843 351 |
Alternative location
located at downstream 31m of the designated location |
Contract 6 |
WM3x# |
Downstream of River
Indus |
836 206 |
842 270 |
Alternative location
located at downstream 180m of the designated location |
Contract 2 Contract 6 |
WM3- Control |
Upstream of River
Indus |
836 763 |
842 400 |
Alternative location
located at downstream 26m of the designated location |
Contract 2# Contract 6 |
WM4 |
Downstream of Ma Wat
Channel |
833 850 |
838 338 |
Alternative location
located at upstream 11m of the designated location |
Contract 2 Contract 3 |
WM4¡V Control A |
Kau Lung Hang Stream |
834 028 |
837 695 |
Alternative location
located at downstream 28m of the designated location |
Contract 2 Contract 3 |
WM4¡V Control B |
Upstream of Ma Wat
Channel |
833760 |
837395 |
Alternative location
located at upstream 15m of the designated location |
Contract 2 Contract 3 |
Note: EPD has approved the revised EM&A Programme
(Rev.7) which proposed that (1) if the measured water depth of the monitoring
station is lower than 150 mm, alternative location based on the criteria were
selected to perform water monitoring; and (2) If no suitable alternative
location could be found within 15m far from the original location, the sampling
at that location will be cancelled since sampling at too far from the designated
location could not make a representative sample in accordance with the updated
EM&A Programme (Rev. 07) (Section 4.1.4) (EPD
ref.: ( ) in EP2/N7/A/52 Ax(1) Pt.20 dated 7 April 2017)
(*) Proposal
for the change of water monitoring location from WM2A to WM2A(a)
was verified by the IEC and it was approved by EPD. (EPD¡¦s ref. (10) in EP
2/N7/A/52 Pt.19)
(#) Proposal
for the change of water quality
monitoring location (EM3x and WM2A-Cx was
included in the EM&A Programme Rev .05 which
approved by EPD on 29 March 2016 (EPD ref.: (3) in EP2/N7/A/52 Ax(1) Pt.19)
3.4.1
The requirements of
impact monitoring are stipulated in Sections
2.1.6, 3.1.5 and 4.1.6 of the
approved EM&A Manual and
presented as follows.
Air Quality Monitoring
3.4.2
Frequency of impact
air quality monitoring is as follows:
1-hour TSP |
3 times every six
days during course of works |
24-hour TSP |
Once every 6 days during course of works. |
Noise Monitoring
3.4.3
One set of Leq(30min)
as 6 consecutive Leq(5min)
between 0700-1900 hours on normal weekdays and once every week during course of works. If construction work necessary to carry
out at other time periods, i.e. restricted time period (19:00 to 07:00 the next
morning and whole day on public holidays) (hereinafter referred as ¡§the restricted
hours¡¨), 3 consecutive Leq(5min)
measurement will depended CNP requirements to undertake. Supplementary
information for data auditing, statistical results such as L10 and L90
shall also be obtained for
reference.
Water Quality Monitoring
3.4.4
The water quality monitoring frequency shall
be 3 days per week during course of works.
The interval between two sets of monitoring shall not be less than 36
hours.
Air Quality Monitoring
3.5.1
The 24-hour and 1-hour TSP levels shall be
measured by following the standard high volume sampling method as set out in
the Title 40 of the Code of Federal Regulations, Chapter 1 (Part 50), Appendix B. If the ET proposes to use a direct
reading dust meter to measure 1-hour TSP levels, it shall submit sufficient
information to the IEC to approve.
3.5.2
The filter paper of 24-hour TSP measurement shall be determined by HOKLAS
accredited laboratory.
3.5.3
All equipment to be used for air quality
monitoring is listed in Table 3-5.
Table 3-5 Air
Quality Monitoring Equipment
Equipment |
Model |
24-Hour
TSP |
|
High
Volume Air Sampler |
TISCH
High Volume Air Sampler, HVS Model TE-5170 |
Calibration
Kit |
TISCH
Model TE-5025A |
1-Hour TSP |
|
Portable Dust Meter |
Sibata LD-3B Laser Dust monitor Particle Mass
Profiler & Counter |
Wind Data
Monitoring Equipment
3.5.4
According to the approved EM&A Manual,
wind data monitoring equipment shall also be provided and set up for logging
wind speed and wind direction near the dust monitoring locations. The equipment installation location
shall be proposed by the ET and agreed with the IEC. For installation and operation of wind
data monitoring equipment, the following points shall be observed:
1)
The wind sensors should be installed 10 m
above ground so that they are clear of obstructions or turbulence caused by
buildings.
2)
The wind data should be captured by a data
logger. The data shall be downloaded for analysis at least once a month.
3)
The wind data monitoring equipment should be
re-calibrated at least once every six months.
4)
Wind direction should be divided into 16
sectors of 22.5 degrees each.
3.5.5
ET has liaised with the landlords of the
successful granted HVS installation premises. However, the owners rejected to provide
premises for wind data monitoring equipment installation.
3.5.6
Under this situation, the ET proposed
alternative methods to obtain representative wind data. Meteorological information as extracted
from ¡§the Hong Kong Observatory Ta Kwu Ling Station¡¨
is alternative method to obtain representative wind data. For Ta Kwu
Ling Station, it is located nearby the Project site. Moreover, this station is located at 15m
above mean sea level while its anemometer is located at 13m above the existing
ground which in compliance with the general setting up requirement. Furthermore, this station also can be to
provide the humidity, rainfall, and air pressure and temperature etc.
meteorological information. In Hong
Kong of a lot development projects, weather information extracted from Hong
Kong Observatory is common alternative method if weather station installation
not allowed.
Noise Monitoring
3.5.7
Sound level meter in compliance with the
International Electrotechnical Commission
Publications 651: 1979 (Type 1) and 804: 1985 (Type 1) specifications shall be
used for carrying out the noise monitoring. The sound level meter shall be checked
using an acoustic calibrator. The wind speed shall be checked with a portable
wind speed meter capable of measuring the wind speed in m s-1.
3.5.8
Noise monitoring equipment to be used for
monitoring is listed in Table 3-6.
Table 3-6 Construction
Noise Monitoring Equipment
Equipment |
Model |
Integrating Sound Level Meter |
B&K
Type 2238 and Rion NL-31/ Rion
NL-52 |
Calibrator |
Rion NC-74 and B&K Type 4231 |
Portable Wind Speed Indicator |
Testo Anemometer |
3.5.9
Sound level meters listed above comply with
the International Electrotechnical
Commission Publications 651: 1979 (Type 1) and 804: 1985 (Type 1) specifications, as recommended in TM issued
under the NCO. The acoustic
calibrator and sound level meter to be used in the impact monitoring will be
calibrated yearly.
Water Quality Monitoring
3.5.10 DO and water temperature should be measured in-situ by a DO/temperature
meter. The instrument should be portable and weatherproof using a DC power source.
It should have a membrane electrode
with automatic temperature compensation complete with a cable. The equipment
should be capable of measuring:
•
DO level in the range of 0-20 mg/l and 0-200%
saturation; and
•
temperature of between 0 and 45 degree Celsius.
3.5.11 A portable pH meter capable of measuring a range between 0.0 and 14.0
should be provided to measure pH under the specified conditions accordingly to
the APHA Standard Methods.
3.5.12 The instrument should be portable and weatherproof using a DC power
source. It should have a photoelectric sensor capable of measuring turbidity
between 0-1000 NTU.
3.5.13 A
portable, battery-operated echo sounder or tape measure will be used for the
determination of water depth at each designated monitoring station as
appropriate.
3.5.14 A water
sampler e.g. Kahlsico Water Sampler, which is a
transparent PVC cylinder with capacity not less than 2 litres,
will be used for water sampling if water depth over than 0.5m. For sampling from very shallow
water depths e.g. <0.5 m, water sample collection will be directly from
water surface below 100mm use sampling plastic bottle to avoid inclusion of
bottom sediment or humus. Moreover,
Teflon/stainless steel bailer or self-made sampling buckets maybe used for
water sampling. The equipment used
for sampling will be depended the sampling location and depth situations.
3.5.15 Water samples
for laboratory measurement of SS will be collected in high density polythene
bottles, packed in ice (cooled to 4 ºC without being frozen), and delivered to
the laboratory in the same day as the samples were collected.
3.5.16 Analysis
of suspended solids should be carried out in a HOKLAS or other accredited
laboratory. Water samples of about 1L should be collected at the monitoring
stations for carrying out the laboratory suspended solids determination. The SS determination work should start
within 24 hours after collection of the water samples. The SS analyses should
follow the APHA Standard Methods 2540D
with Limit of Reporting of 2 mg/L.
3.5.17 Water
quality monitoring equipment used in the impact monitoring is listed in Table
3-7. Suspended solids (SS) analysis is
carried out by a local HOKLAS-accredited laboratory, namely ALS Technichem
(HK) Pty Ltd.
Table 3-7 Water
Quality Monitoring Equipment
Equipment |
Model |
Water Depth Detector |
Eagle Sonar or tape measures |
Water
Sampler |
A
2-litre transparent PVC cylinder with latex cups at both ends or teflon/stainless steel bailer or self-made sampling
bucket |
Thermometer
& DO meter |
YSI
Professional Plus / YSI 550A Multifunctional Meter |
pH meter |
YSI
Professional Plus / AZ8685 pH pen-style meter |
Turbidimeter |
Hach 2100Q |
Sample
Container |
High
density polythene bottles (provided by laboratory) |
Storage Container |
¡¥Willow¡¦ 33-liter plastic cool box with Ice
pad |
1-hour TSP Monitoring
3.6.1
The 1-hour TSP monitor was a brand named ¡§Sibata LD-3B Laser Dust monitor Particle Mass Profiler
& Counter¡¨ which is a portable, battery-operated laser photometer. The 1-hour TSP meter provides a real
time 1-hour TSP measurement based on 90o light scattering. The 1-hour TSP monitor consists of the
following:
(a.)
A pump to draw sample aerosol through the
optic chamber where TSP is measured;
(b.)
A sheath air system to isolate the aerosol in
the chamber to keep the optics clean for maximum reliability; and
(c.)
A built-in data logger compatible with
Windows based program to facilitate data collection, analysis and reporting.
3.6.2
The 1-hour TSP meter is used within the valid
period as follow manufacturer¡¦s Operation and Service Manual.
3.6.3
The equipment used for 24-hour TSP measurement
is Tisch
Environmental, Inc. Model TE-5170 TSP high volume air sampling system, which complied with EPA Code of Federal Regulation, Appendix B
to Part 50. The High Volume Air Sampler (HVS) consists of the following:
(a.)
An anodized aluminum shelter;
(b.)
A 8¡¨x10¡¨ stainless steel filter holder;
(c.)
A blower motor assembly;
(d.)
A continuous flow/pressure recorder;
(e.)
A motor speed-voltage control/elapsed time
indicator;
(f.)
A 7-day mechanical timer, and
(g.)
A power supply of 220v/50 Hz
3.6.4
The HVS is operated and calibrated on a regular
basis in accordance with the manufacturer¡¦s instruction using Tisch Calibration Kit Model TE-5025A. Calibration would carry out in two month
interval.
3.6.5
24-hour TSP is collected by the ET on filters
of HVS and quantified by a local HOKLAS accredited laboratory, ALS Technichem (HK) Pty Ltd (ALS), upon receipt of the
samples. The ET keep all the
sampled 24-hour TSP filters in normal air conditioned room conditions, i.e. 70%
RH (Relative Humidity) and 25oC, for six months prior to disposal.
3.6.6
Noise measurements were taken in terms of the
A-weighted equivalent sound pressure level (Leq)
measured in decibels dB(A). Supplementary statistical
results (L10 and L90) were also obtained for reference.
3.6.7
During
the monitoring, all noise measurements were performed with the meter set to
FAST response and on the A-weighted equivalent continuous sound pressure level
(Leq). Leq(30min)
in six consecutive Leq(5min) measurements
were used as the monitoring parameter for the time period between 0700-1900
hours on weekdays; and also Leq(15min) in
three consecutive Leq(5min) measurements
is used as monitoring parameter for other time periods (e.g. during restricted
hours), if necessary.
3.6.8
Prior
of noise measurement, the accuracy of the sound level meter is checked using an
acoustic calibrator generating a known sound pressure level at a known
frequency. The checking was
performed before and after the noise measurement.
Water Quality
3.6.9
Water
quality monitoring is conducted at the designated locations. The sampling
produce with the in-situ monitoring are presented as below:
Sampling Procedure
3.6.10 A Digital Global Positioning System (GPS) is used to identify the
designated monitoring stations prior to water sampling. A portable, battery-operated echo sounder
is used for the determination of water depth at each station. At each station, water sample would be
collected from 0.1m below water surface or the water surface to prevent the
river bed sediment for stirring.
3.6.11 The sample
container will be rinsed with a portion of the water sample. The water sample then will be
transferred to the high-density polythene
bottles as provided by the laboratory, labeled with a unique sample
number and sealed with a screw cap.
3.6.12 Before
sampling, general information such as the date and time of sampling, weather
condition as well as the personnel responsible for the monitoring would be
recorded on the field data sheet.
3.6.13 A ¡¥Willow¡¦
33-liter plastic cool box packed with ice will be used to preserve the water
samples prior to arrival at the laboratory for chemical determination. The water temperature of the cool box is
maintained at a temperature as close to 40C as possible without
being frozen. Samples collected are
delivered to the laboratory upon collection.
In-situ Measurement
3.6.14 Instrument
including YSI Professional Plus or YSI 550A Multifunctional Meter is used for water in-situ measures,
which automates the measurements and data logging of temperature, dissolved
oxygen and dissolved oxygen saturation.
Before each round of monitoring, the
dissolved oxygen probe would be calibrated by the wet bulb method.
3.6.15 A portable AZ8685
pH pen-style meter or YSI Professional Plus is used for in-situ
pH measurement. The pH meter is
capable of measuring pH in the range of 0 ¡V 14 and readable to 0.1.
3.6.16 A portable Hach 2100Q Turbidimeter is used for in-situ
turbidity measurement. The turbidity meter is capable of measuring turbidity in
the range of 0 ¡V 1000 NTU. StablCal®
Standards of known NTU are used for calibration of the
instrument before and after measurement.
3.6.17 All
in-situ measurement equipment are calibrated by HOKLAS
accredited laboratory of three month interval.
Laboratory Analysis
3.6.18 All water samples are analyzed
with Suspended Solids (SS) as specified in the
EM&A Manual by a local HOKLAS-accredited testing laboratory (ALS Technichem (HK) Pty Ltd HOKLAS registration no. 66).
SS analysis is
determined by the laboratory upon receipt of the water samples using APHA Standard Methods 2540D (namely ALS Method EA-025 as
accredited HOKLAS Scheme) started within 48
hours of water sample receipt.
3.7.1
Calibration of the HVS is performed upon
installation and thereafter at bimonthly intervals in accordance with the
manufacturer¡¦s instruction using the certified standard calibrator (TISCH Model
TE-5025A).
Moreover, the Calibration Kit would be
calibrated annually. The calibration data are properly documented and the
records are maintained by ET for future reference.
3.7.2
The 1-hour TSP
meter was calibrated by the supplier prior to purchase. Zero response of the equipment would be
checked before and after each monitoring event. Annually calibration with the High
Volume Sampler (HVS) in same condition would be undertaken by the Laboratory.
3.7.3
The sound level
meter and calibrator are calibrated and certified by a laboratory accredited
under HOKLAS or any other international accreditation scheme at yearly basis.
3.7.4
All water quality monitoring equipment is
calibrated by HOKLAS accredited laboratory of three month intervals.
3.7.5
The calibration certificates of all
monitoring equipment used for the impact monitoring program in the Reporting
Period and the HOKLAS accredited certificate of laboratory are presented in
the relevant monthly EM&A reports.
3.8.1
The baseline results form the basis for
determining the environmental acceptance criteria for the impact
monitoring. According to the
approved Environmental Monitoring and Audit Manual, the air quality,
construction noise and water quality criteria were set up, namely Action and
Limit levels are listed in Tables 3-8, 3-9 and 3-10.
Table 3-8 Action and Limit Levels for Air Quality
Monitoring
Monitoring Station |
Action Level (mg /m3) |
Limit Level (mg/m3) |
||
1-hour TSP |
24-hour TSP |
1-hour TSP |
24-hour TSP |
|
AM1b |
265 |
143 |
500 |
260 |
AM2 |
268 |
149 |
||
AM3 |
269 |
145 |
||
AM4b |
267 |
148 |
||
AM5a |
268 |
143 |
||
AM6 |
269 |
148 |
||
AM7b |
275 |
156 |
||
AM8 |
269 |
144 |
||
AM9b |
271 |
151 |
Table 3-9 Action
and Limit Levels for Construction Noise
Monitoring Location |
Action Level |
Limit Level in dB(A) |
Time Period: 0700-1900 hours on normal
weekdays |
||
NM1, NM2a, NM3, NM4, NM5, NM6, NM7, NM8,
NM9, NM10 |
When one or more documented complaints are
received |
75 dB(A)Note 1 & Note 2 |
Note 1: Acceptable Noise Levels for school should be reduced to 70 dB(A) and 65 dB(A) during examination period
Note 2: If works are to be carried out during restricted hours, the conditions
stipulated in the construction noise permit issued by the NCA have to be followed.
Table 3-10 Action
and Limit Levels for Water Quality
Parameter |
Performance criteria |
Monitoring Location |
|||||
WM1 |
WM2A(a) |
WM2B |
WM3x |
WM4 |
|||
DO
(mg/L) |
Action Level |
(*)4.23 |
(**)4.00 |
(*)4.74 |
(**)4.00 |
(*)4.14 |
|
Limit Level |
(#)4.19 |
(**)4.00 |
(#)4.60 |
(**)4.00 |
(#)4.08 |
||
Turbidity
(NTU) |
Action Level |
51.3 |
24.9 |
11.4 |
13.4 |
35.2 |
|
AND 120% of upstream control station of
the same day |
|||||||
Limit Level |
67.6 |
33.8 |
12.3 |
14.0 |
38.4 |
||
AND
130% of upstream control
station of the same day |
|||||||
SS
(mg/L) |
Action Level |
54.5 |
14.6 |
11.8 |
12.6 |
39.4 |
|
AND 120% of upstream control station of the
same day |
|||||||
Limit Level |
64.9 |
17.3 |
12.4 |
12.9 |
45.5 |
||
AND
130% of upstream control
station of the same day |
|||||||
Remarks: (*) The
Proposed Action Level of Dissolved Oxygen is adopted to be
used 5%-ile of baseline data (**) The Proposed Action & Limit Level of Dissolved Oxygen is used 4mg/L (#) The Proposed Limit Level of Dissolved Oxygen is adopted to be
used 1%-ile of baseline data |
|||||||
3.8.2
Should non-compliance of the environmental
quality criteria occurs, remedial actions will be triggered according to the
Event and Action Plan which presented in Appendix E.
3.9.1
All monitoring data will be handled by the ET¡¦s in-house data recording and management
system. The monitoring data recorded in the equipment
will be downloaded directly from the equipment at the end of each monitoring
day. The downloaded monitoring data
will input into a computerized database properly maintained by the ET. The laboratory results will be input
directly into the computerized database and checked by personnel other than
those who input the data.
3.9.2
For monitoring parameters that require
laboratory analysis, the local laboratory shall follow the QA/QC requirements
as set out under the HOKLAS scheme for the relevant laboratory tests.
4.1.1
In the Reporting Period, construction works under the
project have been commenced in Contracts 2, 3, 4, 6, 7 and Contract SS C505
and air quality monitoring was performed at all designated locations.
4.2.1
Summary of air quality monitoring
results during the Reporting Period are tabulated in Table 4-1. The
relevant graphical plots throughout the Reporting Period are presented in Appendix F.
Table 4-1 Summary
of Air Quality Monitoring Results
Monitoring Location |
1-hour TSP (µg/m3) |
24-hour TSP (µg/m3) |
||||
Max |
Min |
Mean |
Max |
Min |
Mean |
|
AM1c |
126 |
34 |
64 |
141 |
17 |
58 |
Record Date |
4-Oct-18 |
18-Sep-18 |
48 events |
20-Sep-18 2-Oct-18 |
10-Aug-18 |
16 events |
AM2 |
161 |
36 |
83 |
303 |
39 |
109 |
Record Date |
26-Oct-18 |
18-Sep-18 |
48 events |
31-Oct-18 |
16-Aug-18 |
16 events |
AM3 |
128 |
38 |
76 |
309 |
15 |
65 |
Record Date |
4-Oct-18 |
18-Aug-18 18-Sep-18 |
48 events |
31-Oct-18 |
22-Aug-18 |
16 events |
AM4b |
124 |
43 |
68 |
108 |
25 |
49 |
Record Date |
2-Oct-18 |
10-Aug-18 |
48 events |
29-Sep-18 |
3-Aug-18 |
16 events |
AM5a |
121 |
47 |
73 |
141 |
21 |
55 |
Record Date |
2-Oct-18 |
10-Aug-18 |
48 events |
5-Oct-18 |
15-Aug-18 |
16 events |
AM6 |
137 |
47 |
78 |
146 |
26 |
85 |
Record Date |
8-Oct-18 |
16-Aug-18 |
48 events |
5-Oct-18 11-Oct-18 |
1-Sep-18 |
16 events |
AM7b |
156 |
26 |
65 |
155 |
23 |
63 |
Record Date |
2-Oct-18 |
3-Sep-18 |
48 events |
5-Oct-18 |
15-Aug-18 |
16 events |
AM8 |
93 |
38 |
57 |
108 |
12 |
43 |
Record Date |
8-Oct-18 |
4-Aug-18 |
48 events |
19-Sep-18 |
15-Aug-18 |
16 events |
AM9b |
86 |
13 |
54 |
78 |
10 |
45 |
Record Date |
22-Sep-18 |
30-Aug-18 |
48 events |
31-Oct-18 |
10-Aug-18 |
16 events |
Remark:
Bold and underlined indicate limit level exceedance.
4.2.2
Breaches of air quality A/L levels and
statistical analysis of compliance for the air quality monitoring results are
summarized in Table 4-2.
Table 4-2 Summaries
of Breaches of Air Quality A/L Levels
Location |
Exceedance |
1-hour TSP |
24- hour TSP |
Total |
AM1 |
Action Level |
0 |
0 |
0 |
Limit Level |
0 |
0 |
0 |
|
AM2 |
Action Level |
0 |
0 |
0 |
Limit Level |
0 |
1 |
1 |
|
AM3 |
Action Level |
0 |
0 |
0 |
Limit Level |
0 |
1 |
1 |
|
AM4a |
Action Level |
0 |
0 |
0 |
Limit Level |
0 |
0 |
0 |
|
AM5a |
Action Level |
0 |
0 |
0 |
Limit Level |
0 |
0 |
0 |
|
AM6 |
Action Level |
0 |
0 |
0 |
Limit Level |
0 |
0 |
0 |
|
AM7b |
Action Level |
0 |
0 |
0 |
Limit Level |
0 |
0 |
0 |
|
AM8 |
Action Level |
0 |
0 |
0 |
Limit Level |
0 |
0 |
0 |
|
AM9b |
Action Level |
0 |
0 |
0 |
Limit Level |
0 |
0 |
0 |
4.2.3
In the
Reporting Period, all the 1-hour
TSP monitoring results were below the
Action/Limit Levels. For 24-hour
TSP monitoring, two (2) Limit Level exceedances were recorded at AM2 and AM3 on 31 October
208. The Investigation Report revealed that the major dust source leaded to the
TSP exceedance was the traffic dust along Lin Ma Hang Road and the Project only
has minor contribution to the exceedance. The Contractor should fully implement
the dust mitigation measures as recommended in the implementation schedule for
environmental mitigation measures in the EM&A Manual.
4.2.4
The summary of weather conditions during the Reporting
Period is presented in Appendix G.
5.1.1
In the Reporting Period, construction works under the
project have been commenced in Contracts 2, 3, 4, 6, 7 and Contract SS C505
and noise monitoring was performed at all designated locations.
5.2.1
The sound level meter was set in 1m from the
exterior of the building façade including noise monitoring locations NM1, NM2,
NM3, NM4, NM5, NM6, NM7, NM8 and NM9. No façade correction (+3 dB(A) is added according to acoustical principles and EPD
guidelines. However, free-field
status is performed at NM2a and NM10 and façade correction (+3 dB(A) has added according to the requirement.
5.2.2
Summary of noise monitoring results
during the Reporting Period are tabulated in Table 5-1. The
relevant graphical plots throughout the Reporting Period are presented in Appendix F.
Table 5-1 Summary of Construction Noise
Monitoring Results
Monitoring
Location |
Leq, 30min (dB((A)) |
|
Max |
Min |
|
NM1 |
60 |
54 |
Record Date |
13-Aug-18,
5-Sep-18, 15-Oct-18 |
18-Sep-18 |
NM2a(*) |
74 |
67 |
Record Date |
1-Aug-18 |
30-Aug-18 |
NM3 |
64 |
55 |
Record Date |
8-Oct-18,
19-Oct-18 |
22-Aug-18 |
NM4 |
66 |
57 |
Record Date |
10-Aug-18, 8-Oct-18 |
3-Sep-18 |
NM5 |
61 |
53 |
Record Date |
31-Oct-18 |
10-Aug-18 |
NM6 |
65 |
58 |
Record Date |
8-Oct-18 |
10-Aug-18,
28-Aug-18, 14-Sep-18, 20-Sep-18, 26-Sep-18, 2-Oct-18 |
NM7 |
73 |
60 |
Record Date |
22-Aug-18 |
10-Aug-18,
25-Oct-18 |
NM8 |
67 |
55 |
Record Date |
7-Aug-18 |
22-Aug-18 |
NM9 |
73 |
55 |
Record Date |
15-Oct-18 |
17-Sep-18 |
NM10(*) |
66 |
58 |
Record Date |
7-Aug-18 |
4-Oct-18 |
(*) façade
correction (+3 dB(A) is added according to acoustical
principles and EPD guidelines
5.2.3
Breaches of construction noise A/L
levels and statistical analysis of compliance for construction noise monitoring
results are summarized in Table 5-2.
Table 5-2 Summaries
of Breaches of Construction Noise A/L Levels
Station |
Limit Level |
Action Level |
Received Date |
NM1 |
0 |
0 |
N/A |
NM2a |
0 |
||
NM3 |
0 |
||
NM4 |
0 |
||
NM5 |
0 |
||
NM6 |
0 |
||
NM7 |
0 |
||
NM8 |
0 |
||
NM9 |
0 |
||
NM10 |
0 |
5.2.4
In
this Reporting Period, the noise level
measured at all designated monitoring locations were below 75dB(A). No Action level and
Limit Level exceedance was triggered and no corrective action was required.
6.1.1
In the Reporting Period, construction works under the
project has been commenced in Contracts 2, 3, 4, 6, 7 and Contract SS C505
and water quality monitoring was performed at all designated locations.
6.2.1
Summary of monitoring results during the
Reporting Period are tabulated in Tables
6-1 and 6-4. The relevant
graphical plots throughout the Reporting Period are presented in Appendix F.
6.2.2
In
accordance with ¡§Event
and Action Plan¡¨,
the water quality monitoring frequency shall be increased to daily when
exceedance recorded at the exceeded monitoring location. In the Reporting Period, forty (40) sampling days was scheduled to carry out
for Locations WM1, WM2A(a), WM3x and WM4 with their control stations..
Moreover, 2, 12, 4, 2 days of extra water sampling were
conducted for WM1, WM2A, WM3 and WM4 and all its control
station.
Table 6-1 Summary
of the Water Quality Monitoring Results ¡V Contracts SS C505 and 6
Statistics |
DO
(mg/L) |
Turbidity
(NTU) |
SS
(mg/L) |
|||
WM1 |
WM1- Control |
WM1 |
WM1- Control |
WM1 |
WM1- Control |
|
Min |
5.5 |
6.2 |
10.5 |
7.4 |
8.0 |
4.0 |
Max |
8.3 |
8.2 |
911.0 |
931.5 |
1110.0 |
1740.0 |
Average |
7.1 |
7.1 |
47.1 |
50.3 |
90.1 |
86.6 |
Table 6-2 Summary
of the Water Quality Monitoring Results ¡V Contracts
2 & 3
Statistics |
DO
(mg/L) |
Turbidity
(NTU) |
SS
(mg/L) |
||||||
WM4 |
WM4 - CA |
WM4 - CB |
WM4 |
WM4 - CA |
WM4 - CB |
WM4 |
WM4 - CA |
WM4 - CB |
|
Min |
5.3 |
5.2 |
4.5 |
7.6 |
2.7 |
4.1 |
7.0 |
<2 |
2.5 |
Max |
8.8 |
9.6 |
8.9 |
595.0 |
287.0 |
281.5 |
564.5 |
744.0 |
177.0 |
Average |
7.1 |
7.5 |
6.4 |
45.5 |
17.1 |
28.3 |
39.0 |
31.8 |
22.2 |
Table 6-3 Summary
of the Water Quality Monitoring Results ¡V Contract 6
Statistics |
DO
(mg/L) |
Turbidity
(NTU) |
SS
(mg/L) |
|||||||||
WM2A(a) |
WM2A-C |
WM2B |
WM2B-C |
WM2A(a) |
WM2A-C |
WM2B |
WM2B-C |
WM2A(a) |
WM2A-C |
WM2B |
WM2B-C |
|
Min |
5.3 |
5.7 |
* |
* |
6.6 |
3.9 |
* |
* |
2.5 |
<2 |
* |
* |
Max |
8.1 |
8.1 |
* |
* |
428.0 |
364.5 |
* |
* |
1235 |
334.5 |
* |
* |
Average |
7.0 |
7.1 |
* |
* |
60.6 |
24.4 |
* |
* |
69.0 |
19.4 |
* |
* |
Remark: (*) Since 10 Apr 2017,
water sampling was unable to carry out at WM2B and WM2B-C due to shallow water
(water depth under 150mm)
Table 6-4 Summary
of the Water Quality Monitoring Results ¡V Contracts 2
& 6
Statistics |
DO
(mg/L) |
Turbidity
(NTU) |
SS
(mg/L) |
|||
WM3 |
WM3- Control |
WM3 |
WM3- Control |
WM3 |
WM3- Control |
|
Min |
6.2 |
6.0 |
3.8 |
1.8 |
<2 |
<2 |
Max |
9.0 |
7.8 |
351.5 |
145.0 |
263.5 |
672.0 |
Average |
6.8 |
6.9 |
33.7 |
16.8 |
33.9 |
43.8 |
6.2.3
Breaches of water quality A/L levels and
statistical analysis of compliance for the water quality monitoring results are
summarized in Tables 6-5.
Table 6-5 Summaries
of Breaches of the Existing Water Quality A/L Levels
Reporting Period |
No. of sampling day |
Location |
DO (mg/L) |
Turbidity (NTU) |
SS (mg/L) |
|||
Action |
Limit |
Action |
Limit |
Action |
Limit |
|||
Aug-18 |
15 |
WM1 |
0 |
0 |
0 |
2 |
0 |
2 |
18 |
WM2A(a) |
0 |
0 |
0 |
8 |
0 |
8 |
|
0 |
WM2B |
0 |
0 |
0 |
0 |
0 |
0 |
|
16 |
WM3x |
0 |
0 |
0 |
3 |
0 |
2 |
|
15 |
WM4 |
0 |
0 |
0 |
3 |
1 |
1 |
|
Sep-18 |
13 |
WM1 |
0 |
0 |
0 |
0 |
0 |
0 |
17 |
WM2A(a) |
0 |
0 |
1 |
3 |
1 |
5 |
|
0 |
WM2B |
0 |
0 |
0 |
0 |
0 |
0 |
|
13 |
WM3x |
0 |
0 |
0 |
0 |
0 |
0 |
|
13 |
WM4 |
0 |
0 |
0 |
0 |
0 |
0 |
|
Oct-18 |
14 |
WM1 |
0 |
0 |
0 |
0 |
0 |
0 |
17 |
WM2A(a) |
0 |
0 |
0 |
4 |
0 |
6 |
|
0 |
WM2B |
0 |
0 |
0 |
0 |
0 |
0 |
|
15 |
WM3x |
0 |
0 |
0 |
3 |
0 |
3 |
|
14 |
WM4 |
0 |
0 |
0 |
0 |
0 |
0 |
|
Total |
42 |
WM1 |
0 |
0 |
0 |
2 |
0 |
2 |
52 |
WM2A(a) |
0 |
0 |
1 |
15 |
1 |
19 |
|
0 |
WM2B |
0 |
0 |
0 |
0 |
0 |
0 |
|
44 |
WM3x |
0 |
0 |
0 |
6 |
0 |
5 |
|
42 |
WM4 |
0 |
0 |
0 |
3 |
1 |
1 |
|
Sum |
0 |
0 |
1 |
26 |
2 |
27 |
6.2.4
In the Reporting Period, a total of 56 Action/ Limit Level (LL) exceedances, namely 27 AL/LL exceedance of turbidity and 29 AL/ LL exceedances of
Suspended Solids were recorded. NOEs were issued
to relevant parties upon confirmation of the results.
6.2.5
Investigation
reports for the exceedance were conducted by the ET and the investigation
results revealed that all exceedances were not related to the works under the project. The detailed investigation
reports are summarized
in Table 6-6 and presented in the relevant monthly
EM&A reports.
Table 6-6 Summary
of Water Quality Exceedance in the Reporting Period
Date of Exceedance |
Location |
Exceeded Parameter |
Cause of Water Quality Exceedance In Brief |
30 July 2018(last reporting period) |
WM3x |
Turbidity
& SS |
In our investigation,
the Contractors had implemented water quality mitigation measures and no
adverse water quality impact was observed during site inspection. Since turbid water was observed at the
channel side of WM3x which suspected flowing from the storm drain of Sha Tau Kok Road or adjacent villages, it is considered that the
exceedances were likely external source of muddy water and not caused by the
works under the Project. |
13,
14 and 15 August 2018 |
WM4 |
Turbidity & SS |
In our
investigation, the Contractor of Contract 3 (Chun Wo) had implemented water quality
mitigation measures properly and no adverse water quality impact was observed
during the site inspections. In viewing
of inflow of muddy water from outside the site boundary, it is considered
that the exceedances were unlikely caused by the works under Contract 3. Water quality
impact was identified at South Portal of Contract 2 during site inspection
and the deficiency was considered as short term impact which has been rectified
after site inspection. In view of
the inflow of muddy water from outside site boundary and deficiencies for
water quality impact observed during site inspection, it was considered that
the exceedances were related to the external muddy water and partially
related to Contract 2. As the
concerned storm drain has been backfilled by DHK and no exceedance was
recorded in following days, no corrective action is required. |
10
August 2018 |
WM1 |
Turbidity & SS |
In our
investigation, the water quality mitigation implemented for Bridge Y and site
condition was generally in order. It was considered that exceedances were
related to the rainstorm and not due to the works under Contract 6. |
13
and 14 August 2018 |
WM3x |
Turbidity & SS |
In our investigation,
the Contractors had implemented water quality mitigation measures and no
adverse water quality impact was observed during site inspection. Since turbid water was observed at the
channel side of WM3x which suspected flowing from the storm drain of Sha Tau Kok Road or adjacent villages, it is considered that the
exceedances were likely external source of muddy water and not caused by the
works under the Project. |
20 August 2018 |
WM3x |
Turbidity & SS |
In our investigation,
the Contractors had implemented water quality mitigation measures and no
adverse water quality impact was observed during site inspection. Since turbid water was observed at the
channel side of WM3x which suspected flowing from the storm drain of Sha Tau Kok Road or adjacent villages, it is considered that the
exceedances were likely external source of muddy water and not caused by the
works under the Project. |
30
August 2018 |
WM1 |
Turbidity & SS |
In our investigation, water quality mitigation implemented
for Bridge Y and no adverse water quality impact contributed to WM1 was observed. Since muddy water was also observed at
control station after rain, it was considered that exceedances were related
to the impact of rainstorm and not due to the works under Contract 6. |
22,
23 and 24 August 2018 |
WM2A(a) |
Turbidity & SS |
In our
investigation, CCKJV had implemented water quality mitigation measures such as providing tarpaulin sheet for open slope and surface to minimize muddy runoff. There was no adverse water quality
impact observed during the site inspection at works area of Bridge D. It is considered that the exceedances on 22, 23 and 24 August
2018 were related to the impact of rainstorm and not caused by the works
under the Project. |
27
and 28 August 2018 |
WM2A(a) |
Turbidity & SS |
In our
investigation, CCKJV had implemented water quality mitigation measures such as providing tarpaulin sheet for open slope and surface to minimize muddy runoff. There was no adverse water quality
impact observed during the site inspection at works area of Bridge D. It is considered that the exceedances on 27 and 28 August 2018
were related to the impact of rainstorm and not caused by the works under the
Project. |
29,
30 and 31 August 2018 |
WM2A(a) |
Turbidity & SS |
In our
investigation, CCKJV had implemented water quality mitigation measures such as providing tarpaulin sheet for open slope and surface to minimize muddy runoff.
There was no adverse water quality impact observed during the site inspection at works area of Bridge D. It is considered that the exceedances on 29 to 31 August 2018
were related to the impact of rainstorm and not caused by the works under the
Project. |
3 September 2018 |
WM2A(a) |
Turbidity & SS |
In our
investigation, CCKJV had implemented water quality mitigation measures such as providing tarpaulin sheet for open slope and surface to minimize muddy runoff.
There was no adverse water quality impact observed during the site inspection at works area of Bridge D. It is considered that the exceedances on 3 September 2018 were
related to the impact of rainstorm and not caused by the works under the
Project. |
5 and 7 September 2018 |
WM2A(a) |
SS |
In our
investigation, CCKJV had implemented water quality mitigation measures such as providing tarpaulin sheet for open slope and surface to minimize muddy runoff.
There was no adverse water quality impact observed during the site inspection at works area of Bridge D. It is considered that the exceedances on 5 and 7 September 2018
were not caused by the works under the Project. |
18 September 2018 |
WM2A(a) |
Turbidity & SS |
In our
investigation, CCKJV had implemented water quality mitigation measures such as providing tarpaulin sheet for open slope and surface to minimize muddy runoff.
There was no adverse water quality impact observed during the site inspection at works area of Bridge D. It is considered that the exceedances on 18 September 2018 were
not caused by the works under the Project. |
24 and 27 September 2018 |
WM2A(a) |
Turbidity & SS |
In our investigation, CCKJV had implemented water
quality mitigation measures such as providing tarpaulin sheet for open slope
and surface to minimize muddy runoff.
There was no adverse water quality impact observed during the site
inspection at works area of Bridge D.
It is concluded that the exceedances were unlikely caused by the works
under the Project. |
9 and 10 October 2018 |
WM2A(a) |
Turbidity & SS |
In our
investigation, CCKJV had implemented water quality mitigation measures such as providing tarpaulin sheet for open slope and surface to minimize muddy runoff.
There was no adverse water quality impact observed during the site inspection at works area of Bridge D. It is concluded that the exceedances
were
unlikely caused by the works under the Project. |
11 and 12 October 2018 |
WM2A(a) |
Turbidity & SS |
In our
investigation, CCKJV had implemented water quality mitigation measures such as providing tarpaulin sheet for open slope and surface to minimize muddy runoff.
In view of the heavy rainstorm on 10 October 2018 affecting the water quality of the river course in subsequent
days, it is concluded that the
exceedances were related to the
impact of rainstorm and unlikely caused by the works under the Project. |
27 and 29 October 2018 |
WM2A(a) |
Turbidity & SS |
In our investigation, CCKJV had implemented water quality mitigation
measures such as providing tarpaulin sheet for open slope
and surface to minimize muddy runoff. Since improper discharge from another
project was observed and there was no
adverse water quality impact observed during the site inspection at works area of Bridge D.
It is concluded that the exceedances were unlikely caused by the works under the
Project. |
27, 29 and 30 October 2018 |
WM3x |
Turbidity & SS |
In our investigation, CCKJV implemented water quality
mitigation measures and no adverse water quality impact
was observed during site inspection. It is considered that the exceedances were unlikely caused by the works under Contract
6. In our investigation, DHK had implemented and well maintained the
wastewater treatment facilities and no adverse water quality impact was
identified at North Portal Site and Admin Building Site during site inspection. It is considered that the exceedances were unlikely caused by the works under Contract
2. |
7.1.1
Ecology
monitoring for woodland compensation was shall be conducted at bi-monthly interval for the first year and the monitoring
frequency would be reduced to quarterly from the second year.
7.1.2
The last Quarterly Ecological Monitoring Report (June
to August 2018) was submitted to EPD in September 2018 in standalone copy as supplementary
of the EM&A Report.
8.1.1
Waste management was carried out by an
on-site Environmental Officer or an Environmental Supervisor from time to time.
8.2.1
All types of waste arising from the
construction work are classified into the following:
l
Construction & Demolition (C&D) Material;
l
Chemical Waste;
l
General Refuse
l
Excavated Soil.
8.2.2
Whenever possible, materials were reused
on-site as far as practicable. The
quantities of waste for disposal in the Reporting Period are summarized in Tables
8-1 and 8-2 and the Waste Flow Table is presented in Appendix H.
Table 8-1 Summary
of Quantities of Inert C&D Materials
Type of Waste |
Contract No |
Quantity |
Disposal
Location |
|||
Aug 2018 |
Sep
2018 |
Oct 2018 |
Total |
|||
C&D Materials (Inert) (in '000m3) |
2 |
5.4100 |
8.2680 |
3.2564 |
55.7114 |
- |
3 |
2.372 |
1.709 |
1.198 |
|
||
4 |
0 |
0 |
0 |
- |
||
6 |
2.562 |
0.997 |
1.896 |
- |
||
7 |
0.047 |
0.041 |
0.047 |
|
||
SS C505 |
16.440 |
7.849 |
3.619 |
- |
||
Reused in this Project (Inert) (in '000m3) |
2 |
0 |
0 |
0 |
1.614 |
- |
3 |
0.613 |
0.381 |
0 |
- |
||
4 |
0 |
0 |
0 |
- |
||
6 |
0 |
0 |
0 |
- |
||
7 |
0 |
0 |
0 |
|
||
SS C505 |
0.263 |
0.161 |
0.196 |
- |
||
Reused in other Projects (Inert) (in '000m3) |
2 |
0.7600 |
3.0430 |
1.1273 |
8.8573 |
Recycling facility as approved alternative site |
3 |
0 |
0 |
0 |
|
||
4 |
0 |
0 |
0 |
|
||
6 |
1.989 |
0.552 |
1.386 |
NENT |
||
7 |
0 |
0 |
0 |
|
||
SS C505 |
0 |
0 |
0 |
|
||
Disposal as Public Fill
(Inert) (in '000m3) |
2 |
4.6500 |
5.2250 |
2.1291 |
58.3011 |
Tuen Mun 38 TKO 137 |
3 |
1.281 |
0.967 |
0.882 |
|||
4 |
0 |
0 |
0 |
|||
6 |
0.886 |
3.070 |
13.192 |
|||
7 |
0.047 |
0.041 |
0.047 |
|||
SS C505 |
16.036 |
7.573 |
2.275 |
Remark:
(#)The C&D materials were delivered to
NENT for reuse by laying cover of the landfilling area.
Table 8-2 Summary
of Quantities of C&D Wastes
Type of Waste |
Contract No |
Quantity |
Disposal Location |
|||
Aug 2018 |
Sep
2018 |
Oct 2018 |
Total |
|||
Recycled Metal (¡¥000kg) # |
2 |
31.5900 |
30.7800 |
0 |
1042.19 |
By licensed collector |
3 |
0 |
0 |
0 |
|||
4 |
0 |
0 |
0 |
|||
6 |
0 |
0 |
0 |
|||
7 |
5.8 |
1.1 |
1.5 |
|||
SS C505 |
466.220 |
153.620 |
351.580 |
|||
Recycled Paper / Cardboard Packing (¡¥000kg) # |
2 |
0.2570 |
0.2200 |
0.1700 |
3.13 |
By licensed
collector |
3 |
0 |
0 |
0 |
|||
4 |
0 |
0 |
0 |
|||
6 |
0.360 |
0.225 |
0.188 |
|||
7 |
0.
1 |
0.
1 |
0.2 |
|||
SS C505 |
0.230 |
0.620 |
0.460 |
|||
Recycled
Plastic (¡¥000kg) # |
2 |
2.2000 |
1.8000 |
1.0125 |
5.5385 |
By licensed collector |
3 |
0 |
0 |
0 |
|||
4 |
0 |
0 |
0 |
|||
6 |
0 |
0 |
0 |
|||
7 |
0.001 |
0.001 |
0.001 |
|||
SS C505 |
0 |
0.033 |
0.490 |
|||
Chemical
Wastes (¡¥000kg) * |
2 |
3.0800 |
1.2300 |
9.5200 |
15.03 |
By licensed collector |
3 |
0 |
0 |
0 |
|||
4 |
0 |
0 |
0 |
|||
6 |
0 |
0 |
0 |
|||
7 |
0 |
0 |
0 |
|||
SS C505 |
1.200 |
0 |
0 |
|||
General
Refuses (¡¥000m3) |
2 |
0.8400 |
0.4440 |
0.5969 |
12.8599 |
NENT |
3 |
0.095 |
0.150 |
0.115 |
|||
4 |
0 |
0 |
0.012 |
|||
6 |
0.866 |
0.633 |
0.855 |
|||
7 |
0.1 |
0.1 |
0.2 |
|||
SS C505 |
3.114 |
2.704 |
2.035 |
Remark:
(#) Unit of recycled
metal, recycled paper/ cardboard packing and recycled plastic for Contractor 3 was in (¡¥000m3).
(*) Unit of chemical waste for Contractor 3 was in m3.
8.2.3
To control the site performance on waste management, the
Contractor shall ensure that all solid and liquid waste management works are
fully in compliance with the relevant license/permit requirements, such as the
effluent discharge license and the chemical waste producer registration. The Contractor is also reminded to
implement the recommended environmental mitigation measures according to the Environmental Monitoring and Audit
Manual.
9.1.1
According to the approved EM&A Manual,
the environmental site inspection shall be formulation by ET Leader. Weekly environmental site inspections should
carry out to confirm the environmental performance.
Contract 2
9.1.2
During the Reporting Period, 13 events of
the joint site inspections were undertaken at Contract 2 to evaluate the site
environmental performance. The
summaries of the findings during site inspection are presented in Table
9-1 and the details of site inspection can be found in relevant
EM&A monthly report.
Table 9-1 Summary
of Reminders/Observations of Site Inspection ¡V Contract 2
Reporting Period |
Date of site inspection |
Nos. of findings / reminders |
Follow-Up Status |
August 2018 |
3, 10, 17, 24
and 31 August 2018 |
6 |
Completed |
September 2018 |
7, 14, 21 and
28 September 2018 |
7 |
Completed |
October 2018 |
5, 12, 19 and
26 October 2018 |
5 |
Completed |
9.1.3
In the Reporting Period, no non-compliance
was recorded; however, 18 observations/
reminders were recorded during the site inspections. Minor deficiencies found in the weekly
site inspection were in general rectified within the specified deadlines. The environmental performance of the
Project was therefore considered satisfactory.
Contract 3
9.1.4
During the Reporting Period, 13 events of
the joint site inspections were undertaken at Contract 3 to evaluate the site
environmental performance. The
summaries of the findings during site inspection are presented in Table
9-2 and the details of site inspection can be found in relevant
EM&A monthly report.
Table 9-2 Summary
of Reminders/Observations of Site Inspection ¡V Contract 3
Reporting Period |
Date of site inspection |
Nos. of findings / reminders |
Follow-Up Status |
August 2018 |
2, 9, 15, 23
and 30 August 2018. |
8 |
Completed |
September 2018 |
6, 13, 19 and
27 September 2018 |
5 |
Completed |
October 2018 |
4, 11, 18 and
24 October 2018 |
4 |
Completed |
9.1.5
In the Reporting Period, no non-compliance
was recorded; however, 17 observations/
reminders were recorded during the site inspections. Minor deficiencies found in the weekly
site inspection were in general rectified within the specified deadlines. The environmental performance of the
Project was therefore considered satisfactory.
Contract 4
9.1.6
During the Reporting Period, 13 events of
the joint site inspections were undertaken at Contract 4 to evaluate the site
environmental performance. The
summaries of the findings during site inspection are presented in Table
9-3 and the details of site inspection can be found in relevant
EM&A monthly report.
Table 9-3 Summary
of Reminders/Observations of Site Inspection ¡V Contract 4
Reporting Period |
Date of site inspection |
Nos. of findings / reminders |
Follow-Up Status |
August 2018 |
3, 10, 17, 20
and 31 August 2018 |
0 |
Completed |
September 2018 |
7, 14, 21 and
24 September 2018 |
0 |
Completed |
October 2018 |
5, 12, 19 and
22 October 2018 |
0 |
Completed |
9.1.7
In the Reporting Period, no non-compliance
was recorded; however, no observations/ reminders was
recorded during the site inspections.
The environmental performance of the Project was therefore considered satisfactory.
Contract 6
9.1.8
During the Reporting Period, 13 events of
the joint site inspections were undertaken at Contract 6 to evaluate the site
environmental performance. The
summaries of the findings during site inspection are presented in Table
9-4 and the details of site inspection can be found in relevant
EM&A monthly report.
Table 9-4 Summary
of Reminders/Observations of Site Inspection ¡V Contract 6
Reporting Period |
Date of site inspection |
Nos. of findings / reminders |
Follow-Up Status |
August 2018 |
2, 9, 16, 23
and 30 August 2018 |
9 |
Completed |
September 2018 |
6, 13, 20 and
27 September 2018 |
6 |
Completed |
October 2018 |
4, 11, 18 and
25 October 2018 |
5 |
Completed |
9.1.9
In the Reporting Period, no non-compliance
was recorded; however, 20 observations/ reminders
were recorded during the site inspections.
Minor deficiencies found in the weekly site inspection were in general
rectified within the specified deadlines.
The environmental performance of the Project was therefore considered
satisfactory.
Contract SS
C505
9.1.10 During the
Reporting Period, 14 events of the joint
site inspections were undertaken at Contract SS C505 to evaluate the site
environmental performance. The
summaries of the findings during site inspection are presented in Table
9-5 and the details of site inspection can be found in relevant
EM&A monthly report.
Table 9-5 Summary
of Reminders/Observations of Site Inspection ¡V Contract SS C505
Reporting Period |
Date of site inspection |
Nos. of findings / reminders |
Follow-Up Status |
August 2018 |
1, 8, 15, 22
and 29 August 2018 |
12 |
Completed |
September 2018 |
5, 12, 19 and
27 September 2018 |
5 |
Completed |
October 2018 |
3, 10, 15, 25
and 31 October 2018 |
5 |
Completed |
9.1.11 In the
Reporting Period, no non-compliance was recorded; however, 22 observations/
reminders were recorded during the site inspections. Minor deficiencies found in the weekly
site inspection were in general rectified within the specified deadlines. The environmental performance of the
Project was therefore considered satisfactory.
Contract 7
9.1.12 During the
Reporting Period, 13 events of the joint site inspections were undertaken at
Contract SS C505 to evaluate the site environmental performance. The summaries of the findings during
site inspection are presented in Table 9-6 and the details of site
inspection can be found in relevant EM&A monthly report.
Table 9-6 Summary
of Reminders/Observations of Site Inspection ¡V Contract 7
Reporting Period |
Date of site inspection |
Nos. of findings / reminders |
Follow-Up Status |
August 2018 |
3, 10, 17, 21
and 31 August 2018 |
4 |
Completed |
September 2018 |
7, 14, 18 and
28 September 2018 |
3 |
Completed |
October 2018 |
5, 12, 16 and
26 October 2018 |
4 |
Completed |
9.1.13 In the
Reporting Period, no non-compliance was recorded; however, 11
observations/ reminder were recorded during the site inspections. Minor deficiencies found in the weekly
site inspection were in general rectified within the specified deadlines. The environmental performance of the
Project was therefore considered satisfactory.
Other
Contracts
9.1.14 Since the
construction work of Contract 5 has substantially completed, no site inspection
was performed.
10.1.1 In the Reporting
Period, no environmental complaints were received under the EM&A program of
the Project. Moreover, no summons
and prosecution under the EM&A Programme was
lodged for all Contracts. The
status of the outstanding investigation report in previous months is summarized
below.
10.1.2
The
statistical summary table of environmental complaint, summons and prosecution
are presented in Tables 10-1, 10-2 and
10-3.
Table 10-1 Statistical
Summary of Environmental Complaints
Contract No |
Reporting Period |
Environmental Complaint Statistics |
|||
Frequency
|
Cumulative since commencement of project |
Complaint Nature |
Project related
complaint |
||
2 |
Aug 2018 |
0 |
36 |
(19)Water Quality (8) Dust (5) Noise (1) dust & noise (1) waste management
(1) Water quality and dust |
(7) water quality (2) dust (1) noise |
Sep 2018 |
0 |
||||
Oct 2018 |
1 |
||||
3 |
Aug 2018 |
0 |
6 |
(2) Dust (3) Water quality (1) Noise |
0 |
Sep 2018 |
0 |
||||
Oct 2018 |
0 |
||||
4 |
Aug 2018 |
0 |
0 |
NA |
NA |
Sep 2018 |
0 |
||||
Oct 2018 |
0 |
||||
6 |
Aug 2018 |
1 |
42 |
(24) Water Quality (10) Dust (3) Noise (1) Nuisance (1) Noise and dust (2) Water quality and dust (1) Water quality and noise |
(8) water quality (3) dust (1) Nuisance (1) Water quality and dust (1) Water quality and noise |
Sep 2018 |
0 |
||||
Oct 2018 |
3 |
||||
7 |
Aug 2018 |
0 |
3 |
(1) Noise (2) Water quality and dust |
NA |
Sep 2018 |
0 |
||||
Oct 2018 |
0 |
||||
SS C505 |
Aug 2018 |
0 |
5 |
(1) Noise (1) dust (2) Water quality and dust (1) Water quality |
NA |
Sep 2018 |
|
||||
Oct 2018 |
0 |
Table 10-2 Statistical
Summary of Environmental Summons
Contract No |
Reporting Period |
Environmental
Summons Statistics |
||
Frequency |
Cumulative since commencement of project |
Complaint Nature |
||
2 |
Aug 2018 |
0 |
1 |
contravening the
Water Pollution Control (General) Regulations |
Sep 2018 |
0 |
|||
Oct 2018 |
0 |
|||
3 |
Aug 2018 |
0 |
0 |
NA |
Sep 2018 |
0 |
|||
Oct 2018 |
0 |
|||
4 |
Aug 2018 |
0 |
0 |
NA |
Sep 2018 |
0 |
|||
Oct 2018 |
0 |
|||
6 |
Aug 2018 |
0 |
0 |
NA |
Sep 2018 |
0 |
|||
Oct 2018 |
0 |
|||
7 |
Aug 2018 |
0 |
0 |
NA |
Sep 2018 |
0 |
|||
Oct 2018 |
0 |
|||
SS C505 |
Aug 2018 |
0 |
0 |
NA |
Sep 2018 |
0 |
|||
Oct 2018 |
0 |
Table 10-3 Statistical
Summary of Environmental Prosecution
Contract No |
Reporting Period |
Environmental
Prosecution Statistics |
||
Frequency |
Cumulative since commencement of project |
Complaint Nature |
||
2 |
Aug 2018 |
0 |
1 |
contravening the
Water Pollution Control (General) Regulations |
Sep 2018 |
0 |
|||
Oct 2018 |
0 |
|||
3 |
Aug 2018 |
0 |
0 |
NA |
Sep 2018 |
0 |
|||
Oct 2018 |
0 |
|||
4 |
Aug 2018 |
0 |
0 |
NA |
Sep 2018 |
0 |
|||
Oct 2018 |
0 |
|||
6 |
Aug 2018 |
0 |
0 |
NA |
Sep 2018 |
0 |
|||
Oct 2018 |
0 |
|||
7 |
Aug 2018 |
0 |
0 |
NA |
Sep 2018 |
0 |
|||
Oct 2018 |
0 |
|||
SS C505 |
Aug 2018 |
0 |
0 |
NA |
Sep 2018 |
0 |
|||
Oct 2018 |
0 |
10.1.3 Since
the construction works at the Contract 5 was substantially completed, no
environmental complaint, summons and prosecution under the EM&A Programme are registered.
11.1.1
The environmental mitigation measures that
recommended in the Implementation Schedule for Environmental Mitigation
Measures (ISEMM) in the approved EM&A Manual covered the issues of dust,
noise, water and waste and they are summarized presented in Appendix
I.
11.1.2
All contracts under the Project shall be
implementing the required environmental mitigation measures according to the approved
EM&A Manual as subject to the site condition. Environmental mitigation measures
generally implemented by Contracts 2, 3, 5, 6 and SS C505 in this Reporting
Period are summarized in Table 11-1.
Table 11-1 Environmental
Mitigation Measures
Issues |
Environmental Mitigation Measures |
Water Quality |
¡P Wastewater to be treated by
the filtration systems i.e. sedimentation tank or AquaSed before to discharge. |
Air Quality |
¡P Maintain damp / wet surface
on access road ¡P Low vehicular speed within
the works areas. ¡P All vehicles must use wheel
washing facility before off site ¡P Sprayed water during
breaking works ¡P A
cleaning truck was regularly performed on the public road to prevent fugitive dust emission |
Noise |
¡P Restrain operation time of
plants from 07:00 to 19:00 on any working day except for Public Holiday and Sunday. ¡P Keep good maintenance of
plants ¡P Place noisy plants away from
residence or school ¡P Provide noise barriers or
hoarding to enclose the noisy plants or works ¡P Shut down the plants when
not in used. |
Waste and Chemical
Management |
¡P On-site sorting prior to disposal ¡P Follow requirements and
procedures of the ¡§Trip-ticket System¡¨ ¡P Predict required quantity of
concrete accurately ¡P Collect
the unused fresh concrete at designated locations in the sites for subsequent
disposal |
General |
¡P The site was generally kept tidy
and clean. |
12.1.1 This is the
21st Quarterly EM&A Summary
Report presenting the monitoring results and inspection findings for the
Reporting Period from 1 August to 31 October 2018.
12.1.2 For air quality monitoring, no 1-hour TSP monitoring results triggered the Action /Limit Level, however, two (2) Limit Level exceedances of
24-hour TSP were recorded.
12.1.3 In the
Reporting Period, no construction noise exceedances were
recorded and no complaints (which triggered
the Action Level exceedance) were
received.
12.1.4 For water
quality monitoring, a total of 56 Action/ Limit Level (LL) exceedances, namely 27
AL/LL exceedance of turbidity and 29 AL/ LL exceedances of Suspended Solids
were recorded. Most of investigation results revealed that the Contractor had
properly implemented water quality mitigation measures such as well-maintained
the wastewater treatment facility and covered the expose area with impervious
sheet and it was concluded that the exceedances were related to the unknown
source of muddy water contributed from outside the project area and not caused
by the works under the Project. However, some investigations results revealed
that exceedances recorded at WM4 concluded as partially related to the work
under Contract 2 while the Contractor has promptly rectified the deficiency. Nevertheless, the Contractor was reminded
to fully implement the water quality mitigation measure throughout the constriction
phase as far as practicable.
12.1.5 In this Reporting Period, Quarterly
Ecological Monitoring Report for woodland compensation (June to August 2018) was submitted to EPD in September 2018.
12.1.6 In this Reporting Period, four (4)
documented environmental complaints were received under the EM&A programme with respective to the dust, muddy water and
noise issues. The investgation for complaint related
to contract 6 reveals that some deficiencies
at site exit was observed, however, the Contractor has
promptly rectified the deficiencies and provided remedial action to response
the complaint. Two
complaints regarding to dust concerns near the junction on Sha Tau Kok Road and Wo Keng Shan Road
and Shui Lau Hang Village were considered not related to the project. For the complaint about
muddy road and noise nuisance found on Ping Yeung Village, investigation revealed that it was related to the unpaved haul road near the Ping Yeung Interchange and insufficient cleaning of vehicles at
site exit. Rectification works has immediately undertaken by the Contractor. Besides, the noise nuisance was found no
related to the project.
12.1.7 No environmental summons or successful
prosecutions were recorded in the Reporting Period.
12.1.8
During
the Reporting Period, weekly joint site inspection by the RE, IEC, ET with the relevant Main-contractor were
carried out for Contracts 2, 3, 4,
6
and 7 in accordance with the
EM&A Manual stipulation. For
Contract SS C505, weekly joint
site inspection was carried out by the RE, IEC, ET and main-contractor whereas IEC performed
monthly site inspection. No non-compliance observed during the
site inspection.
12.2.1
During
dry season, special attention should be paid on the potential construction dust
impact since most of the construction sites are adjacent to villages. The
Contractor should fully implement the construction dust mitigation measures as
appropriately.
12.2.2
Preventive
measures for muddy water or other water pollutants from site surface flow to
local stream such as Kong Yiu Channel, Ma Wat
Channel, Ping Yuen River, Kwan Tei
River or public area should be properly maintained. The Contractors should paid special
attention on water quality mitigation measures and fully implement according
ISEMM of the EM&A Manual, in particular for working areas near Ma Wat
Channel and Ping Yuen River.
12.2.3
In
addition, all effluent discharge shall be ensure to fulfill Technical
Memorandum of Effluent Discharged into Drainage and Sewerage Systems, inland
and Coastal Waters criteria or discharge permits stipulation.
12.2.4
Construction
noise would be a key environmental issue during construction work of the
Project. Noise mitigation measures
such as using quiet plants should be implemented in accordance with the
EM&A requirement.
12.2.5
Since
most of construction sites under the Project are located adjacent to villages,
the Contractors should fully implement air quality mitigation measures to
reduce construction dust emission.
12.2.6
Furthermore,
daily cleaning and weekly tidiness shall be properly performed and maintained.
In addition, mosquito control should be kept to prevent mosquito breeding on

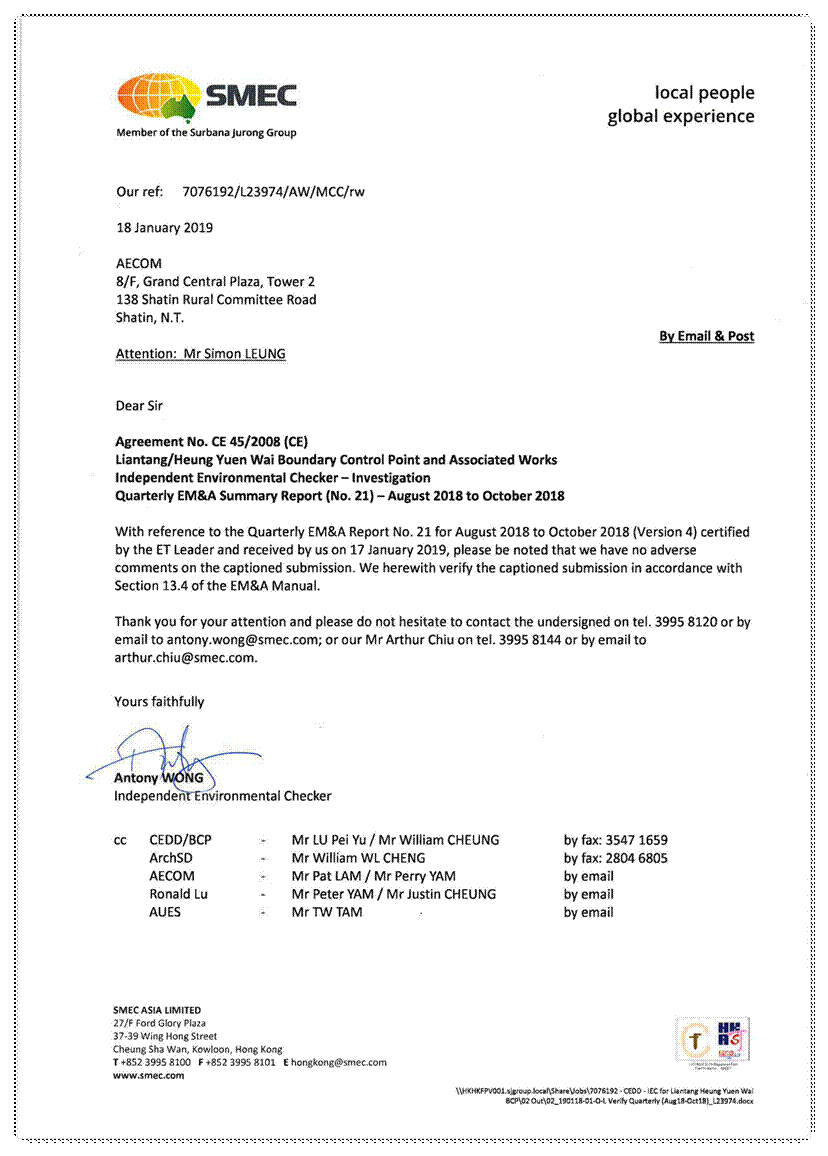

site.
