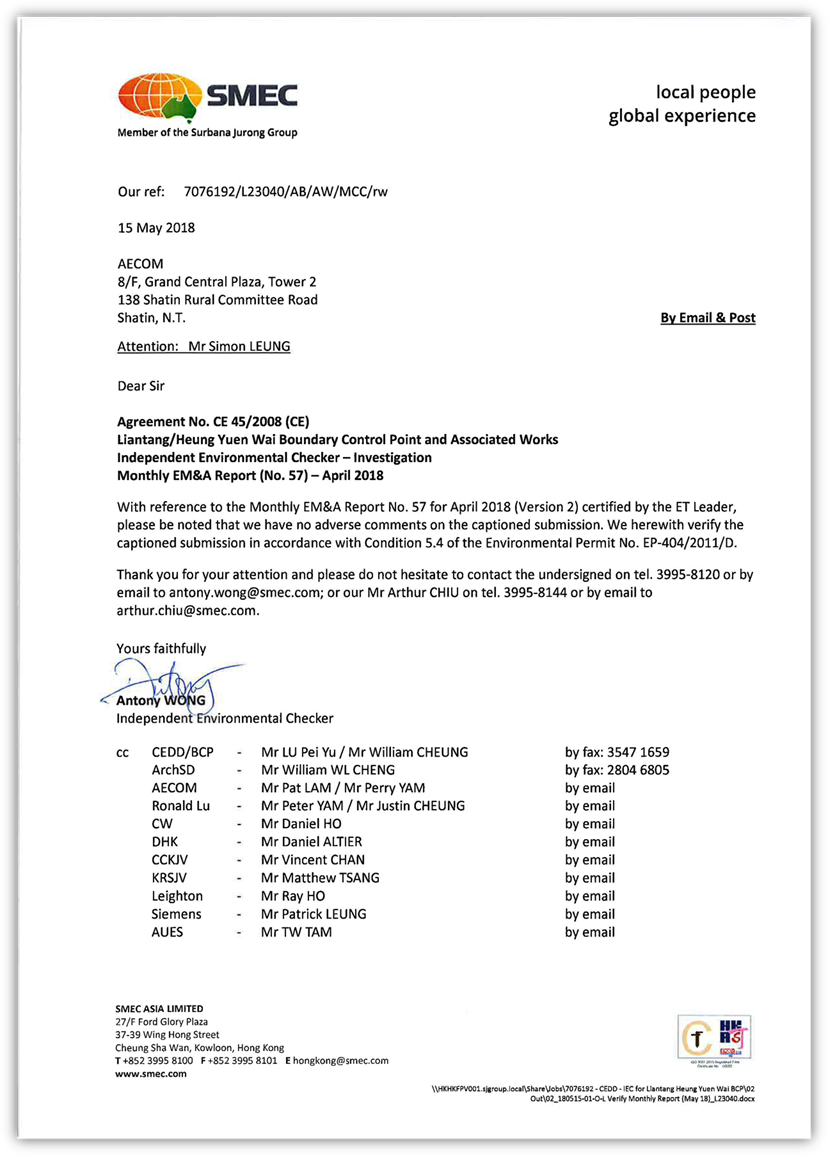

Job No.: TCS00694/13 |
|
|
||
|
|
|
|
|
||
|
|
Agreement No. CE 45/2008
(CE) Liantang/Heung Yuen Wai Boundary Control Point
and Associated Works |
|
|
||
|
|
|
|
|
||
|
|
Monthly Environmental Monitoring and Audit Report
(No.57) ¡V April 2018 |
|
|
||
|
|
Prepared For |
|
|
||
|
|
Civil Engineering and Development Department (CEDD) |
|
|
||
Date |
Reference No. |
Prepared By |
Certified By |
14 May 2018 |
TCS00694/13/600/R1546v2 |
|
|
Nicola Hon (Environmental Consultant) |
Tam Tak Wing (Environmental Team Leader) |
Version |
Date |
Remarks |
1 |
10 May 2018 |
First
Submission |
2 |
14 May 2018 |
Amended according to the IEC¡¦s comments on 10 May
2018 |
|
|
|
executive summary
ES01
This is the 57th monthly EM&A
report presenting the monitoring results and inspection findings for the
reporting period from 1 to 30 April 2018 (hereinafter ¡¥the
Reporting Period¡¦).
Environmental Monitoring
and Audit Activities
ES02
To facilitate the project management and
implementation, Liantang/Heung Yuen Wai
Boundary Control Point and Associated Works of the Project is
divided to seven CEDD contracts including Contract 2 (CV/2012/08), Contract 3 (CV/2012/09), Contract 4 (NE/2014/02), Contract 5 (CV/2013/03), Contract
6 (CV/2013/08) and Contract 7 (NE/2014/03) and an ArshSD
contract (Contract SS C505).
ES03
In the Reporting Period, the major
construction works under Liantang/Heung
Yuen Wai Boundary Control Point and Associated Works of the Project
included Contract 2, Contract 3, Contract 4, Contract
6, Contract 7 and Contract SS C505.
Environmental monitoring activities under the EM&A programme in the
Reporting Period are summarized in the following table.
Environmental Aspect |
Environmental Monitoring Parameters /
Inspection |
Reporting Period |
|
Number of Monitoring Locations to undertake |
Total Occasions |
||
Air Quality |
1-hour
TSP |
9 |
135 |
24-hour
TSP |
9 |
44 (^) |
|
Construction Noise |
Leq(30min) Daytime |
10 |
40 |
Water Quality |
Water in-situ measurement and/or sampling |
WM1
& WM1-C |
13 Scheduled & 0 extra |
WM2A(a)
& WM2A-Cx |
13 Scheduled & 0 extra |
||
WM2B
& WM2B-C |
13 Scheduled & 0 extra (*) |
||
WM3x
&WM3-C |
13 Scheduled & 0 extra |
||
WM4,
WM4-CA &WM4-CB |
13 Scheduled & 2 extra |
||
Ecology |
Woodland
compensation i)
General Health condition of planted species ii) Survival
of planted species |
9
Quadrats and transect |
0 |
Joint Site Inspection / Audit |
IEC, ET,
the Contractor and RE joint site Environmental Inspection and Auditing |
Contract
2 |
4 |
Contract
3 |
4 |
||
Contract
4 |
4 |
||
Contract
6 |
4 |
||
Contract
7 |
4 |
||
Contract
SS C505 (#) |
4 |
Remark:
(#) IEC only joined one (1) event of site inspection for Contract SS
C505.
(*) In
the whole Reporting Period, water sampling was unable to carry out at WM2B and WM2B-C due to shallow
water (water depth under 150mm)
(^) 24-hour TSP monitoring at AM1b has been temporary suspended since 27
April 2018 as rented land was demolished
and returned to the landlord. Alterative
location to replaced AM1b is being seeking by ET for IEC and EPD approval.
Action and Limit (A/L) Levels exceedance
ES04
In the Reporting Period, no air quality and construction noise exceedance and valid noise
complaint was
recorded. For water quality
monitoring, a total of three (3) Action/Limit Level
exceedances were recorded under the Project. The summary of exceedance in the
Reporting Period is shown below.
Environmental Aspect |
Monitoring
Parameters |
Action Level |
Limit Level |
Event
& Action |
|||
NOE
Issued |
Investigation
Result |
Project
related exceedance |
Corrective
Actions |
||||
Air Quality |
1-hour TSP |
0 |
0 |
0 |
-- |
-- |
-- |
24-hour TSP |
0 |
0 |
0 |
-- |
-- |
-- |
|
Construction Noise |
Leq(30min) Daytime |
0 |
0 |
0 |
-- |
-- |
-- |
Water Quality |
DO |
0 |
0 |
0 |
- |
-- |
-- |
Turbidity |
0 |
2 |
2 |
-
All exceedances
were not project related. |
0 |
The Contractor should fully implement water quality mitigation measure. |
|
SS |
0 |
1 |
1 |
0 |
ES05
Investigation
Report for all water quality exceedances was completed by ET. Investigation results revealed that the
Contractor had properly implemented water quality mitigation measures such as
well-maintained the wastewater treatment facility and covered the expose area
with impervious sheet. It was concluded that the exceedances were related to the
unknown source of muddy water contributed from outside the project area and not
caused by the works under the Project. Nevertheless, the Contractor was reminded
to fully implement the water
quality mitigation measure
throughout the constriction phase as far as practicable.
Environmental
Complaint
ES06
In this Reporting
Period, two (2) documented environmental complaints were received under the
EM&A programme regarding to the water quality issue. The investigation report
for the complaint for Contract 2 regarding the foamy discharge was under
reviewed by IEC while the other complaint for Contract SS C505 is underway by
ET.
Notification of
Summons and Successful Prosecutions
ES07
No environmental summons
and prosecutions were recorded in the Reporting Period.
Reporting Change
ES08
No reporting changes
were made in the Reporting Period.
ES09
In this Reporting Period, joint site inspection to evaluate the site
environmental performance at Contract 2 has been carried out by
the RE, IEC, ET and the Contractor on 6, 13, 20 and 27 April
2018.
No non-compliance was noted during the site inspection.
ES10
In the Reporting Period, joint site
inspection to evaluate the site environmental performance at Contract
3 has been carried out by the RE, IEC, ET and the Contractor on 4, 12, 18 and 26 April 2018. No non-compliance was noted during the site
inspection.
ES11
In the Reporting Period, joint site
inspection to evaluate
the site environmental performance at Contract 4 has been
carried out by the RE, IEC, ET and
the Contractor on 6, 13, 16 and 27 April
2018. No non-compliance was noted.
