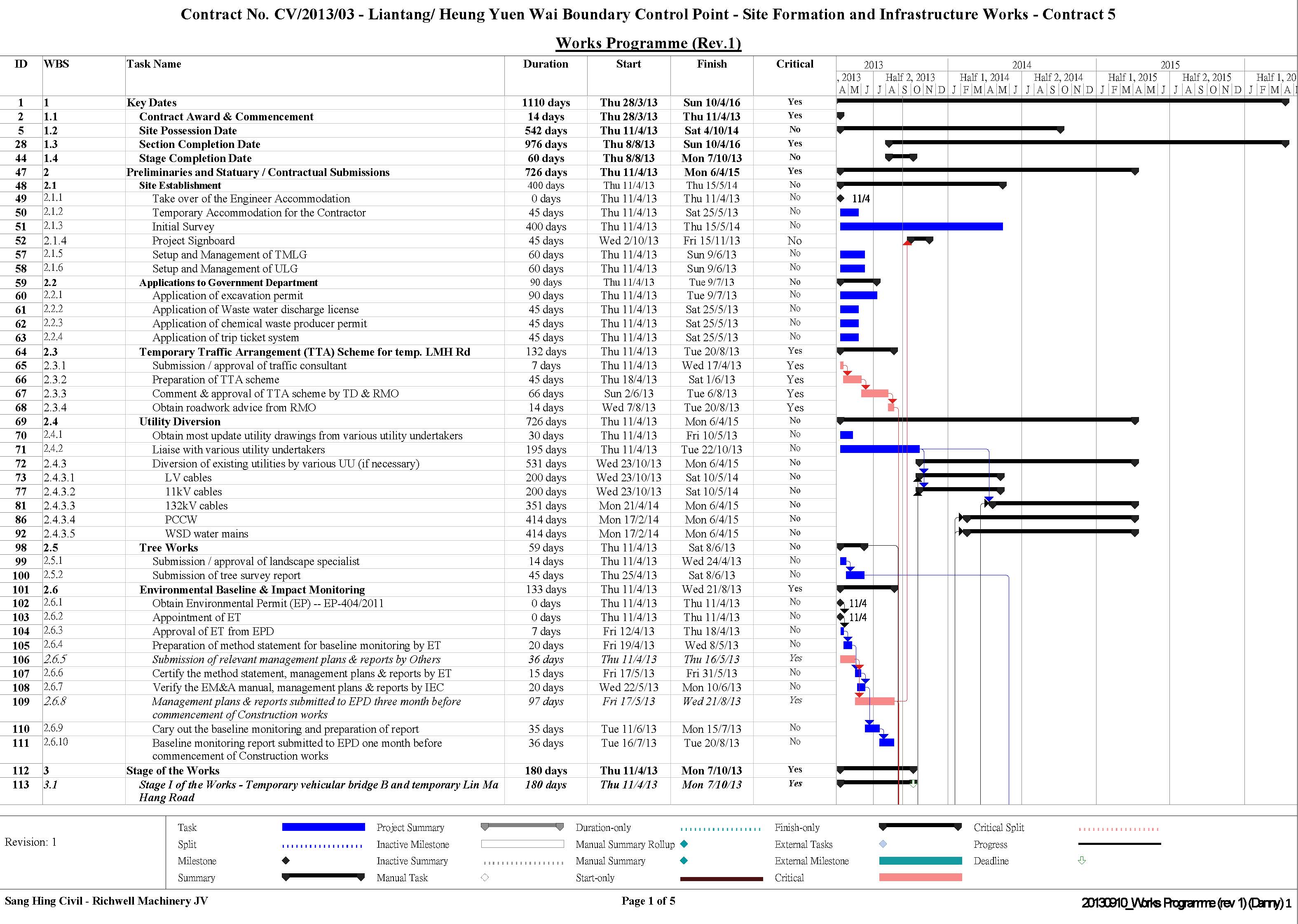

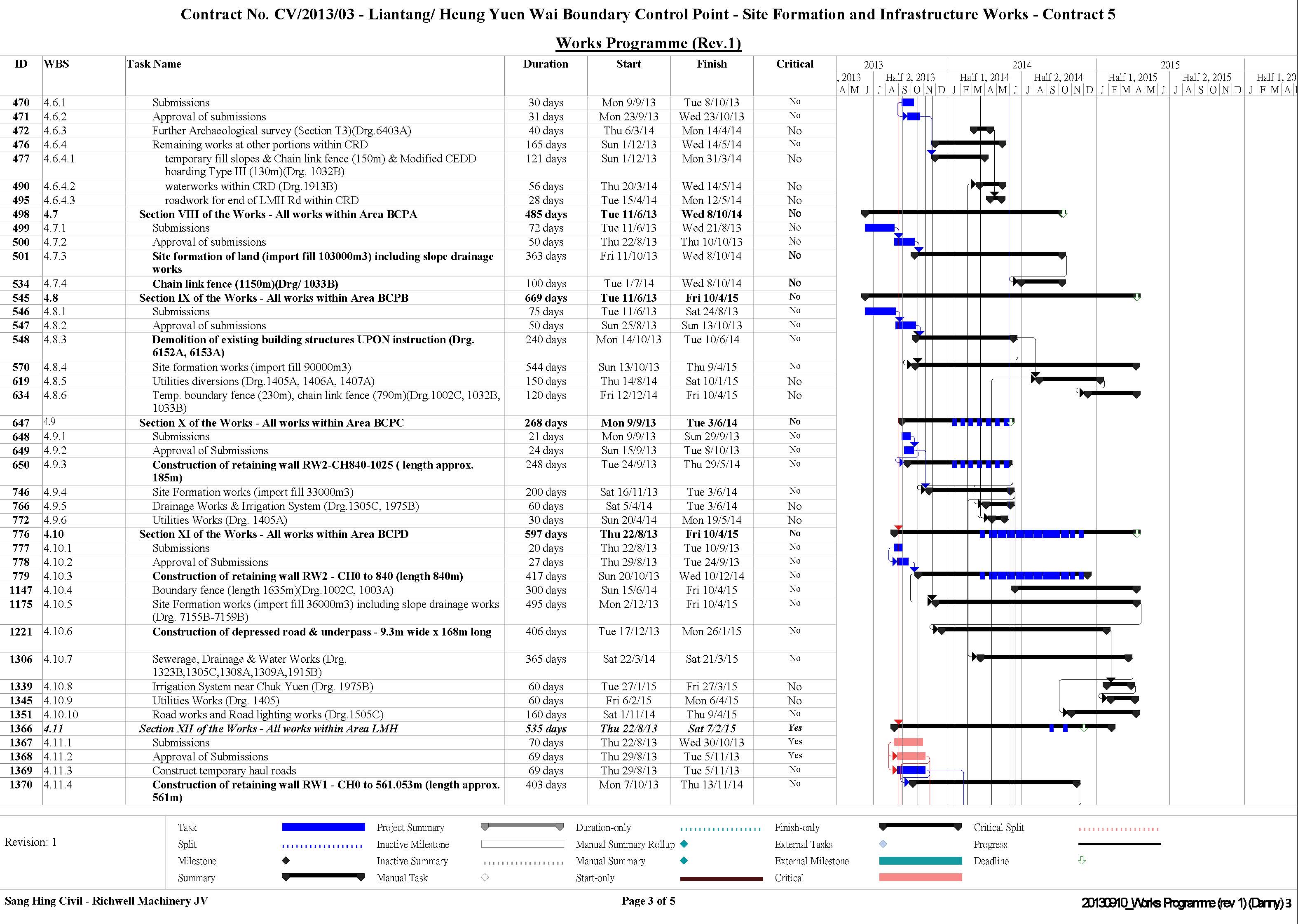

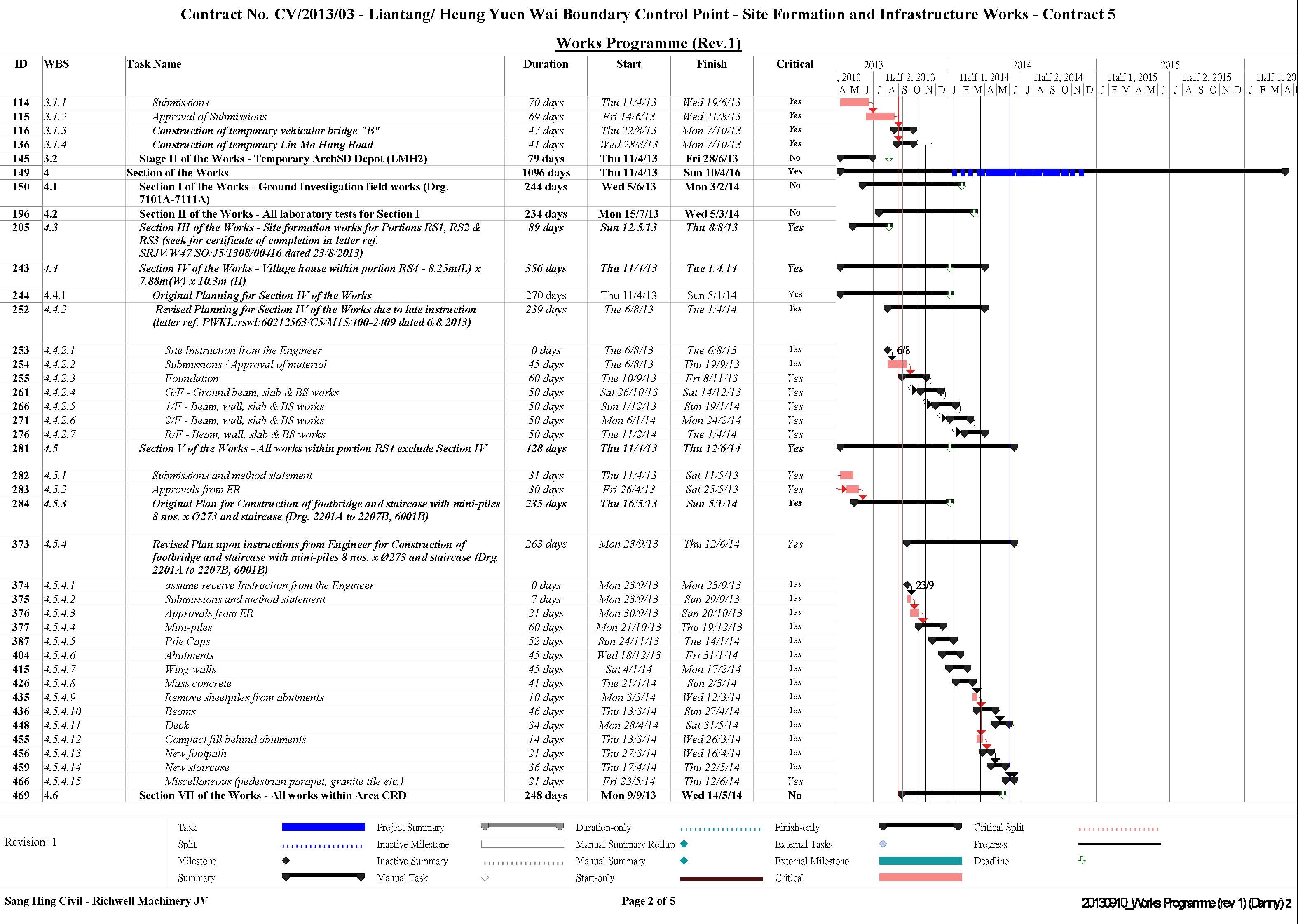

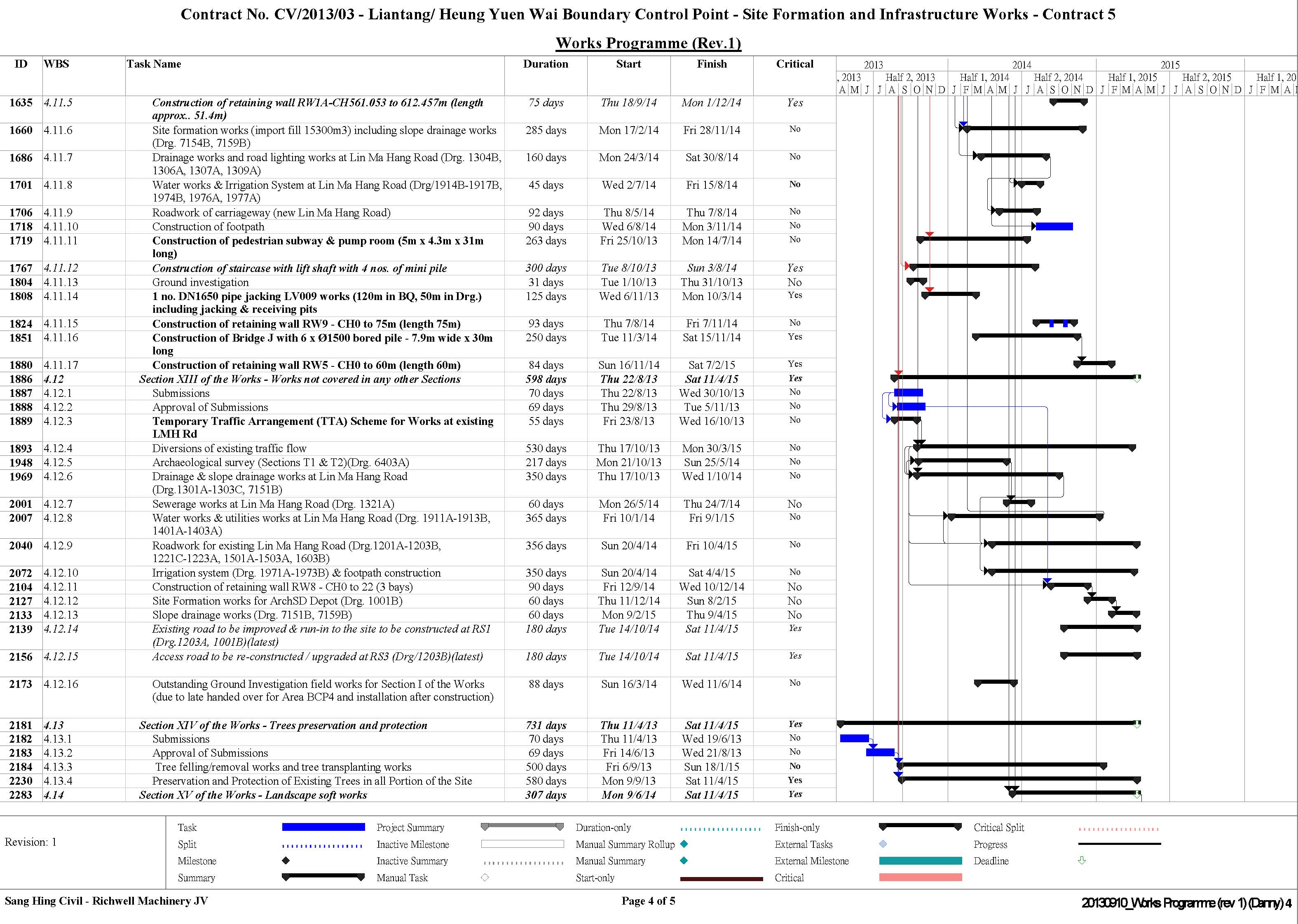

Contract No. CV/2013/03 - Liantang/ Heung Yuen Wai Boundary Control Point - Site Formation and Infrastructure Works - Contract 5 Works Programme (Rev.1)
ID WBS Task Name Duration Start Finish Critical 2013 2014 2015
A M J , 2013 1 J A S O N D Half 2, 2013 J F M A M J Half 1, 2014 J A S O N D Half 2, 2014 J F M A M J Half 1, 2015 J A S O N D Half 2, 2015 J F M A M Half 1, 201
2284 4.14.1 Landscape Soft works in all Portions of the Site (including transplant trees to permanent locations) 307 days Mon 9/6/14 Sat 11/4/15 Yes
2285 4.15 Section XVI of the Works -Establishment works for landscape soft works 365 days Sun 12/4/15 Sun 10/4/16 Yes
2286 4.15.1 Establishment works for all Portions of the Site 365 days Sun 12/4/15 Sun 10/4/16 Yes
Revision: 1 Task Split Milestone Summary Project Summary Inactive Milestone Inactive Summary Manual Task Duration-only Manual Summary Rollup Manual Summary Start-only Finish-only External Tasks External Milestone Critical Critical Split Progress Deadline
Sang Hing Civil -Richwell Machinery JV Page 5 of 5 20130910_Works Programme (rev 1) (Danny) 5
